Part 2 — Frequently Asked Questions: Large Load Interconnection

An electric grid must remain in continuous balance — generation onto the grid must equal consumption from it at every instant. PJM achieves this balance, and prices it, through a layered market architecture. Each layer operates on a different time horizon, and each one touches project economics differently.

Substation bus configurations cost and reliability comparison

Substation Primary Design: A Complete Guide for Electrical Engineers

PJM interconnection rulebook guide by Keentel Engineering
A calendar icon featuring a square outline, a top binding, and a grid of dots representing days. D

Jul 17, 2026 | Blog

1. What Is Substation Primary Design?

Substation primary design is the discipline responsible for the physical, high-voltage side of a substation:  selecting, sizing, and arranging the heavy electrical equipment that actually carries power. It answers the  questions that determine whether a substation is safe, reliable, constructible, and economical — which  transformer, which breakers, what bus configuration, how much space between phases, how the  ground grid dissipates fault current, and how the station survives lightning, wind, ice, and seismic events.


Every substation exists for one fundamental reason: voltage transformation and switching. Power is  generated at medium voltage, stepped up for efficient long-distance transmission, and stepped down in  stages for subtransmission, distribution, and finally utilization. Substations are the nodes where those  transitions happen, and where utilities gain the ability to isolate equipment, reroute power, and protect  the grid during faults. Primary design defines the hardware that makes all of that physically possible.


The primary design engineer owns the general arrangement (plan and elevation views), major  equipment specifications, bus and insulator sizing, structural loading, grounding grid, lightning shielding,  insulation coordination, and the clearances that keep energized parts safely separated from each other,  from ground, and from people. Done well, primary design produces a station that passes every safety  study, fits the site, accommodates future expansion, and minimizes installed cost. Done poorly, it  produces change orders, failed studies, schedule slips, and — in the worst case — real safety hazards.


Keentel Insight


Primary design decisions are leverage decisions. A bus configuration chosen in week one drives breaker  count, structure count, foundation quantities, protection schemes, and O&M flexibility for the next 40+  years. The cheapest time to optimize a substation is before the first drawing is issued.


2. Primary vs. Secondary Design: Brawn and Brains

A complete substation engineering package has two halves. Primary design is the “brawn” — the high voltage hardware and the mechanical and electrical physics that govern it. Secondary design is the  “brains” — the protective relays, control circuits, SCADA, communications, and the AC/DC auxiliary  systems that tell the primary equipment when to operate and keep the station alive during outages. The  two disciplines are deeply interdependent: the primary one-line determines what must be protected;  instrument transformer selection feeds relay settings; the DC battery must be sized to trip the very  breakers the primary engineer selected.

Scope HV equipment, bus, structures, layout Relays, controls, SCADA, communications
Key drawings One-line, general arrangement, elevations, grounding plan, lightning shielding overlay Three-lines, schematics, wiring diagrams, panel layouts, points lists
Governing physics IEEE 80, IEEE 605, IEEE 998, IEEE 1427, ANSI C29, NESC, ANSI C84.1 IEEE C37 series, IEEE 485, IEEE 1818, IEC 61850, DNP3, NERC PRC/CIP
Typical equipment Transformers, breakers, switches, bus, arresters, CTs/CCVTs, steel structures Relay panels, RTU/RTAC, batteries & chargers, HMI, network gear
Capacity Market (RPM) Three years forward (tariff design) Base Residual Auction plus incremental auctions procure committed capacity by location, with penalties for non-performance
Failure consequence Flashover, structural failure, unsafe touch/step voltage Misoperation, failure to trip, loss of visibility

This guide focuses on the primary side, but it flags the interface points — instrument transformers,  station service, and DC tripping capacity — where primary decisions constrain the secondary package.  Coordinating both under one engineering roof eliminates the most common source of substation  rework: primary and secondary packages that were developed in isolation and don’t reconcile.


3. U.S. Voltage Classes Every Substation Engineer Must  Know

U.S. substations are designed around standardized nominal system voltages (ANSI C84.1 for systems up  to 230 kV and companion practice for EHV). Each nominal voltage carries a maximum system voltage  that equipment must withstand continuously, plus standardized insulation levels (BIL). Primary design  starts by locating the project on this ladder, because voltage class drives clearances, insulator selection,  bus sizing, structure heights, and cost.

Low voltage (LV) 0.120/0.240, 0.208, 0.480, 0.600 ≤ 0.635 Station service, auxiliary power, control buildings
Medium voltage / distribution 2.4, 4.16, 4.8, 6.9, 12.47, 13.2, 13.8, 20.8, 22.9, 24.94, 27.6, 34.5 up to 36.5 Distribution feeders, collector systems for solar/wind/BESS, industrial plants
Subtransmission 34.5, 46, 69 36.5 / 48.3 / 72.5 Regional delivery, large industrial and municipal supply
High voltage (HV) 115, 138, 161, 230 121 / 145 / 169 / 242 Bulk transmission, generator interconnection, large load service
Extra-high voltage (EHV) 345, 500, 765 362 / 550 / 800 Backbone bulk power transfer across regions
Ultra-high voltage (UHV) 1,100 (studied) 1,200 Not in commercial U.S. service; research and long-term

A few practical notes. Distribution substations most commonly transform 69–138 kV down to 12.47,  13.2, 13.8, 24.94, or 34.5 kV. Renewable collector substations typically step 34.5 kV collector voltage up  to 115, 138, 230, or 345 kV at the point of interconnection. The 161 kV class is regionally concentrated;  115 vs. 138 kV prevalence also varies by utility footprint. EHV work at 345/500/765 kV introduces  additional considerations — corona and audible noise, switching surge control, shield wire and  insulation coordination refinements — that materially change the primary design approach.

Keentel Insight


Design to maximum system voltage, not nominal. A “138 kV” substation is really a 145 kV substation for  insulation, clearance, and arrester duty purposes. Treating nominal voltage as the design voltage is one  of the most common errors we correct in third-party design reviews.


4. Bus Configurations: Reliability vs. Cost

The bus configuration is the single most consequential primary design decision. It sets breaker count,  physical footprint, operating flexibility, and the outage consequences of any single failure. The five  arrangements below cover the vast majority of U.S. practice.


4.1 Single Breaker, Single Bus


The simplest arrangement: one common bus, one breaker per circuit. It is inexpensive and compact, but  a bus fault or breaker maintenance takes the entire station out of service. Widely used at distribution  voltage; limited use at HV except for small or radial stations. Adding a bus sectionalizing breaker  improves flexibility at modest added cost.


4.2 Main and Transfer Bus


A normally de-energized transfer bus parallels the main bus, allowing any one breaker to be bypassed  for maintenance while its circuit stays in service through a transfer scheme. Common in outdoor  distribution and legacy subtransmission stations. Protection complexity increases because relaying must  follow the transferred circuit.


4.3 Ring Bus


Breakers are connected in a closed loop with circuits tapped between breakers; there is no bus section  per se. Every circuit is served by two breakers, so any single breaker can be maintained without a circuit  outage, and a bus-section fault removes only the adjacent elements. The ring is a popular HV choice for  four-to-six-terminal stations and converts naturally into a breaker-and-a-half arrangement as the station  grows — which is why many utilities specify a ring “with B&AH expansion provisions” on day one.


4.4 Breaker-and-a-Half


Two main buses with three breakers per two circuits (“a breaker and a half” per circuit). Any breaker or  either bus can be removed from service without dropping a circuit, and the arrangement tolerates  certain double contingencies. It is the workhorse of U.S. EHV and critical HV stations, generator  interconnections, and large load-serving hubs.


4.5 Double Breaker, Double Bus


Two breakers and two buses per circuit; all breakers normally closed. Maximum operating flexibility and  security — and maximum cost. Reserved for the most critical nodes: major generating plant switchyards  and system-critical EHV hubs.


4.6 Relative Installed Cost

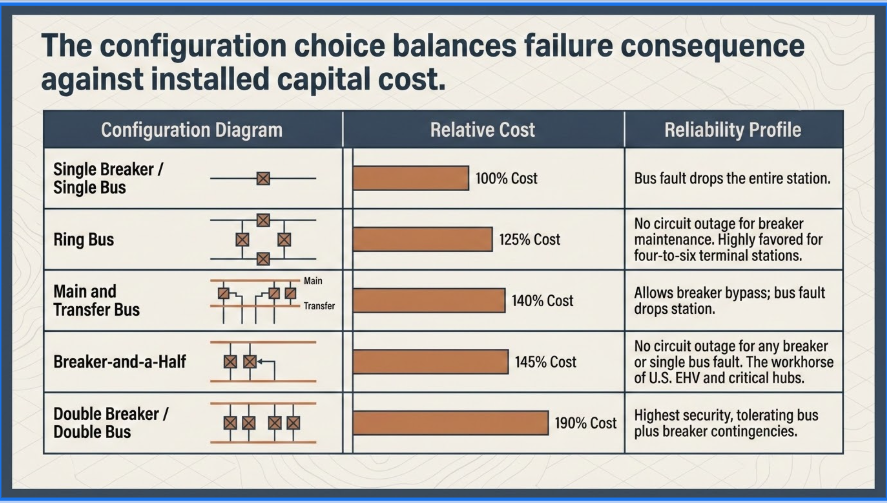

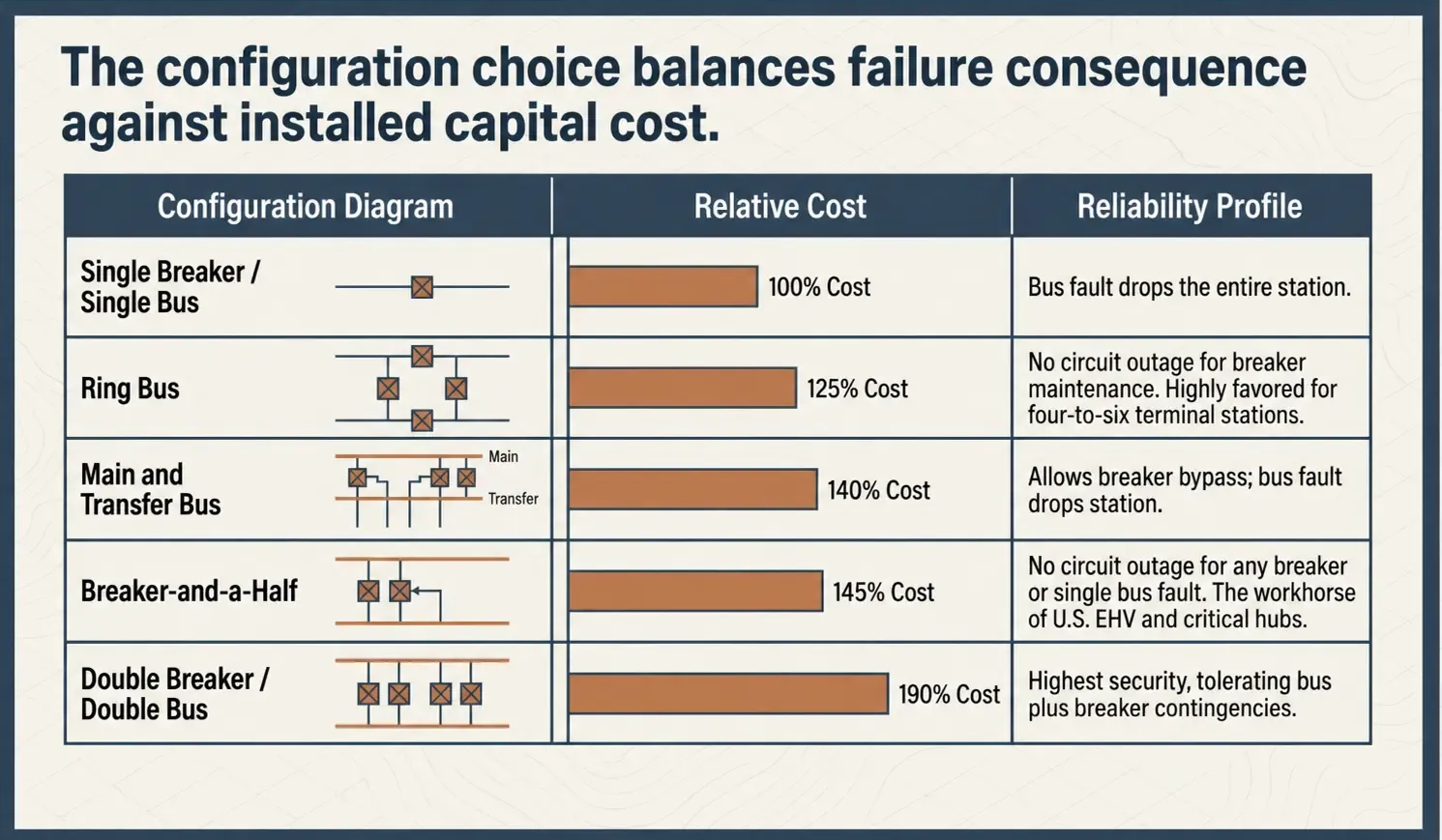

Industry benchmarking places the arrangements on a consistent relative cost scale (single breaker/single  bus = 100%):

Single breaker – single bus 100% (120% with sectionalizing breaker) Bus fault or breaker work drops the whole station
Ring bus 125% No circuit outage for breaker maintenance; degraded ring during work
Main and transfer bus 140% Breaker bypass without circuit outage; bus fault drops station
Breaker-and-a-half 145% No circuit outage for any breaker or single bus outage
Double breaker – double bus 190% Highest security; tolerates bus + breaker contingencies

The right choice balances the criticality of the connected circuits against capital budget and site area. For  a typical HV interconnection with four terminals, a ring bus captures most of the reliability benefit at a  fraction of the breaker-and-a-half cost — provided the layout genuinely reserves space, foundations,  and bus geometry for the future conversion.


5. AIS vs. GIS: Choosing the Insulation Medium

Air-insulated substations (AIS) use atmospheric air as the primary insulation between phases and to  ground, which makes clearances — and therefore land area — the dominant layout driver. Gas-insulated  switchgear (GIS) encloses bus, breakers, and switches in grounded metal enclosures filled with an  insulating gas, compressing an entire switchyard into a fraction of the footprint, indoors or out.

Footprint Large; driven by phase spacing and clearances Roughly 10–25% of equivalent AIS area
Capital cost Lower equipment cost Higher equipment cost; often offset by land and civil savings
Environment Exposed to contamination, wildlife, weather Sealed; suited to coastal, desert, urban, and seismic sites
Maintenance More frequent; components individually accessible Low frequency; specialized skills and OEM support required
Expansion / repair Straightforward bay additions Requires gas handling and longer lead planning
Typical use Rural and suburban HV/EHV yards with available land Urban infill, data center campuses, constrained or harsh sites

Hybrid solutions (mixed-technology switchgear, or GIS at one voltage level and AIS at another) are  increasingly common where land is tight but budgets do not support full GIS. The decision should be  made early — it changes civil scope, structural scope, and the entire general arrangement.


6. The Core Primary Design Tasks

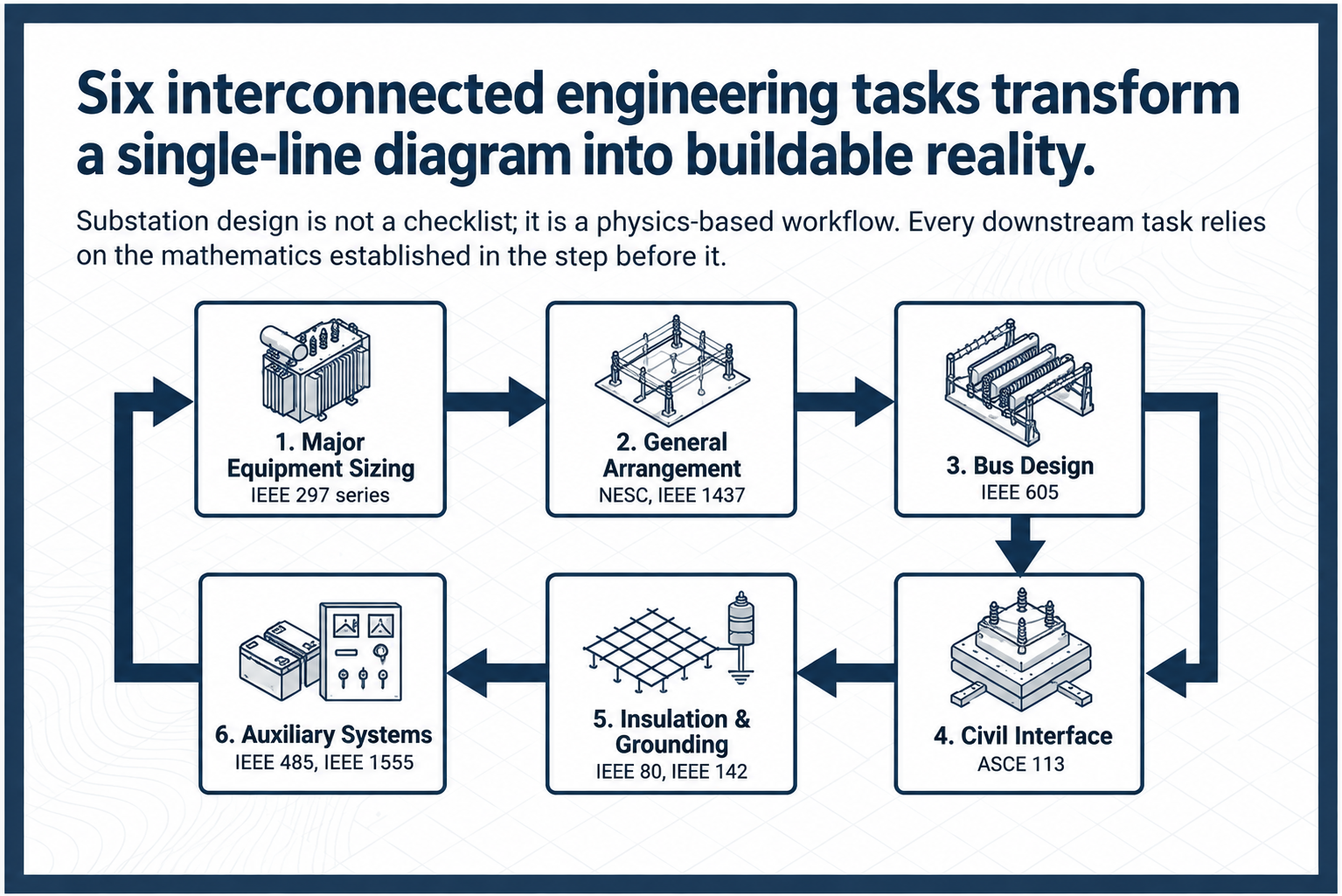

What follows is the working sequence Keentel applies on substation primary design engagements, with  the governing standards and representative calculations an electrical engineer should be able to  reproduce.

6.1 Major Equipment Sizing


Equipment sizing begins with the power transformer, because everything else — breaker ratings, bus  ampacity, fault duty, foundation loads — cascades from it.


Transformer MVA


For a three-phase transformer, apparent power follows S = √3 × VL × IL. As a representative example: a  115 kV circuit expected to carry 600 A requires √3 × 115 kV × 600 A ≈ 119.5 MVA of capacity. Modern  power transformers carry staged nameplate ratings — for example 95/127/158 MVA — corresponding  to self-cooled operation (ONAN) and one or two stages of forced-air cooling (ONAF). The base (ONAN)  rating anchors impedance and fault calculations; the top forced-cooled rating defines maximum  continuous loading and drives the ratings of everything downstream.


Circuit Breaker and Switch Continuous Ratings


Breakers and disconnect switches are selected for the maximum load they must carry with margin. A  common utility practice applies a 125% factor to the maximum transformer rating: I = 1.25 × S / (√3 ×



Interrupting Capacity (kAIC)


Every breaker must interrupt the maximum fault current at its location. A first-pass screen uses the  infinite-bus approximation through the transformer impedance: ISC = Sbase / (√3 × VL × Z%). For a 95 MVA  base transformer at 10% impedance feeding a 34.5 kV secondary: 95 / (√3 × 34.5 × 0.10) ≈ 15.9 kA — specify the next standard interrupting class (25 kA) with margin for system contribution and future  growth. The infinite-bus screen is conservative on the transformer contribution but ignores source  impedance and motor/inverter contribution; a proper short-circuit study (which Keentel performs in  every engagement) supersedes it before equipment is purchased.


Instrument Transformers


 Current transformers are sized with the primary winding at or above full load current and a 5 A  secondary in U.S. practice (typical ratios 600/5, 1200/5, 2000/5, 3000/5), then verified with the  protection engineer for burden, accuracy class, and saturation under maximum fault. Potential  transformers and CCVTs use line-to-ground primary ratings with a 115 V-class secondary; at HV, CCVTs

dominate for economy and double as carrier coupling points. Ratio and BIL selections must match the  system voltage class table in Section 3.


Surge Arresters


Arrester selection starts from maximum continuous operating voltage (MCOV): the arrester must  continuously withstand the maximum line-to-ground voltage for the system grounding configuration.  Effectively grounded (multi-grounded) systems permit lower MCOV values than impedance-grounded,  ungrounded, or delta systems, where temporary overvoltages during ground faults approach line-to-line  voltage. Station-class arresters located at line entrances and at the transformer are the first line of the  insulation coordination strategy in Section 6.5.


6.2 General Arrangement, Phase Spacing, and Clearances


The general arrangement (GA) is the master document of primary design: a dimensioned plan view  locating every major piece of equipment, the control building, bus runs, structures, and the perimeter  fence, with elevation sections cut through each significant axis. Clearance requirements govern the  geometry: phase-to-phase and phase-to-ground spacing per voltage class, safety working clearances,  and equipment access. The governing references are the NESC, IEEE 1427 (electrical clearances in  substations), ANSI C29 insulator standards, NFPA 70E for working spaces, and — critically — the owner’s  own standards, which frequently exceed code minimums. Representative HV practice: on the order of 8- foot phase centers at 138 kV rigid bus versus 6-foot at 69 kV, with clearances re-verified against  elevation changes, equipment bushing geometry, and conductor movement.

Good GA practice that separates a professional layout from a code-minimum one: centralize the control  building to shorten every cable run while honoring minimum standoff from the transformer (a common  utility rule is 60 feet or a fire barrier, so a transformer failure cannot disable station controls); orient  equipment terminal boxes toward the cable trench; place dead-end (termination) structures near



6.3 Bus Design: Rigid, Strain, and Short-Circuit Forces


Substations use two bus constructions. Rigid bus — typically schedule aluminum pipe on station post  insulators (representative practice: 4-inch Schedule 80 at 138 kV, 3-inch Schedule 40 at 69 kV) — offers  clean phase spacing, low sag, and easy equipment connections. Strain bus — flexible conductor strung  between dead-end structures — spans long distances economically and connects termination towers  into the yard. Most stations combine both.


Bus and insulator sizing per IEEE 605 must satisfy three simultaneous demands: ampacity (continuous  current with allowable temperature rise), short-circuit mechanical forces (electromagnetic forces  between phases during faults scale with the square of current and inversely with spacing, loading both  the bus and the insulator cantilever ratings), and structural loading (wind, ice, and where applicable  seismic per the owner’s criteria and ASCE guidance). Span lengths, fitting selection, and aeolian vibration  dampers fall out of the same calculation set. Undersized insulator cantilever strength under fault forces  is a classic review finding.


6.4 Structural and Civil Interface


Primary design defines the loading trees that structural engineers use to design steel and foundations:  dead-end structure tensions from incoming spans, equipment weights and operating loads, bus short circuit reactions, and wind/ice/seismic combinations. H-frame termination structures deserve early  attention — they carry full line tension as dead-ends, need substantial foundations, and their placement  fixes the line approach geometry for the life of the station. Oil containment for the transformer,  drainage, roads for transformer delivery (a 158 MVA unit is a superload), and fence grounding  integration complete the civil interface.


6.5 Insulation Coordination


Insulation coordination matches the withstand strength of every insulation element — bushings,  insulators, air gaps, transformer windings — against the overvoltage stresses the station will see:  lightning surges, switching surges (dominant at EHV), and temporary overvoltages. The toolkit:  standardized BIL selection per voltage class, station-class surge arresters at line entrances and  transformer terminals positioned within protective distance limits, shield wires and masts to intercept  direct strokes (Section 6.7), and at EHV, closing resistors or controlled switching. The deliverable is a  coordinated set of BILs and arrester ratings demonstrating protective margins per IEEE C62 practice.



6.6 Grounding Grid Design (IEEE 80)


The grounding system is a life-safety system. During a ground fault, thousands of amperes flow into the  earth through the grid, elevating the station ground potential. IEEE 80 defines the two human exposure  limits the design must satisfy: touch voltage (hand on grounded structure, feet on soil) and step voltage  (one-meter stride on the surface). The workflow:

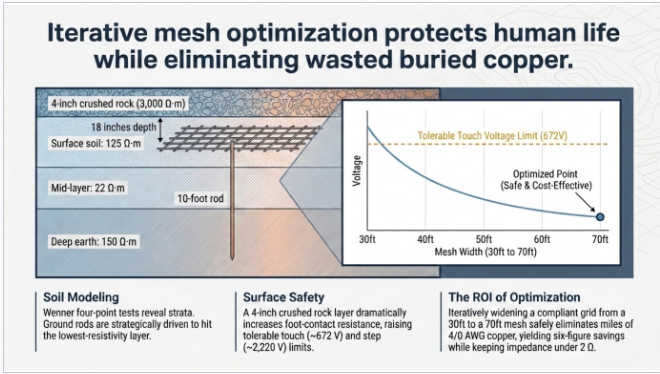

• Soil resistivity measurement. The Wenner four-point method — four equally spaced electrodes,  outer pair injecting current, inner pair measuring voltage — produces apparent resistivity versus  probe spacing. Representative sites show strong layering: e.g., ~125 Ω·m near the surface dropping  to ~22 Ω·m in a mid-layer, rising again at depth.


• Soil modeling. Field data is fit to a multi-layer soil model in specialized software. The layer  structure tells the designer which stratum should collect fault current — grid depth and ground rod  length are chosen to reach the low-resistivity layer (e.g., grid at 18 inches with 10-foot rods  penetrating a conductive second layer).


• Conductor sizing. Minimum conductor area follows the IEEE 80 fusing equation from maximum  grid fault current and clearing time. A representative case — 21 kA single-phase-to-ground, 0.5 s  clearing, soft-drawn copper — yields roughly 104 kcmil minimum; 4/0 AWG stranded copper (211.6  kcmil) is the common conservative selection.


• Safety limits. Tolerable touch and step voltages are computed from body mass criteria, fault  duration, and the surface layer. A 4-inch crushed-rock layer at ~3,000 Ω·m dramatically raises  tolerable limits (representative values: ~672 V touch, ~2,220 V step) by increasing foot contact  resistance.


• Iterative optimization. The grid is modeled, checked against limits, and the mesh spacing widened  (or tightened) iteratively. Starting from a conservative 30-foot mesh and relaxing in 10-foot steps  until the first failure brackets the optimum — a representative design passed at 70-foot spacing  and failed at 80 — converts directly into copper savings without sacrificing safety.


• System checks. The grid extends about 3 feet beyond the fence (which is bonded), every structure  and equipment tank ties to the grid, and total grid impedance is verified — well under the common  2 Ω industry threshold for transmission stations (representative result: 0.19 Ω).



Keentel Insight


 Optimization is where grounding engagements pay for themselves. Widening a compliant grid from 30- foot to 70-foot mesh across a 400 × 400-foot yard removes miles of buried copper and hundreds of  exothermic connections from the bill of materials — routinely a six-figure construction saving on a study  that costs a small fraction of that.


6.7 Lightning Shielding (IEEE 998)


Direct strokes to unshielded equipment are among the few events that can destroy a  transformer outright. IEEE 998 provides the design methods — the electrogeometric model (EGM) and  the empirical curves method — for placing shield wires and lightning masts so every critical component  sits inside a zone of protection. In the empirical-curves workflow, the designer computes the ratio of  protected equipment height (d) to mast height (h), enters the exposure curve (typically the 0.1% curve  for station work), reads the x/h ratio, and solves for the protective radius x of each mast. A second  family of curves gives s/h — the maximum separation at which adjacent zones of protection reinforce



6.8 The Auxiliary System Interface



Two auxiliary systems sit at the boundary between primary and secondary design, and the primary  engineer must leave room — physically and electrically — for both. The 125 V DC system (station  battery and charger, sized per IEEE 485) must trip and close the breakers the primary engineer selected:  trip coils, close coils, and spring-charging motors define the momentary duty; relays, annunciators, and  DC lighting define the continuous duty. Correct practice sizes the battery against a worst-case fault  scenario duty cycle — a first-minute momentary block, a continuous block, and an end-of-duty  momentary block — not a naive sum of every load. The AC station service system (per IEEE 1818, the  industry guide for low-voltage auxiliary systems) supplies transformer cooling, breaker and CT/PT  heaters, HVAC, lighting, receptacles, and battery charging, tabulated with load and demand factors.  Station service transformer sizing, redundancy philosophy, and control building space for panels and  batteries are all reserved during primary layout.


7. The Design Milestone Progression: 30% → 60% → 90%  → IFC

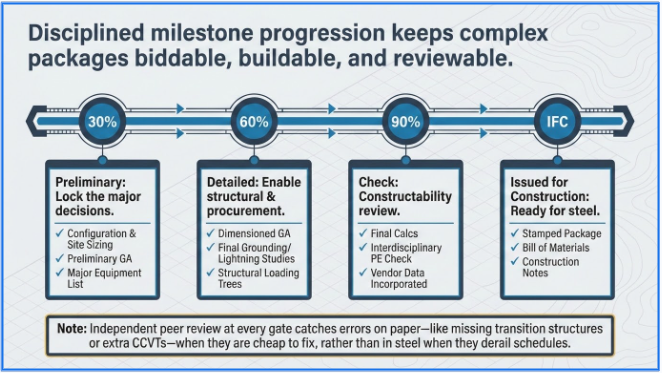

U.S. substation projects advance through standardized review gates. Each gate has an expected content  level, and disciplined milestone management is what keeps a substation package reviewable, biddable,  and buildable.

30% (Preliminary) One-line, preliminary GA plan, equipment list, bus configuration decision, site sizing, preliminary grounding & lightning concepts Lock the big decisions: configuration, footprint, major equipment
60% (Detailed) Dimensioned GA and elevations, grounding study & plan, lightning shielding study, bus calcs, structural loading trees, equipment specifications issued Enable long-lead procurement and structural/civil design
90% (Check) All drawings essentially complete, calculations finalized, vendor data incorporated, interdisciplinary check complete Constructability and owner review; only comments remain
IFC (Issued for Construction) Stamped drawing package, final calculations, bill of materials, construction notes Build it

Peer review is embedded at every gate: drafter, independent checker, and reviewing engineer, with  revision clouding so every change between milestones is visible. First drafts fail review — that is the  point of the process. Representative first-pass findings on real projects include incorrect phase spacing  carried between voltage levels, missing surge arresters at line entrances, missing bus transitionstructures between elevation levels, and extra or missing CCVTs — all inexpensive to fix on paper and  expensive to fix in steel.


8. Governing Standards Quick Reference

ANSI C84.1 Standard nominal and maximum system voltages (through 230 kV) and voltage ranges
IEEE 80 AC substation grounding — touch/step limits, conductor sizing, grid design
IEEE 81 Measurement of earth resistivity and ground impedance
IEEE 605 Rigid bus structural and electrical design, short-circuit forces
IEEE 998 Direct lightning stroke shielding of substations (EGM / empirical curves)
IEEE 1427 Electrical clearances in substations
IEEE 1818 Design of AC/DC low-voltage auxiliary systems for substations
IEEE 485 Sizing lead-acid station batteries
IEEE C57 series Power transformers — ratings, testing, loading
IEEE C37 series Circuit breakers, switchgear, and protective relaying
IEEE C62 series Surge arresters and insulation coordination application
ANSI C29.8 / C29.9 Wet-process porcelain and toughened glass insulators
NESC (ANSI C2) National Electrical Safety Code — clearances, grounding, safety rules
NFPA 70E Electrical safety in the workplace — working clearances and arc flash
ASCE 113 Substation structure design guide (loading, deflection)

9. How Keentel Engineering Assists

Keentel Engineering LLC is a U.S. power systems and grid interconnection consulting firm delivering  substation primary design as an integrated package with the studies that validate it. Our engineers hold  P.E. licensure and IEEE senior membership, and our deliverables are built to utility review standards  from the first submittal.


Full-Scope Substation Primary Design


• One-line and three-line development; bus configuration selection studies with cost/reliability  tradeoff analysis

• General arrangement plans, elevation sections, and clearance verification at every U.S. voltage  class — distribution (2.4–34.5 kV), subtransmission (34.5–69 kV), HV (115–230 kV), and EHV (345– 765 kV)

• Major equipment sizing and specification: transformers, breakers, switches, instrument  transformers, arresters

• Rigid and strain bus design with IEEE 605 ampacity and short-circuit force calculations • Structural loading trees, dead-end structure coordination, and civil interface packages


Safety and Performance Studies


• IEEE 80 grounding studies with soil modeling, touch/step analysis, and copper-optimized grid  design

• IEEE 998 lightning shielding studies with mast/shield-wire optimization

• Short-circuit, load flow, insulation coordination, cable ampacity, and arc flash studies • AC/DC auxiliary system design: IEEE 485 battery sizing, IEEE 1818 station service design


Program-Level Support


• 30/60/90/IFC milestone management with embedded QA/QC and independent checking • Owner’s engineer and third-party design review for utilities, developers, and EPCs

• Grid interconnection engineering — POI selection, interconnection studies, EMT modeling, and  NERC compliance — so the substation and its interconnection requirements are engineered  together, not sequentially


10. Conclusion

Substation primary design is where electrical physics, mechanical engineering, safety science, and  construction economics converge on a single set of drawings. The engineer who masters the sequence  — voltage class, bus configuration, equipment sizing, general arrangement, bus and structural design,  insulation coordination, grounding, and lightning shielding — controls the cost, safety, and 40-year  flexibility of the asset. The engineer who treats those tasks as isolated checklist items inherits the  change orders.


Keentel Engineering brings the full sequence under one roof, backed by the power system studies that  validate every selection. If you are planning a substation at any U.S. voltage class — or inheriting one  that needs a second set of eyes — we would welcome the conversation.


Case Study 1: Grounding and Lightning Optimization for  a 138/69 kV Renewable Interconnection Substation

Facility type Greenfield ring bus interconnection substation for utility-scale wind generation
Voltage class 138/69 kV (HV / subtransmission)
Configuration Three-breaker 138 kV ring bus, 138/69 kV power transformer, single 69 kV line exit; breaker-and-a-half expansion provisions
Keentel scope IEEE 80 grounding study and grid design, IEEE 998 lightning shielding study, physical design support

The Challenge


A renewable energy client required a new interconnection substation delivering wind generation into  the transmission system. The site was fixed at 400 × 400 feet to accommodate future expansion, and the  owner’s mandate was explicit: full IEEE 80 safety compliance and complete IEEE 998 lightning coverage  at the minimum installed cost. Layered soil conditions complicated the grounding problem — field  resistivity ranged from roughly 125 Ω·m near the surface down to the low 20s in a mid-layer before  rising again at depth — and the worst-case single-phase grid fault was established at 21 kA with 0.5- second clearing.


Keentel’s Approach


Grounding came first, because the grid boundary defines the buildable area. Wenner four-point field  data was fit to a multi-layer soil model, which showed the second stratum offering the lowest resistivity  path. The grid was therefore set 18 inches below grade with 10-foot ground rods driven to terminate  inside that conductive layer — deliberately steering fault current where the earth dissipates it best.


Conductor sizing per the IEEE 80 fusing equation returned a minimum of roughly 104 kcmil for soft drawn copper at the design fault; 4/0 stranded copper was selected for conservatism and mechanical  durability, extended 3 feet beyond the fence line with the fence bonded to the grid. Tolerable limits  were then established with a 4-inch, 3,000 Ω·m crushed rock surface layer: approximately 672 V touch  and 2,220 V step.


The optimization was systematic. A deliberately conservative 30-foot mesh established the safe baseline  — and also demonstrated, in a no-surface-layer sensitivity run, that the crushed rock layer was essential  (localized touch potentials exceeded limits without it). Mesh spacing was then relaxed in 10-foot  increments with full touch/step re-analysis at each step. The design passed at 70-foot spacing with the  touch result inside 30 V of the limit — a precisely engineered margin — and failed at 80 feet, bracketing  the optimum. Final grid impedance computed at 0.19 Ω against the 2 Ω industry threshold.


The Outcome


  • Mesh optimization from 30-foot to 70-foot spacing removed more than half the buried copper runs  and associated exothermic connections from the bill of materials — a six-figure construction saving  — with every configuration verified compliant
  • Grid impedance of 0.19 Ω, an order of magnitude inside the 2 Ω threshold
  • Lightning mast count reduced through zone-interaction analysis with full IEEE 998 coverage  documented
  • Grounding boundary and mast placement coordinated with the dashed-in future breaker-and-a half bay, so the expansion inherits a compliant foundation rather than a retrofit

Case Study 2: General Arrangement and Bus Design for a  345/138 kV Breaker-and-a-Half Transmission

Case Study Parameter Table
Facility type Greenfield ring bus interconnection substation for utility-scale wind generation
Voltage class 138/69 kV (HV / subtransmission)
Configuration Three-breaker 138 kV ring bus, 138/69 kV power transformer, single 69 kV line exit; breaker-and-a-half expansion provisions
Keentel scope IEEE 80 grounding study and grid design, IEEE 998 lightning shielding study, physical design support

The Challenge


A transmission owner needed a new EHV station where reliability requirements ruled out any  configuration that could drop a circuit for breaker maintenance — driving the 345 kV yard to a breaker and-a-half arrangement, at roughly 145% of single-bus relative cost, with every dollar of that premium  requiring justification through layout efficiency. High available fault duty stressed bus short-circuit  forces; the corridor’s wind and ice loading criteria stressed structures; and the owner’s standards  exceeded code-minimum clearances at both voltage levels. The station also had to accept two future  345 kV line terminals without rework.


Keentel’s Approach


The 30% package locked the decisions with the longest shadows: bay ordering that placed the  autotransformers on adjacent diameters (limiting bus runs between them), a centralized control  building honoring the transformer standoff rule, and dead-end structures positioned so both existing  and future line approaches never cross major equipment. The future terminals were drawn dashed with  their foundations, bus stubs, and ground grid extensions fully dimensioned — reserved in steel-ready  detail, not as a note.


Bus design proceeded under IEEE 605. At 345 kV, ampacity was straightforward; short-circuit mechanical  force governed. Phase-to-phase electromagnetic forces at the design fault were computed against  candidate spans and schedules, iterating span length, pipe schedule, and insulator cantilever class  together until the system carried fault forces with the owner’s required margin — including the  simultaneous wind case. Strain bus tensions into the dead-end structures fed the structural loading  trees along with wind, ice, and equipment operating loads, giving the structural discipline a complete,  revision-controlled loading basis at 60%.


Insulation coordination matched arrester MCOV to the effectively grounded system at both voltage  levels, verified protective margins between arrester protective levels and equipment BIL (including  separation-distance effects for equipment remote from arresters), and documented switching-surge  considerations appropriate to the 345 kV class. Elevation sections were cut through every distinct bus

substation-design  Technical Guide

level, with transition structures resolving the height changes between the 345 kV and 138 kV work — the detail most often missed in first-pass elevation drafting.


The package moved through 30/60/90/IFC with independent checking at each gate and clouded  revisions between submittals. Owner review comments at 60% — principally vendor-data-driven  bushing geometry updates and a request to lengthen one maintenance access corridor — were  incorporated and re-checked without milestone slip.


The Outcome


  • IFC package delivered on schedule with zero clearance or spacing comments at the 90% owner  review
  • Breaker-and-a-half premium partially recovered through layout efficiency: compact bay ordering  and shared lightning masts on dead-end structures reduced steel and foundation count versus the  owner’s reference layout
  • Future line terminals fully reserved — foundations, bus geometry, grounding — enabling later  expansion with no rework of the energized yard
  • Complete structural loading trees accepted by the structural engineer of record without a single  reissue cycle

Case Study 3: Fast-Track Equipment Sizing and Auxiliary  Design for a 115/34.5 kV Solar-Plus-Storage Collector  Substation

Case Study Parameter Table
Facility type Collector step-up substation for a utility-scale solar and battery energy storage facility
Voltage class 115/34.5 kV (HV / medium-voltage collector)
Configuration Single 115 kV line terminal, main power transformer with staged cooling, 34.5 kV collector bus
Keentel scope Major equipment sizing, one-line development, arrester and instrument transformer selection, IEEE 485 DC and IEEE 1818 AC auxiliary system design, IFC support on a compressed schedule

The Challenge


A renewable developer faced a contractual energization date that left no float for sequential  engineering. Transformer and breaker specifications had to be issued for procurement before the layout  was complete, meaning every rating had to be right the first time — in an inverter-based-resource  environment where fault contribution behaves differently than conventional generation and auxiliary  reliability directly affects revenue.


Keentel’s Approach


Equipment sizing was executed as a front-loaded calculation package. The main transformer was sized  from interconnection capacity using S = √3 × VL × IL and specified with staged ONAN/ONAF/ONAF  ratings so the base rating anchored fault and impedance studies while the top rating carried maximum  plant output with margin. The 115 kV breaker continuous rating applied the 125% practice to the  transformer’s top rating and selected the next standard class; interrupting duty was screened with the  infinite-bus method through the transformer impedance, then confirmed with a short-circuit study  incorporating utility source data and documented inverter fault contribution — the screen and the study  were both filed, giving the owner a defensible margin narrative.


Arresters were selected by MCOV for the effectively grounded 115 kV system and the collector-side  grounding configuration, coordinated against equipment BIL per voltage class. CTs were specified at full load-plus-margin primary ratings with 5 A secondaries, ratio-verified with the protection engineer for  burden and saturation; the 115 kV terminal used CCVTs, ratio-matched to the line-to-ground system  voltage with a 115 V-class secondary.


The auxiliary systems were engineered in parallel rather than as an afterthought. DC loads were  inventoried from vendor catalog data — trip and close coils, breaker spring-charging motors, lockout  relays, protective relays, annunciators, and DC emergency lighting — and the battery was sized per IEEE  485 against a worst-case fault scenario duty cycle: a first-minute momentary block capturing the fault  event, an eight-hour continuous block for the station-service-outage case, and an end-of-duty  momentary block proving the battery could still charge springs and operate breakers at the end of  discharge. Charging motors were conservatively modeled at a two-minute run to envelope starting  current. The AC station service load tabulation per IEEE 1818 applied load and demand factors across  yard, power distribution center, and control building loads — transformer cooling, equipment heaters,  HVAC, lighting, receptacles, fire alarm, and battery charging — sizing the station service supply with  documented diversity rather than raw connected load.


The Outcome


  • Long-lead transformer and breaker specifications issued weeks ahead of layout completion with  zero subsequent rating revisions
  • Battery sizing withstood owner’s-engineer review without modification — the duty-cycle  methodology and simulation-backed voltage profile answered every question in the first response  cycle
  • Documented kAIC margin narrative (screen plus full study) accepted by the interconnecting utility  without follow-up data requests
  • Substation energized on the contractual date; the auxiliary design basis was reused by the  developer as a fleet template for subsequent collector stations

Frequently Asked Questions

  • 1. What exactly does “primary design” include, and where does it stop?

     Primary design covers the high-voltage power path and its physical world: one-lines, general  arrangement, major equipment selection and sizing, bus design, clearances, structures interface,  grounding, lightning shielding, and insulation coordination. It hands off to secondary design at the  instrument transformer secondaries and the control building door — relaying, control wiring, SCADA,  and communications are secondary scope, though the two must be coordinated continuously.


  • 2. How is the bus configuration chosen for a new substation?

    By balancing circuit criticality, outage tolerance, budget, and site area. A radial distribution station may  justify only a single bus; a four-terminal HV interconnection typically lands on a ring bus with breaker and-a-half expansion provisions; critical EHV hubs and plant switchyards justify breaker-and-a-half or  double-breaker/double-bus. Relative installed cost runs from 100% (single bus) to roughly 190% (double  breaker), so the configuration decision is also the single largest cost lever in the station.


  • 3. What U.S. voltage classes apply to substation work?

    Distribution/medium voltage (2.4, 4.16, 12.47, 13.2, 13.8, 24.94, and 34.5 kV among others),  subtransmission (34.5, 46, 69 kV), high voltage (115, 138, 161, 230 kV), and extra-high voltage (345, 500,  765 kV). Equipment is designed to the corresponding maximum system voltage (e.g., 145 kV for a  nominal 138 kV system) per ANSI C84.1 and companion practice.


  • 4. How do I size the power transformer?

    Start from forecast load or interconnection capacity: S = √3 × VL × IL. Select a standard staged rating  (ONAN/ONAF/ONAF) whose top rating covers maximum loading with margin and whose base rating sets  your impedance and fault calculations. Then verify impedance against both fault duty (higher Z limits  fault current) and voltage regulation (lower Z limits drop) — the two pull in opposite directions.


  • 5. What is kAIC and why does it matter?

    Kiloampere interrupting capacity — the maximum fault current a breaker can safely interrupt. Applying  a breaker beyond its interrupting rating risks catastrophic failure. A quick infinite-bus screen (MVA base  / (√3 × VL × Z%)) bounds the transformer contribution, but a full short-circuit study including source  impedance and all contributions is required before purchase.


  • 6. Why is the 125% factor applied to breaker continuous ratings?

    It provides margin for emergency loading, unbalance, ambient temperature, and future growth, and it  aligns the selection with standard rating steps (1,200 A, 2,000 A, 3,000 A). Individual utilities may specify  different margins; the owner’s standard governs.


  • 7. What determines phase spacing and clearances?

    Voltage class (specifically maximum system voltage and BIL), governed by NESC, IEEE 1427, ANSI C29  insulator dimensions, NFPA 70E working space, and the owner’s standards — which frequently exceed  code. Clearances must be verified in three dimensions, including conductor movement, equipment  bushing geometry, and maintenance access, not just in plan view.


  • 8. Why is grounding design iterative instead of formula-based?

    Because the governing variables — layered soil resistivity, grid geometry, fault current division, and  surface treatment — interact nonlinearly. Practice is to build a compliant conservative grid, then relax  mesh spacing in steps until the touch/step limits bracket the optimum. The iteration converts directly  into copper savings while every configuration is verified against IEEE 80 limits.


  • 9. Does the crushed rock layer in a substation actually matter?

     Enormously. A 4-inch layer of ~3,000 Ω·m crushed rock raises foot-to-earth contact resistance, which  raises the tolerable touch and step voltages by hundreds of volts. Designs that fail without a surface  layer routinely pass with one — it is one of the cheapest safety measures in the yard, and it must be  maintained over the station’s life.


  • 10. What is a zone of protection in lightning design?

    The volume around a shield mast or wire inside which a direct lightning stroke is intercepted before  reaching equipment, computed per IEEE 998 from mast height and protected equipment height.  Adjacent zones interact: where masts are close enough, the combined protected area exceeds the sum  of the individual circles, which is why optimized designs frequently need fewer masts than a first-pass  layout.


  • 11. AIS or GIS — how do we decide?

    Land, environment, and lifecycle cost. If the site has room and a benign environment, AIS is usually  cheapest. If land is constrained, the environment is coastal/contaminated/urban, or reliability  requirements are extreme, GIS pays for itself in footprint and maintenance. Hybrid arrangements are  common. Decide early — the choice restructures the entire layout and civil scope.


  • 12. What does a complete primary design deliverable package contain?

    One-line diagram, general arrangement plan and elevation sections, grounding study and grounding  plan, lightning shielding study and overlay, bus and insulator calculations, structural loading trees,  equipment specifications and data sheets, conduit/raceway plan interface, bill of materials, and  construction notes — progressed through 30/60/90/IFC gates with independent checking at each.

  • 13. How long does substation primary design take?

    Scope-dependent, but representative durations for a straightforward HV station run several months  from kickoff to IFC, with long-lead equipment specifications (transformer, breakers) issued at or before  60% to protect the schedule. Fast-track collector substations compress this by paralleling studies and  layout; complex EHV stations extend it.


  • 14. What information does Keentel need to start a primary design engagement?

    The interconnection or load basis (MW/MVA, voltage class, terminal count), site survey and  geotechnical/soil resistivity data if available (we can specify and coordinate the testing if not), the  owner’s design standards, fault duty data or system model access, and any existing drawings for  brownfield work. From that basis we produce a 30% package that locks the decisions everything else  depends on.



About Keentel Engineering

Keentel Engineering LLC is a power systems and grid interconnection consulting firm headquartered in  Tampa, Florida, with offices in Austin, Sacramento, and Baltimore. Our practice spans POI and grid  interconnection engineering, power system studies at EHV/HV/MV, substation and transmission design,  EMT modeling, utility-scale renewables and BESS engineering, NERC compliance, and owner’s engineer  services. Deliverables are prepared under the responsible charge of licensed Professional Engineers.



A smiling man with glasses and a beard wearing a blue blazer stands in front of server racks in a data center.

About the Author:

Sandip "Sonny" R. Patel, P.E.

IEEE Senior Member · Founder & CEO, Keentel Engineering

In 1995, Sonny Patel earned his Electrical Engineering degree from the University of Illinois. But degrees don't build legacies — action does.

For three decades, he has worked the power industry from every side of the table: 16 years as a utility engineer at Exelon/Commonwealth Edison; generation leadership across hydroelectric, industrial steam turbine, and a 9 GW renewable fleet; NERC Regional Entity Senior Compliance Engineer and Audit Team Lead, auditing some of the nation's largest utilities; and testing and commissioning lead on equipment up to 765 kV — the very top of the North American grid.Utility. Generator. Regulator. Consultant. Few engineers have seen all four seats. Fewer still have sat in them.

His experience spans nuclear, hydro, conventional generation, renewables, oil and gas, mining — and today's data centers, where he is authoring a three-book series on data center design. He is a Licensed Professional Engineer in six states and a Licensed Electrical Contractor in Florida (Unlimited EC) — he doesn't just design the work; he's qualified to stand behind its execution.Today, as Founder and CEO of Keentel Engineering, Sonny leads a nationwide team of engineers delivering substation design, power system studies, NERC compliance, and commissioning — done right, coast to coast.Three decades. Every side of the table. One standard: accountable engineering.

Four workers in safety vests and helmets stand with arms crossed near wind turbines.

Let's Discuss Your Project

Let's book a call to discuss your electrical engineering project that we can help you with.

Man in a blazer and open shirt, looking at the camera, against a blurred background.

About the Author:

Sandip "Sonny" R. Patel, P.E.

IEEE Senior Member · Founder & CEO, Keentel Engineering

In 1995, Sonny Patel earned his Electrical Engineering degree from the University of Illinois. But degrees don't build legacies — action does.

For three decades, he has worked the power industry from every side of the table: 16 years as a utility engineer at Exelon/Commonwealth Edison; generation leadership across hydroelectric, industrial steam turbine, and a 9 GW renewable fleet; NERC Regional Entity Senior Compliance Engineer and Audit Team Lead, auditing some of the nation's largest utilities; and testing and commissioning lead on equipment up to 765 kV — the very top of the North American grid.

Utility. Generator. Regulator. Consultant. Few engineers have seen all four seats. Fewer still have sat in them.

His experience spans nuclear, hydro, conventional generation, renewables, oil and gas, mining — and today's data centers, where he is authoring a three-book series on data center design. He is a Licensed Professional Engineer in six states and a Licensed Electrical Contractor in Florida (Unlimited EC) — he doesn't just design the work; he's qualified to stand behind its execution.

Today, as Founder and CEO of Keentel Engineering, Sonny leads a nationwide team of engineers delivering substation design, power system studies, NERC compliance, and commissioning — done right, coast to coast.Three decades. Every side of the table. One standard: accountable engineering.

Leave a Comment

Related Posts

LVDC data center power distribution chart comparing AC, hybrid, 380 VDC and 800 VDC efficiency.
By SANDIP R PATEL • November 11, 2026
Explore LVDC power distribution for data centers, including 380V vs 800V DC, architecture, grounding, protection, UPS, energy efficiency and safety standards.
Grid reliability vs. resilience comparison showing storm outage and power restoration performance
By SANDIP R PATEL • November 11, 2026
Explore grid reliability vs. resilience, extreme weather planning, outage recovery, IEEE 1366 metrics, microgrids and IBR challenges with Keentel Engineering.
PRC-028-1 Explained: What Every Solar, Wind & Battery Owner Needs to Know
By SANDIP R PATEL • November 10, 2026
Learn NERC PRC-028-1 requirements for solar, wind and BESS, including disturbance monitoring, recording standards, deadlines and compliance steps from Keentel.
1 GW data center power capacity breakdown from utility service to GPU racks.
By SANDIP R PATEL • November 8, 2026
What does a 1 GW data center mean? Explore power capacity, PUE, GPU racks, grid interconnection and commissioning with Keentel Engineering's expert guide.
TPL-001-5.1 transmission planning performance and NERC compliance requirements
By SANDIP R PATEL • November 8, 2026
Explore NERC TPL-001-5.1 requirements, P0–P7 planning events, Table 1, corrective action plans and annual assessments with Keentel Engineering.
Radial vs. loop distribution systems comparison showing outage minutes and reliability.
By SANDIP R PATEL • November 6, 2026
Compare radial vs. loop distribution systems in the US. Explore reliability, underground cables, protection, voltage drop and design with Keentel Engineering.
Transmission planning and resource adequacy analysis showing LOLE reduction and interregional transf
By SANDIP R PATEL • November 6, 2026
Learn how transmission planning improves US resource adequacy through LOLE, reserve sharing and FERC Order 1920 analysis from Keentel Engineering.
MOD-032-2 modeling data requirements and NERC compliance timeline through 2031.
By SANDIP R PATEL • November 6, 2026
Understand NERC MOD-032-2 requirements, key compliance dates, IBR modeling, DER data reporting and changes from MOD-032-1 with Keentel Engineering.
800 VDC AI data center cooling and chiller restart temperature comparison chart.
By SANDIP R PATEL • November 5, 2026
Learn how 800 VDC affects AI data center cooling, including chillers, CDUs, liquid-cooled racks, pump backup and DC safety. Keentel Engineering, USA.
