Ferranti Effect in Transmission Lines: Causes and Mitigation

Harmonic Resonance in Power Systems: Causes and Mitigation
Calendar icon. D

October 21, 2026 | Blog

Part A — The Ferranti Effect at a Glance

Energize a long extra-high-voltage transmission line from one end and leave the far end open, and the voltage at the open end is higher than the voltage at the source. Nothing has failed. No load is connected. The line itself, through its own distributed capacitance and series inductance, creates the rise. This is the Ferranti effect, first observed in the 1880s on a cable feeding London from the Deptford power station, and it remains one of the first constraints an engineer checks when energizing, restoring, or lightly loading a long 230 kV, 345 kV, 500 kV or 765 kV line.


The mechanism in one paragraph


A transmission line has capacitance distributed along its length. Under no load or light load, that capacitance draws charging current, which leads the voltage by 90°. The charging current flows through the line's series inductance, and the voltage drop across an inductance carrying a leading current is a voltage rise. The rise accumulates toward the open end, where all of the downstream charging has been supplied. The longer the line, and the higher the frequency, the larger the rise.


What Keentel's long-line model shows


Keentel Engineering modeled a representative 345 kV line with twin-bundled conductors (R = 0.030 Ω/km, X = 0.370 Ω/km and B = 4.5 µS/km at 60 Hz) using exact distributed-parameter equations, cascaded pi sections and an EMT traveling-wave model.

Case: 217-mile (350 km) line, receiving end open Receiving-end voltage rise
Same line at 50 Hz, stiff source (reference) 7.5%
60 Hz, stiff source, exact long-line solution 11.1%
60 Hz, single nominal pi section 11.4% (overestimates)
60 Hz, ten cascaded pi sections 11.1%
60 Hz, 10,000 MVA source, rise relative to source EMF 13.4%
60 Hz, 5,000 MVA source, rise relative to source EMF 15.8%
60 Hz, 50% shunt reactor compensation 5.4%
60 Hz, 70% shunt reactor compensation 3.2%
Energization at a voltage peak (EMT, 10,000 MVA source, no mitigation) Transient peak ≈ 2.2 pu

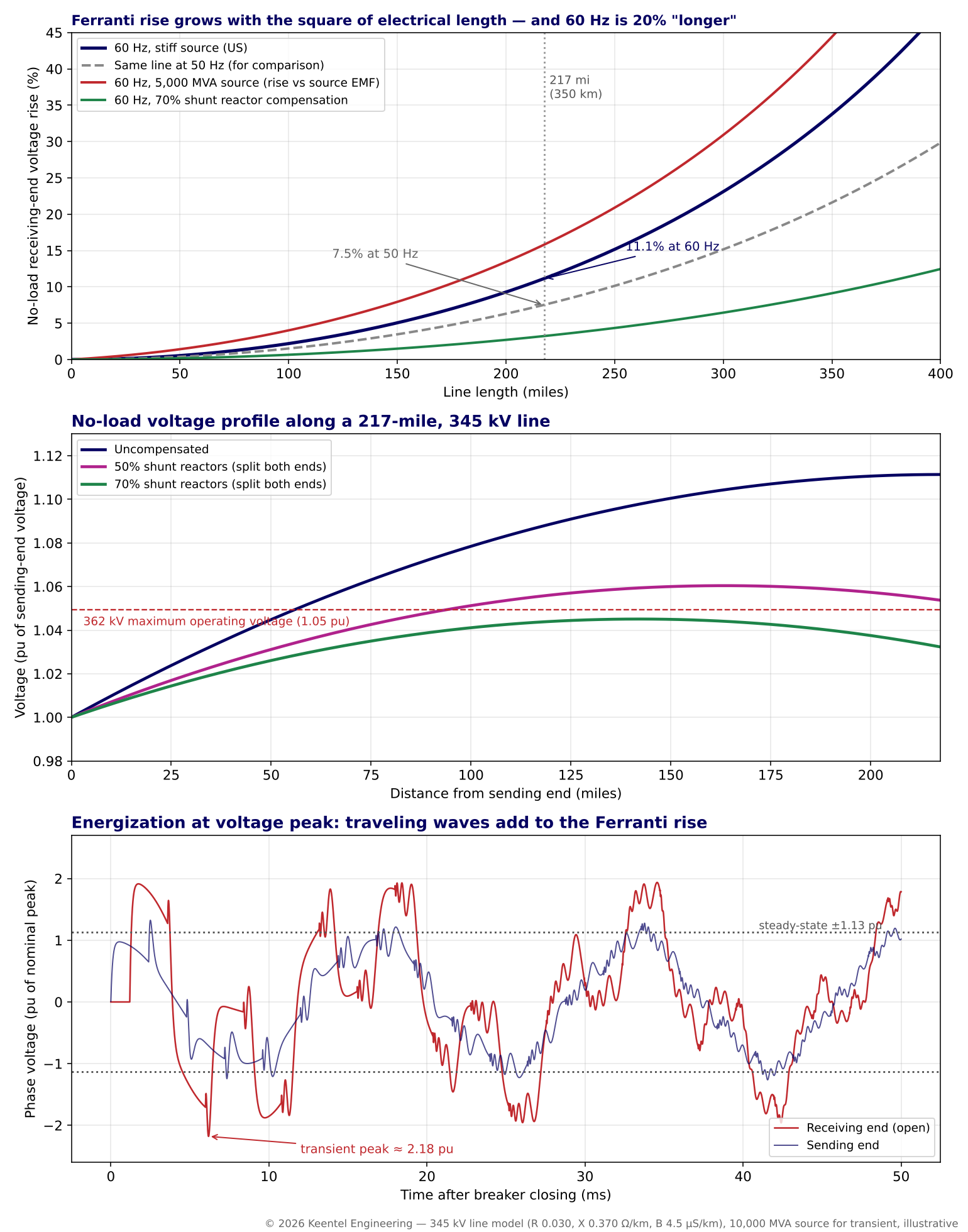

Figure 1. Top: no-load receiving-end voltage rise versus line length. Middle: voltage profile along a 217-mile, 345 kV line with and without shunt reactors. Bottom: EMT waveform of energization at a voltage peak, showing traveling-wave overvoltage on top of the steady-state Ferranti rise.


Four lessons from the model


  • US 60 Hz lines see a larger Ferranti rise than the same line at 50 Hz. Electrical length scales with frequency, and the rise scales roughly with the square of electrical length. A line that rises 7.5% at 50 Hz rises about 11% at 60 Hz — enough to push a 345 kV line beyond its 362 kV maximum operating voltage.
  • The source matters. Line charging current flowing through the source impedance raises the sending-end voltage too. With a weaker source, the open-end voltage relative to the system's internal voltage is substantially higher than the line-only calculation suggests.
  • For steady-state rise, every reasonable line model agrees. Frequency-dependent, Bergeron and multi-section pi models all predict essentially the same 60 Hz no-load voltage. Model choice matters for transients, not for the steady-state Ferranti calculation.
  • The steady-state rise is only the starting point. Switching transients during energization can more than double the instantaneous voltage at the open end, so insulation coordination, surge arresters and switching practice must be checked together with the steady-state rise.


Engineering review of a typical published simulation


Keentel reviewed a published comparison of a 50 Hz, 350 km double-circuit EHV line simulated with frequency-dependent, Bergeron and pi-section models. The reported results were 7.50%, 7.53% and 7.63% receiving-end voltage rise respectively.

Published statement Keentel's check
All three models predict about 7.5% rise on a 350 km line at 50 Hz. Confirmed. Keentel's exact long-line calculation for comparable 50 Hz parameters gives 7.52%.
The pi section model gives the highest rise Consistent with theory. A lumped pi representation slightly overestimates the rise unless the line is divided into enough sections; Keentel's single-section 60 Hz case overestimates by 0.2 percentage points.
Voltage rise (%) = (Vr − Vs) ÷ Vs × 100 Correct definition, but it measures rise relative to the sending-end bus only. Because charging current also raises the sending-end bus, the rise relative to the source's internal voltage, or relative to nominal, is larger and is often what matters for equipment ratings.
The study demonstrates "a significant Ferranti effect" Yes, and at 60 Hz it is larger: about 11% for the same physical length. US engineers should not apply 50 Hz results directly.
Frequency dependent model "particularly suitable for detailed transient studies" Correct. For steady-state Ferranti rise, the simpler models are adequate; for switching surges, transient recovery voltage and resonance studies, frequency-dependent models are preferred.
Double circuit line The per unit Ferranti rise of each circuit is set by its own electrical length, but energizing both circuits doubles the charging current drawn from the source, roughly doubling the source-side voltage rise.

Part B — The Ferranti Effect on Long EHV Transmission Lines: Theory, Modeling and Mitigation for US Practice

1. Why the Ferranti effect still matters


The Ferranti effect is textbook material, yet it continues to shape real decisions on the US grid:


  • Renewable export lines. New 345 kV and 500 kV lines carrying wind and solar output from West Texas, the Great Plains and the desert Southwest are long, and they are often lightly loaded at night or during low-resource periods.
  • Interregional transmission. Long 500 kV and 765 kV lines connect regions and are planned for high transfers, but they must also operate safely at light load and during energization.
  • System restoration. NERC EOP-005 restoration plans energize long cranking paths from small black-start units, where the Ferranti rise and the line's charging current can exceed the unit's capability.
  • Underground and submarine cables. Cables have many times the capacitance per mile of overhead lines. Data center campuses, urban substations and offshore wind export cables all bring large charging currents.
  • Equipment ratings. Breakers, transformers, arresters and insulation are rated for specific maximum operating voltages and temporary overvoltages. The Ferranti rise eats into those margins.


1.1 A short history


In 1887, Sebastian Ziani de Ferranti designed the Deptford power station to supply central London at 10 kV through concentric cables several miles long — an extraordinary voltage for the time. Engineers noticed that the voltage at the London end of the cables was higher than at Deptford when the load was light. The explanation, worked out in the following years, introduced the idea that a line's capacitance and inductance must be considered together and distributed along its length. The same equations, refined by Heaviside, Kennelly and Steinmetz, underpin every modern long-line calculation, from 765 kV overhead corridors to offshore wind export cables. More than a century later, the Ferranti effect is still a first check in every EHV planning study, because the physics has not changed — only the lengths, voltages and charging currents have grown.


2. Transmission line parameters


2.1 Series and shunt parameters


A transmission line is characterized per unit length by series resistance r, series inductance l (reactance x = ωl), shunt conductance g (usually negligible) and shunt capacitance c (susceptance b = ωc). Typical positive-sequence values at 60 Hz:

Voltage class Typical conductor configuration X (Ω/mile) B (µS/mile) Surge impedance Zc (Ω) SIL (MW) Charging (Mvar/mile)
115 kV Single conductor 0.75 to 0.80 5.3 to 5.6 ≈ 375 ≈ 35 ≈ 0.07
138 kV Single conductor 0.75 to 0.80 5.3 to 5.6 ≈ 375 ≈ 50 ≈ 0.10
230 kV Single or twin bundle 0.70 to 0.80 5.5 to 6.0 ≈ 360 ≈ 145 ≈ 0.30
345 kV Twin bundle ≈ 0.60 ≈ 7.2 ≈ 290 ≈ 410 ≈ 0.86
500 kV Triple or quad bundle ≈ 0.55 ≈ 7.6 ≈ 270 ≈ 925 ≈ 1.9
765 kV Quad to six bundle ≈ 0.50 ≈ 8.3 ≈ 250 ≈ 2,350 ≈ 4.9

Values vary with conductor size, bundle spacing, phase spacing and tower geometry; project-specific line constants calculations are required for design.



2.2 Surge impedance and propagation constant

For the Keentel 345 kV model:

That is 0.074° per kilometer, or about 11.9° per 100 miles at 60 Hz. A full wavelength is about 4,870 km (3,020 miles) — close to the free-space value of 5,000 km at 60 Hz, because overhead line waves travel at about 97% of the speed of light.


2.3 Surge impedance loading

For the 345 kV model, SIL = 345² ÷ 287 ≈ 415 MW. At SIL, the line's reactive generation (charging) exactly balances its reactive consumption (I²X), and the voltage profile is flat. Below SIL, the line generates net reactive power and voltage rises toward the receiving end. The Ferranti effect is the limiting case at zero load.


3. The long-line equations


3.1 ABCD parameters



For a uniform line of length ℓ, sending-end and receiving-end quantities are related by:

3.2 Open-circuit receiving end



With the receiving end open, IR = 0, so:

The lossless approximation is excellent for EHV lines. The voltage at any point x measured from the receiving end follows a cosine profile:

so the voltage rises continuously from the sending end to the open end, as shown in the middle panel of Figure 1.



3.3 Worked example: 217-mile, 345 kV line

Step Calculation Result
Length 217.5 miles 350 km
Electrical length βℓ = 1.29 × 10⁻³ × 350 0.452 rad = 25.9°
Exact (lossless) ratio 1 ÷ cos(25.9°) 1.1116
Exact with losses (Keentel model) 1 ÷ magnitude of cosh(γℓ) 1.1114
Receiving-end voltage for 345 kV sending 345 × 1.111 383 kV
Maximum operating voltage of 345 kV equipment ANSI/IEEE rated maximum 362 kV

The open-end voltage exceeds the 362 kV maximum operating voltage by about 6%. Energizing this line from one end without compensation is not acceptable for continuous operation.



3.4 The quick approximation


Expanding the cosine for short electrical lengths:

For the 217-mile line, (0.452)² ÷ 2 = 10.2%, compared with the exact 11.1%. The approximation underestimates the rise and becomes increasingly inaccurate beyond roughly 150 miles at 60 Hz. It does, however, show the two key scaling laws: the rise grows with the square of length and with the square of frequency.


3.5 Why 60 Hz matters


The same physical line has 20% more electrical length at 60 Hz than at 50 Hz. Because the rise scales roughly with the square of electrical length, it is about 45% to 50% larger at 60 Hz.

Line length Rise at 50 Hz Rise at 60 Hz
100 miles 1.5% 2.2%
150 miles 3.5% 5.1%
200 miles 6.3% 9.3%
217 miles (350 km) 7.5% 11.1%
250 miles 10.1% 15.2%
300 miles 15.2% 23.1%

This is the most important correction when applying international literature to US systems: 50 Hz results understate the Ferranti rise on US lines.


3.6 The quarter-wavelength limit


As βℓ approaches 90°, cos(βℓ) approaches zero and the open-end voltage tends toward infinity, limited only by losses and corona. At 60 Hz, a quarter wavelength is about 755 miles (1,215 km). No uncompensated line approaches this length in practice, but the rapid growth of the rise beyond 300 miles explains why very long EHV lines always require compensation.


3.7 Does voltage class matter?


A useful and often surprising result is that the per-unit Ferranti rise of an overhead line depends almost entirely on its length and frequency, not on its voltage class. The phase velocity of overhead lines is close to the speed of light for every voltage class, because √(lc) depends on geometry ratios that change little. What changes dramatically with voltage class is the amount of charging reactive power — and therefore the source-side rise and the size of the reactors needed.

For a 150-mile overhead line at 60 Hz:

Voltage class Phase shift per 100 miles (approx.) Open-end rise, stiff source Charging (Mvar) Sending-end rise with 5,000 MVA source
115 kV ≈ 12° ≈ 5% ≈ 11 ≈ 0.2%
138 kV ≈ 12° ≈ 5% ≈ 15 ≈ 0.3%
230 kV ≈ 12° ≈ 5% ≈ 46 ≈ 0.9%
345 kV ≈ 12° ≈ 5% ≈ 129 ≈ 2.6%
500 kV ≈ 12° ≈ 5% ≈ 285 ≈ 5.7% (source this weak is unusual at 500 kV)
765 kV ≈ 12° ≈ 5% ≈ 730 Requires a much stronger source and line reactors

The practical consequence is that Ferranti problems become severe at EHV not because the per-unit line rise is larger, but because EHV lines tend to be longer, carry far more charging, and connect to sources whose strength is small relative to that charging. At 765 kV, a single long line can draw as much charging as a large generator's entire reactive capability, which is why 765 kV lines are almost always built with line-connected reactors.


3.8 Physical intuition: the phasor picture


Consider the line as many short segments. At the open end, the last segment carries only its own small charging current. Moving toward the source, each segment carries the charging current of all segments downstream, so the current grows almost linearly toward the sending end. Each segment's inductance develops a voltage jωLI that, for a leading current, adds in phase with the local voltage. The rise accumulates from the source to the open end, and because the current is largest near the source, most of the rise happens in the first half of the line — which is exactly the shape of the uncompensated profile in Figure 1. Shunt reactors placed at the ends cancel part of the charging current where it accumulates most, which explains why end-located reactors are so effective and why the compensated profile peaks near the middle of the line.


4. The role of the source


4.1 Source impedance raises the sending end


Charging current drawn by the line flows through the source impedance, and because it is leading current, it raises the sending-end bus voltage. The rise is approximately:

For one 345 kV, 217-mile circuit drawing about 187 Mvar of charging from a 10,000 MVA source, the sending-end rise is about 1.9%. For both circuits of a double-circuit line, charging doubles to about 375 Mvar and the sending-end rise to about 3.8%.


4.2 Combined rise relative to source voltage


The open-end voltage relative to the source's internal voltage combines both effects:

Source short-circuit capacity Sending-end rise Receiving-end voltage relative to source EMF
Infinite (stiff) 0% 1.111 pu
20,000 MVA 1.0% 1.123 pu
10,000 MVA 2.1% 1.134 pu
5,000 MVA 4.2% 1.158 pu
2,500 MVA 8.8% 1.209 pu

Energizing a long line from the weaker end produces a markedly higher open-end voltage. Operating procedures therefore normally specify energization from the stronger terminal, with the sending-end voltage reduced before closing if necessary.


4.3 Generator self-excitation


When a long line is energized from a small generator — as in black-start restoration — the line's charging can exceed the generator's underexcited reactive capability. The generator's terminal voltage can then rise uncontrollably as the line's capacitive reactance resonates with the generator's synchronous reactance. A simplified check for self-excitation risk is:

where XC,line is the capacitive reactance of the energized line seen at the generator terminals and Xd is the generator's synchronous reactance (on a common base). Restoration plans must confirm that cranking paths stay well clear of this condition, typically by energizing with shunt reactors in service, limiting the length of line energized at once and picking up load early.


5. Line modeling approaches


5.1 Nominal and equivalent pi models


The nominal pi model lumps the series impedance zℓ in a single branch and splits the shunt admittance yℓ equally between two shunt branches. It is accurate for short lines and for steady-state calculations on medium-length lines. The equivalent pi model corrects the lumped values with hyperbolic factors so that it reproduces the exact long-line solution at one frequency:

Power flow programs use equivalent pi models, so steady-state Ferranti rise calculated in a load flow is exact at 60 Hz — provided the line data are correct.

Keentel's comparison for the 217-mile line shows how cascading nominal pi sections converges:

Number of nominal pi sections Receiving-end ratio Error versus exact
1 1.1135 +0.21 percentage points
2 1.1119 +0.05
5 1.1115 +0.01
10 1.1114 +0.003
Exact distributed 1.1114 —

5.2 Pi models in time-domain simulation



In EMT simulation, a cascade of pi sections represents traveling waves only approximately. Each section acts as a low-pass filter with a cutoff frequency near:

where Δℓ is the section length. A practical guideline is that each section should be shorter than about one-tenth of the shortest wavelength of interest. For switching transients with content up to several kilohertz, a 200-mile line needs many short sections, and the model still introduces spurious oscillations. Pi models are therefore best reserved for short lines or for low-frequency studies.


5.3 Bergeron (constant-parameter distributed) model


The Bergeron model represents the line as lossless traveling waves with travel time τ = ℓ√(lc) and surge impedance Zc, with resistance lumped at the ends and middle. Parameters are calculated at one frequency, usually 60 Hz. It reproduces fundamental-frequency behavior and wave travel times accurately and is computationally efficient. Its limitation is that line resistance and inductance actually change with frequency, particularly in zero sequence because of ground-return effects, so damping and wave shape at high frequencies are approximate.



The traveling-wave relationship at each terminal k of a line between nodes k and m is:

5.4 Frequency-dependent models


Frequency-dependent (FD) models fit the line's characteristic admittance and propagation function over a wide frequency range, either in modal form or directly in the phase domain (the universal line model used in modern EMT programs). They capture:


  • the strong frequency dependence of zero-sequence resistance and inductance due to earth return,
  • skin effect in conductors and ground wires,
  • untransposed geometry and mutual coupling between circuits on the same towers,
  • realistic damping of switching transients.


FD models are the preferred choice for switching overvoltage studies, transient recovery voltage, secondary arc and single-pole tripping studies, and resonance studies involving double-circuit coupling.


5.5 Model selection summary

Study Pi (nominal or equivalent) Bergeron Frequency-dependent
Steady-state Ferranti rise Adequate (equivalent pi exact at 60 Hz) Adequate Adequate
Load flow and voltage control Standard Not used Not used
Energization and reclosing overvoltages Not recommended for long lines Acceptable for screening Preferred
Transient recovery voltage Not recommended Acceptable with care Preferred
Secondary arc and single-pole reclosing Not recommended Limited Preferred
Harmonic and resonance studies Equivalent pi at each frequency, or FD Limited Preferred
Untransposed and double-circuit coupling Possible with coupled sections Possible Preferred

The published 50 Hz comparison reviewed in Part A illustrates the first row: all models agreed within 0.13 percentage points on steady-state rise. That agreement should not be extrapolated to transient studies, where the models can differ substantially in peak overvoltage and damping.


6. From steady-state rise to switching overvoltage


6.1 Energization transients


When a breaker closes onto an open line, a voltage step travels down the line at nearly the speed of light, reflects at the open end and doubles. The reflected wave returns to the source, reflects again and continues to bounce, superimposed on the rising steady-state voltage. The peak transient voltage at the open end depends on:

Factor Effect on peak overvoltage
Point on wave at closing Closing at voltage peak produces the largest step
Trapped charge (high speed reclosing) Can raise peaks toward 3 pu or more
Steady-state Ferranti rise Raises the base on which transients ride
Source strength and network Determines wave reflections at the sending end
Breaker pole scatter Causes coupled transients between phases
Line losses and frequency dependence Damp transients
Mitigation (pre-insertion resistors, controlled switching, arresters) Can limit peaks to about 1.5 to 2.0 pu

In Keentel's single-phase-equivalent EMT model of the 217-mile line, closing at a voltage peak from a 10,000 MVA source produces a peak of about 2.2 pu at the open end. Closing at a voltage zero limits the peak to about 1.6 pu. Three-phase studies with realistic breaker pole scatter and statistical switching typically show 2% switching overvoltages of 2.0 to 2.8 pu for unmitigated EHV line energization, and higher for reclosing onto trapped charge.


6.2 Insulation coordination


IEEE 1313.1 and IEEE 1313.2 define the insulation coordination process. For EHV lines, switching surge performance often controls tower clearances and insulator string length. The steady-state Ferranti rise, the temporary overvoltages it creates and the switching surge distribution must be considered together:

Voltage class Maximum operating voltage Typical controlled switching overvoltage target
345 kV 362 kV About 2.0 to 2.2 pu
500 kV 550 kV About 1.8 to 2.0 pu
765 kV 800 kV About 1.6 to 1.8 pu

6.3 Temporary overvoltage and surge arresters


The Ferranti rise appears as a temporary overvoltage (TOV) lasting until the line is loaded, compensated or switched. Metal-oxide surge arresters have finite TOV capability defined by their maximum continuous operating voltage (MCOV) and TOV curves under IEEE C62.11. An arrester selected for normal operating voltage may absorb excessive energy, overheat and fail if the line remains open-ended with a large Ferranti rise. Arrester selection must therefore use the maximum credible open-end voltage, including the source-side rise and any load-rejection overvoltage.


7. Mitigation


7.1 Shunt reactors



Shunt reactors absorb part of the line's charging and are the primary mitigation for the Ferranti effect. The degree of shunt compensation is:

With reactors at both ends, the open-end voltage ratio becomes approximately:

where Xr is the reactance of the reactor at the receiving end. Keentel's model results for the 217-mile line:

Shunt compensation (split equally at both ends) Reactor rating per end, per circuit Open-end rise
0% — 11.1%
50% ≈ 47 Mvar 5.4%
70% ≈ 66 Mvar 3.2%
90% ≈ 84 Mvar 1.2%

Typical EHV practice uses 50% to 80% shunt compensation on long lines. Very high compensation can create resonance with the line's capacitance in an open phase during single-pole tripping, sustaining the secondary arc or causing resonant overvoltage; four-reactor schemes with a neutral reactor are used to neutralize interphase capacitance where single-pole reclosing is required. Reactors are specified under IEEE C57.21.



7.2 Line-connected versus bus-connected reactors

Arrangement Advantages Considerations
Line-connected (no breaker) Always in service when the line is energized, protects against open-end Ferranti rise during energization Reduces transfer capability at heavy load; reactor fault takes the line out
Line-connected with breaker or circuit switcher Can be switched out at heavy load Switching duty; procedures must ensure reactors are in during energization
Bus-connected Flexible voltage control for the station Does not compensate the line if the line is open at that station
Tertiary-connected on autotransformers Economical at lower voltage Limited rating; only effective when the transformer is energized

7.3 Static var compensators, STATCOMs and synchronous condensers


Dynamic reactive devices can absorb reactive power under light load and supply it under heavy load. They complement fixed reactors but are rarely the sole mitigation for energization, because they must be in service and correctly controlled at the moment of energization.



7.4 Operating practices

Practice Purpose
Energize from the stronger terminal Minimizes source-side rise
Lower sending-end voltage before energization Keeps open-end voltage within limits
Ensure line reactors are in service before closing Limits steady-state rise
Close the far-end breaker promptly Ends the open-ended condition
Use controlled (point-on-wave) closing or pre-insertion resistors Limits switching transients
Remove capacitor banks and adjust transformer taps at light load Reduces overall voltage rise
Pick up load early during restoration Absorbs charging and stabilizes voltage

7.5 Worked example: sizing reactors to meet a voltage limit



Goal: keep the open-end voltage of the 217-mile, 345 kV line at or below 362 kV when energized at 350 kV from a stiff source.

Step Calculation Result
Allowed ratio 362 ÷ 350 1.034
Required compensation (from Keentel model) Interpolating the table above about 68%
Line charging per circuit at 345 kV 345² × 4.5 µS/km × 350 km ≈ 187 Mvar
Total reactors per circuit 0.68 × 187 ≈ 127 Mvar
Arrangement Split between both ends ≈ 64 Mvar per end per circuit
Check with a 10,000 MVA source Source rise adds about 1% Specify 70% or reduce energizing voltage

A practical design would select standard reactor ratings, then confirm the result with load flow, light-load voltage control studies and EMT energization studies.


8. Light-load operation and voltage control



The Ferranti effect is not only an energization problem. Any line loaded below SIL generates net reactive power. A 345 kV line loaded at 100 MW (about a quarter of SIL) on a mild night still generates most of its charging. Several lightly loaded EHV lines in one area can raise voltages throughout the region, forcing generators to absorb reactive power and pushing them toward underexcitation limits.

Light-load condition System symptom Typical response
Overnight low load High voltages across EHV network Switch reactors in, capacitor banks out, adjust taps
Low renewable output on export lines Long lines lightly loaded Line reactors, generator VAR absorption
Outages removing reactors Loss of compensation Operating limits until reactors return
Spring and fall minimum load Generators near underexcited limits Voltage schedules, additional reactors

NERC VAR-001 and VAR-002 require transmission operators and generator operators to maintain voltage schedules and reactive capability. Planning studies under NERC TPL-001 must show acceptable voltages in light-load cases, including the outage of key reactive devices.


9. Cables: the Ferranti effect in its original form



Underground and submarine cables have capacitance per mile 20 to 50 times higher than overhead lines, and their waves travel at only about half the speed of light. Both effects lengthen their electrical length and increase charging.

Cable Approximate charging
138 kV XLPE 1.5 to 2.5 Mvar per mile
230 kV XLPE 3 to 5 Mvar per mile
345 kV XLPE 7 to 10 Mvar per mile

A 12-mile, 230 kV cable can draw roughly 50 Mvar of charging comparable to a 160-mile overhead line at the same voltage. The open-end Ferranti rise of a short cable is small, but its charging current raises the source-side voltage, loads the cable's own ampacity, and dominates reactive compensation design. Long AC cables require shunt reactors at one or both ends, and beyond a few tens of miles at EHV, the charging current consumes so much of the cable's ampacity that HVDC becomes the practical choice. Cable systems also have resonant frequencies far lower than equivalent overhead lines, so energization and harmonic studies require frequency-dependent cable models.


10. Study workflow for long lines and cables


  1. Line constants: calculate positive-, negative- and zero-sequence parameters from conductor and tower geometry, including mutual coupling for double-circuit lines.
  2. Steady-state screening: calculate open-end rise for each energization direction, source strength and reactor configuration.
  3. Load flow and light-load studies: check voltages across the system under minimum load, outages of reactors and lines, and voltage schedules.
  4. Reactor sizing: select compensation degree, arrangement and switching, and check transfer capability at heavy load.
  5. EMT energization and reclosing studies: statistical switching studies with frequency-dependent line models, realistic sources, breaker pole scatter and trapped charge.
  6. Insulation coordination and arrester selection: confirm clearances, insulators and arrester energy and TOV capability.
  7. Special studies: single-pole tripping and secondary arc, resonance in open phases of compensated double-circuit lines, transient recovery voltage for line breakers.
  8. Operating procedures: energization direction, voltage targets, reactor status and restoration sequences.


10A. Worked example: double-circuit energization from a moderate source


Consider both circuits of the 217-mile, 345 kV line energized together from a substation with 10,000 MVA of short-circuit capacity, receiving ends open, no reactors.

Step Calculation Result
Charging per circuit at nominal voltage 345² × 4.5 µS/km × 350 km ≈ 187 Mvar
Total charging, both circuits 2 × 187 ≈ 375 Mvar
Sending-end rise ≈ 375 ÷ 10,000 (refined by the exact model) ≈ 4.2%
Line-only Ferranti ratio 1 ÷ cos(25.9°) 1.111
Open-end voltage relative to source EMF 1.042 × 1.111 ≈ 1.158 pu
With source EMF at 1.00 pu (345 kV) 345 × 1.158 ≈ 400 kV

Energizing both circuits simultaneously from a 10,000 MVA bus produces about the same open-end voltage as energizing one circuit from a 5,000 MVA bus. The practical guidance is to energize one circuit at a time, from the stronger terminal, with line reactors in service, and to close the far-end breaker of the first circuit before energizing the second.


10B. Load rejection: the Ferranti effect in reverse


The Ferranti effect also appears suddenly when a heavily loaded long line loses its receiving-end load for example, when the receiving-end breaker opens during a fault elsewhere or a large load trips. The line instantly becomes open-ended. At the same time:


  • generators at the sending end, previously supplying both load and line losses, are suddenly underloaded and accelerate, raising frequency and therefore electrical length;
  • automatic voltage regulators, set to support a heavily loaded system, take time to reduce excitation;
  • capacitor banks switched in for heavy load remain in service until they are switched out.


The combination can produce temporary overvoltages of 1.3 to 1.5 pu at the open end of long EHV lines for hundreds of milliseconds to seconds longer than switching transients and shorter than steady-state conditions. Surge arresters must withstand this TOV without thermal runaway, and line protection may need overvoltage elements (ANSI 59) with time delays coordinated with arrester capability. Load rejection studies combine EMT models for the first cycles with dynamic models for generator response over the following seconds.


10C. Single-pole switching and neutral reactors


Many long EHV lines use single-pole tripping and reclosing to maintain synchronism during single-line-to-ground faults, which are the large majority of EHV faults. When one phase is opened, it remains capacitively coupled to the two energized phases, which sustain a secondary arc at the fault location. On shunt-compensated lines, the phase reactors and the line's interphase capacitance can also form a resonant circuit in the open phase.


A four-reactor scheme three phase reactors plus a neutral reactor between the reactor neutral and ground neutralizes the interphase capacitance. Using positive-sequence susceptance B1 and zero-sequence susceptance B0 of the line (totals for the compensated section), the phase reactor reactance Xp is set by the compensation degree, and the zero-sequence reactance X0 of the bank is chosen so that:

Worked example

For the 217-mile, 345 kV line, assume B1 = 4.5 µS/km and B0 = 2.9 µS/km, giving totals of 1.575 mS and 1.015 mS. For 70% compensation with all reactors at one end (simplified):

Step Calculation Result
Phase reactor susceptance 0.70 × 1.575 mS 1.103 mS
Phase reactor reactance Xp 1 ÷ 1.103 mS ≈ 907 Ω
Required 1 ÷ X0 1.103 − (1.575 − 1.015) mS 0.543 mS
Zero-sequence reactance X0 1 ÷ 0.543 mS ≈ 1,843 Ω
Neutral reactor Xn (1,843 − 907) ÷ 3 ≈ 312 Ω

The neutral reactor is about one-third of the phase reactor reactance, a typical ratio. Its continuous current is small, but it must be rated for the zero-sequence current during faults and open-phase conditions and insulated for the neutral voltage. In practice the neutral reactor is often detuned slightly from full neutralization to avoid exact resonance with variations in line parameters, and the final design is confirmed by EMT secondary arc studies with frequency-dependent line models.


10D. Interaction with series compensation


Long US lines are sometimes series compensated to increase transfer capability. Series capacitors reduce the effective series reactance of the line, which slightly reduces the Ferranti rise at no load, because the charging current flows through less net inductance. However, series compensation brings its own concerns: subsynchronous resonance with nearby turbine generators, subsynchronous control interaction with inverter-based resources, protection challenges and higher transient recovery voltage for line breakers. When a long line is both shunt- and series-compensated, the reactor sizing, series capacitor protection and switching sequence must be studied together.


10E. Field verification



Model predictions for long-line energization can and should be checked in the field.

Measurement What it confirms
Sending- and receiving-end voltages during open-ended energization, from relays or PMUs Steady-state Ferranti rise and source-side rise match the model
Line charging current at the sending end Line capacitance matches line constants calculations
Transient recordings from digital fault recorders during energization Switching overvoltage magnitudes and wave shapes
Reactor currents and voltages Reactor ratings and compensation degree
Light-load voltage trends from SCADA Light-load voltage control strategy

Differences between measured and calculated values usually point to incorrect line constants (for example, conductor or ground wire data), unmodeled equipment (station capacitor banks, reactors) or different source strength than assumed. Correcting the model after the first energization improves every later study on the same corridor.



11. Common misconceptions corrected

Misconception Engineering reality
"The Ferranti effect only matters on lines longer than 300 miles." At 60 Hz, a 200 mile 345 kV line already rises about 9%, enough to approach or exceed maximum operating voltage when the sending end is high.
"50 Hz study results apply to US lines." US lines have 20% more electrical length at 60 Hz; the Ferranti rise is roughly 45% to 50% larger for the same length.
"Voltage rise is (Vr − Vs) ÷ Vs, so the sending end is fixed." The sending-end bus also rises because of charging current through the source impedance. Equipment ratings must use the actual open-end voltage.
"A more detailed line model gives a more accurate Ferranti rise." For 60 Hz steady state, an equivalent pi model is exact. Detailed models matter for transients, not steady-state rise.
"Doubling the circuits doubles the Ferranti rise." The per-unit open-end rise of each circuit is unchanged with a stiff source; the source-side rise roughly doubles.
"Shunt reactors only cost transfer capability." Reactors are often the cheapest way to make a long line operable at all and to protect equipment during energization.
"If the steady state rise is acceptable, energization is safe." Switching transients can more than double the instantaneous voltage; EMT energization studies are required for EHV lines.

12. Key takeaways


  1. The Ferranti rise is a no-load, light-load phenomenon caused by line charging current flowing through series inductance.
  2. At 60 Hz, the rise for a long line is roughly 45% higher than at 50 Hz.
  3. Use the exact long-line equations: VR ÷ VS = 1 ÷ cos(βℓ). The (βℓ)² ÷ 2 approximation underestimates the rise.
  4. Include the source. Weak sources and double circuits raise the sending end and the open-end voltage further.
  5. Every model agrees in steady state; choose the model for the transients. Frequency-dependent models are preferred for switching and resonance studies.
  6. Shunt reactors, energization practice and controlled switching are complementary mitigations.


13. How Keentel Engineering helps


Keentel Engineering performs transmission planning, EMT, insulation coordination and interconnection studies for utilities, transmission developers, renewable developers, data center owners and independent power producers, from 69 kV to 765 kV.

Stage Keentel scope Outcome
Line constants and modeling Positive-, zero-sequence and mutual parameters; frequency-dependent line and cable models Accurate models for every study type
Steady-state and light-load studies Ferranti rise, voltage profiles, light-load voltage control, NERC TPL-001 cases Voltages within limits in all credible conditions
Reactive compensation design Shunt reactor sizing, arrangement and switching; SVC, STATCOM and synchronous condenser evaluation Cost-effective compensation that preserves transfer capability
EMT energization and reclosing studies Statistical switching, pre-insertion resistor and controlled switching evaluation, trapped charge Switching overvoltages within insulation design
Insulation coordination IEEE 1313 analysis, arrester selection (IEEE C62.11), clearance verification Reliable insulation and arrester performance
Restoration and black-start studies Cranking path studies, self-excitation checks, NERC EOP-005 support Restoration plans that work in practice
Cable systems Charging, compensation, energization and resonance studies for HV and EHV cables Safe, compliant cable interconnections

Why clients choose Keentel Engineering


  • EHV transmission expertise: practical experience with 230 kV, 345 kV, 500 kV and 765 kV lines and substations.
  • EMT depth: frequency-dependent line and cable modeling for energization, TRV and resonance studies.
  • US standards and utility practice: IEEE, NERC and ISO/RTO requirements applied correctly to 60 Hz systems.
  • Planning to operations: from line design and compensation to operating procedures and restoration plans.
  • Licensed professional engineering: a Florida-registered firm with offices in Tampa, Austin, Sacramento and Baltimore, supporting projects nationwide.

Planning a long transmission line, an EHV cable or a restoration path? Talk to Keentel Engineering at (813) 389-7871, contact@keentelengineering.com, or book a 15-minute scoping call at calendly.com/keentel-engineering/15min.


Part C — Case Studies

The following are illustrative scenarios based on conditions typical of US transmission projects. They show how Keentel Engineering approaches Ferranti-effect and line-energization problems; site details are generalized and figures are rounded.


Case Study 1 — 345 kV renewable export line: energizing from the weak end


Situation


A transmission developer plans a 190-mile, 345 kV double-circuit line connecting a cluster of wind and solar plants to a load-center substation. The initial design includes 40% shunt compensation using bus-connected reactors at the load-center end. The renewable-end substation has a relatively weak source when the plants are offline.


Analysis


Keentel's study shows that energizing the line from the renewable end at night a likely operating scenario during restoration after an outage produces an open-end voltage of about 1.12 pu relative to the source voltage, because the bus-connected reactors at the far end are not connected to the open line, and the weak source adds a sending-end rise of about 4% when both circuits are energized. EMT studies show statistical switching overvoltages above the insulation design target for energization from that end.


Engineered solution


Keentel recommends converting the reactors to line-connected units split between both ends, raising total compensation to about 65%, and specifying controlled switching on the line breakers. Operating procedures are revised to require energization from the load-center end, with the renewable-end energization allowed only with a reduced sending-end voltage.


Outcome


Open-end voltages stay below 362 kV in all studied energization scenarios, switching overvoltages fall within the insulation design, and the transmission owner approves the revised design without changes to tower clearances.


Case Study 2 — Black-start restoration over a 230 kV cranking path


Situation


A utility's restoration plan uses a combustion turbine black-start unit to energize a 230 kV cranking path of about 110 miles of overhead line to reach a large steam unit's station service. A restoration drill simulation shows the black-start unit reaching its underexcitation limit as the line is energized.


Analysis


Keentel models the cranking path in steady state and EMT. The line charging of about 33 Mvar, plus the step-up transformer magnetizing behavior and the generator's limited underexcited capability, leaves little margin. The open-end Ferranti rise is modest at this length, but the generator is near self-excitation conditions, and energizing the step-up transformer at the far end produces harmonic-rich inrush with a temporary overvoltage risk.


Engineered solution


Keentel recommends a revised energization sequence: energize the line in two segments, place a 230 kV station reactor in service before the second segment, pick up a block of station service load at an intermediate substation, and lower the generator terminal voltage before closing. EMT studies confirm acceptable transformer energization overvoltages with the revised sequence.


Outcome


The restoration plan is updated for NERC EOP-005 compliance, the next drill succeeds within generator limits, and operators gain a clear, studied energization sequence.


Case Study 3 — 230 kV underground cable for a hyperscale data center campus



Situation


A data center developer plans a 12-mile, 230 kV underground XLPE cable from a utility substation to its campus substation. The utility's interconnection study flags high voltages at the utility substation under light load and asks the developer to address reactive compensation.


Analysis


Keentel calculates cable charging of about 50 Mvar. The open-end Ferranti rise along the cable is small, but the charging raises the utility substation voltage by about 1.5% at minimum load, and the campus's light-load periods — commissioning, partial build-out — leave the cable largely uncompensated. Frequency-dependent cable models show a low-order parallel resonance near the 6th harmonic with the utility source, relevant to the campus's power electronics.


Engineered solution


Keentel specifies a 40 Mvar switched shunt reactor at the campus substation, with a control scheme that keeps it in service at light load and removes it as campus load grows. Harmonic and energization studies confirm acceptable resonance and transient performance with the reactor in either state.


Outcome


The utility accepts the compensation design, the campus energizes without voltage violations, and the reactor control adapts to load growth across the build-out.


Part D — Technical FAQ: The Ferranti Effect

The rise in voltage at the receiving end of a long transmission line or cable above the sending-end voltage under no load or light load, caused by line charging current flowing through the line's series inductance.

Charging current leads the voltage by 90°. The voltage drop across an inductance carrying a leading current is in phase with, and adds to, the voltage, producing a rise.

Use VR ÷ VS = 1 ÷ cosh(γℓ), or approximately 1 ÷ cos(βℓ) for low-loss lines, where β ≈ ω√(lc) and ℓ is the line length.

The rise is approximately (βℓ)² ÷ 2. At 60 Hz, β is about 12° per 100 miles for overhead lines. The estimate underestimates the rise for long lines.

About 11% at 60 Hz with a stiff source, taking 345 kV to about 383 kV — above the 362 kV maximum operating voltage.

Electrical length is proportional to frequency, so the same line is 20% longer electrically at 60 Hz, and the rise scales roughly with the square of electrical length.

Charging current through the source impedance raises the sending-end voltage. A weaker source produces a higher open-end voltage relative to the system's internal voltage.

No. Each circuit's per-unit rise depends on its own electrical length. Energizing both circuits does double the charging drawn from the source, roughly doubling the source-side rise.

The load at which a line's reactive generation equals its reactive consumption, producing a flat voltage profile. SIL = V² ÷ Zc. Below SIL, voltage rises toward the receiving end.

For steady-state rise, an equivalent pi model in a load flow program is exact at 60 Hz. For energization transients, use Bergeron or preferably frequency-dependent models.

A single nominal pi section lumps distributed parameters and slightly overestimates the rise for long lines. Cascading sections or using the equivalent pi model removes the error.

It represents frequency-dependent resistance and inductance, especially zero-sequence earth-return effects, and coupling between circuits, giving realistic transient damping and wave shapes.

Unmitigated EHV line energization commonly produces 2.0 to 2.8 pu statistical switching overvoltages, and more with trapped charge during reclosing. Keentel's simplified model gave about 2.2 pu for closing at voltage peak.

They absorb part of the line's charging current, reducing the leading current flowing through the series inductance. In Keentel's model, 70% compensation reduced the rise from 11.1% to 3.2%.

Typically 50% to 80% for long EHV lines, chosen to control no-load voltage while preserving transfer capability and avoiding resonance in open phases.

Highly compensated lines can resonate in an open phase during single-pole tripping, sustaining secondary arc current or creating overvoltage. Neutral reactors are used to mitigate this.

An uncontrolled voltage rise when a generator energizes a line whose capacitive charging exceeds the generator's underexcited capability, a key risk in black-start restoration.

Yes, and cables have much higher charging current per mile. Their open-end rise may be small for short lengths, but charging affects source voltages, ampacity and compensation.

IEEE 1313.1 and 1313.2 (insulation coordination), IEEE C62.11 (arresters), IEEE C57.21 (shunt reactors), IEEE C37.06 and C37.09 (breakers), and NERC TPL-001, VAR-001, VAR-002 and EOP-005.

Calculating the rise relative to a fixed sending-end voltage at a stiff source, using 50 Hz results, and ignoring switching transients and the energization direction.


References and Further Reading

Links were current at publication (October 2026).


  • IEEE Std 1313.1, Standard for Insulation Coordination — Definitions, Principles, and Rules. IEEE.
  • IEEE Std 1313.2, Guide for the Application of Insulation Coordination. IEEE.
  • IEEE Std C62.11, Standard for Metal-Oxide Surge Arresters for AC Power Circuits (>1 kV). IEEE.
  • IEEE Std C57.21, Standard Requirements, Terminology, and Test Code for Shunt Reactors Rated Over 500 kVA. IEEE.
  • IEEE Std C37.06 and C37.09, AC High-Voltage Circuit Breakers: Preferred Ratings and Test Procedures. IEEE.
  • NERC Reliability Standards TPL-001, VAR-001, VAR-002 and EOP-005. North American Electric Reliability Corporation.
  • EPRI, Transmission Line Reference Book: 345 kV and Above (the "Red Book"). Electric Power Research Institute.
  • J. D. Glover, T. J. Overbye and M. S. Sarma, Power System Analysis and Design. Cengage.
  • H. W. Dommel, EMTP Theory Book. Bonneville Power Administration and Microtran Power System Analysis Corporation.
  • A. Morched, B. Gustavsen and M. Tartibi, "A Universal Model for Accurate Calculation of Electromagnetic Transients on Overhead Lines and Underground Cables," IEEE Transactions on Power Delivery, 1999.
  • J. R. Martí, "Accurate Modelling of Frequency-Dependent Transmission Lines in Electromagnetic Transient Simulations," IEEE Transactions on Power Apparatus and Systems, 1982.

Disclaimer

This article is general technical information for educational purposes. It is not engineering advice for any specific project and does not create a professional relationship. The results presented come from Keentel Engineering's simplified models with typical line parameters; actual voltage rise, switching overvoltages and compensation requirements depend on project-specific line geometry, conductors, sources, equipment and operating conditions and must be verified by detailed study. Designs must follow current IEEE standards, the NESC, NERC requirements, utility and transmission provider criteria and project-specific engineering analysis, sealed by a licensed professional engineer where required.



Case studies are illustrative scenarios based on typical project conditions, not records of specific client projects. Figures are rounded and indicative.


IEEE, NERC, EPRI and other names are the property of their respective owners. Keentel Engineering is not affiliated with or endorsed by these organizations or any software or equipment vendor.

Office Address Phone
Head Office — Tampa 400 N Ashley Dr STE #2600, Tampa FL 33602 (813) 389-7871
Austin 5900 Balcones Drive STE 100, Austin TX 78731 (512) 591-0752
Sacramento 1401 21st St Ste R, Sacramento CA 95811 (916) 913-4524
Baltimore 306 W Redwood St STE 200, Baltimore MD 21201 (410) 225-2181


A smiling man with glasses and a beard wearing a blue blazer stands in front of server racks in a data center.

About the Author:

Sandip "Sonny" R. Patel, P.E.

IEEE Senior Member · Founder & CEO, Keentel Engineering

In 1995, Sonny Patel earned his Electrical Engineering degree from the University of Illinois. But degrees don't build legacies — action does.

For three decades, he has worked the power industry from every side of the table: 16 years as a utility engineer at Exelon/Commonwealth Edison; generation leadership across hydroelectric, industrial steam turbine, and a 9 GW renewable fleet; NERC Regional Entity Senior Compliance Engineer and Audit Team Lead, auditing some of the nation's largest utilities; and testing and commissioning lead on equipment up to 765 kV — the very top of the North American grid.Utility. Generator. Regulator. Consultant. Few engineers have seen all four seats. Fewer still have sat in them.

His experience spans nuclear, hydro, conventional generation, renewables, oil and gas, mining — and today's data centers, where he is authoring a three-book series on data center design. He is a Licensed Professional Engineer in six states and a Licensed Electrical Contractor in Florida (Unlimited EC) — he doesn't just design the work; he's qualified to stand behind its execution.Today, as Founder and CEO of Keentel Engineering, Sonny leads a nationwide team of engineers delivering substation design, power system studies, NERC compliance, and commissioning — done right, coast to coast.Three decades. Every side of the table. One standard: accountable engineering.

Four workers in safety vests and helmets stand with arms crossed near wind turbines.

Let's Discuss Your Project

Let's book a call to discuss your electrical engineering project that we can help you with.

Man in a blazer and open shirt, looking at the camera, against a blurred background.

About the Author:

Sandip "Sonny" R. Patel, P.E.

IEEE Senior Member · Founder & CEO, Keentel Engineering

In 1995, Sonny Patel earned his Electrical Engineering degree from the University of Illinois. But degrees don't build legacies — action does.

For three decades, he has worked the power industry from every side of the table: 16 years as a utility engineer at Exelon/Commonwealth Edison; generation leadership across hydroelectric, industrial steam turbine, and a 9 GW renewable fleet; NERC Regional Entity Senior Compliance Engineer and Audit Team Lead, auditing some of the nation's largest utilities; and testing and commissioning lead on equipment up to 765 kV — the very top of the North American grid.

Utility. Generator. Regulator. Consultant. Few engineers have seen all four seats. Fewer still have sat in them.

His experience spans nuclear, hydro, conventional generation, renewables, oil and gas, mining — and today's data centers, where he is authoring a three-book series on data center design. He is a Licensed Professional Engineer in six states and a Licensed Electrical Contractor in Florida (Unlimited EC) — he doesn't just design the work; he's qualified to stand behind its execution.

Today, as Founder and CEO of Keentel Engineering, Sonny leads a nationwide team of engineers delivering substation design, power system studies, NERC compliance, and commissioning — done right, coast to coast.Three decades. Every side of the table. One standard: accountable engineering.

Leave a Comment

Related Posts

Grid flexibility load duration curve showing peak demand reduction and capacity needs
By SANDIP R PATEL • November 22, 2026
Explore dependable grid flexibility with battery storage, virtual power plants, managed EV charging and flexible loads to cut peak demand and grid costs.
Temporary vs transient overvoltages chart showing TOV, lightning, switching and insulation limits
By SANDIP R PATEL • November 22, 2026
Compare temporary vs transient overvoltages, including TOV, lightning and switching surges, insulation coordination, surge arresters and NERC PRC-026.
87T vs 87N restricted earth fault protection sensitivity comparison for power transformers
By SANDIP R PATEL • November 22, 2026
Compare 87T transformer differential and 87N restricted earth fault protection, including fault sensitivity, relay settings and resistance-grounded transformers.
PRC-029-1 and IEEE 2800 voltage ride-through curve showing IBR protection and PPC response
By SANDIP R PATEL • November 22, 2026
Explore PRC-029-1 and IEEE 2800 requirements for solar, BESS and hybrid IBR plants, including ride-through settings, PPC tuning, EMT studies and commissioning.
Wind-resilient ground-mount solar PV fragility curves showing tracker damage risks at high wind spee
By SANDIP R PATEL • November 22, 2026
Learn how wind-resilient ground-mount solar PV design reduces storm damage through tracker stow reliability, fragility analysis, loss modeling and recovery planning.
AI-driven grid monitoring precision and recall chart for resilient clean-energy power systems
By SANDIP R PATEL • November 22, 2026
Explore AI grid monitoring for solar, BESS and microgrids with machine learning, computer vision and predictive maintenance to reduce downtime and risk.
Power Swing Blocking, Out-of-Step Tripping and NERC PRC-026: How Distance Relays Tell Swings from Fa
By SANDIP R PATEL • November 14, 2026
Learn power swing blocking, out-of-step tripping, distance relay settings and NERC PRC-026 compliance with Keentel Engineering's technical guide.
NEC 2026 Field Guide showing electrical code changes for load calculations, grounding, energy manage
By SANDIP R PATEL • November 14, 2026
Explore NEC 2026 changes to load calculations, grounding, ampacity, wiring, solar, ESS and EV systems with Keentel Engineering's practical field guide. Copy
Data Center Tiers I–IV comparison showing redundancy, concurrent maintainability and fault tolerance
By SANDIP R PATEL • November 14, 2026
Explore Data Center Tiers I–IV, N+1 vs. 2N redundancy, concurrent maintainability, fault tolerance, and MEP design requirements with Keentel Engineering.
