Grid Inertia, RoCoF and Frequency Response: An Engineering Guide for the US Power System

Grid inertia and RoCoF comparison showing frequency response, inertial power, and grid stability after a 2,750 MW generation loss.
Calendar icon. D

October 11, 2026 | Blog

Part A — Grid Inertia at a Glance

When a large generator trips, the power system loses supply instantly, but load keeps consuming. For the first moments, before any control system can react, the missing power comes from the kinetic energy stored in the rotating masses of synchronous generators and their turbines. As they give up that energy, they slow down, and system frequency falls. The amount of stored rotating energy, the system inertia, sets how fast frequency falls. Governors and other frequency-responsive resources then arrest the decline. Inertia buys time; primary frequency response uses it.


Same loss, half the inertia


Keentel Engineering modeled two 60 Hz systems, each serving 50 GW of load, with identical governors and load characteristics. The only difference is the stored rotating energy. Both lose 2,750 MW of generation, equal to ERCOT's resource loss criterion.

Result Grid A: 250 GW·s Grid B: 125 GW·s
System inertia constant (on 50 GW) H = 5.0 s H = 2.5 s
Initial rate of change of frequency (RoCoF) 0.33 Hz/s 0.66 Hz/s
Time to reach 59.3 Hz at the initial RoCoF ≈ 2.1 s ≈ 1.1 s
Frequency nadir (lowest point) ≈ 59.53 Hz at 2.7 s ≈ 59.41 Hz at 1.7 s
Margin above a 59.3 Hz first UFLS stage ≈ 0.23 Hz ≈ 0.11 Hz
Settling frequency before AGC ≈ 59.66 Hz ≈ 59.66 Hz

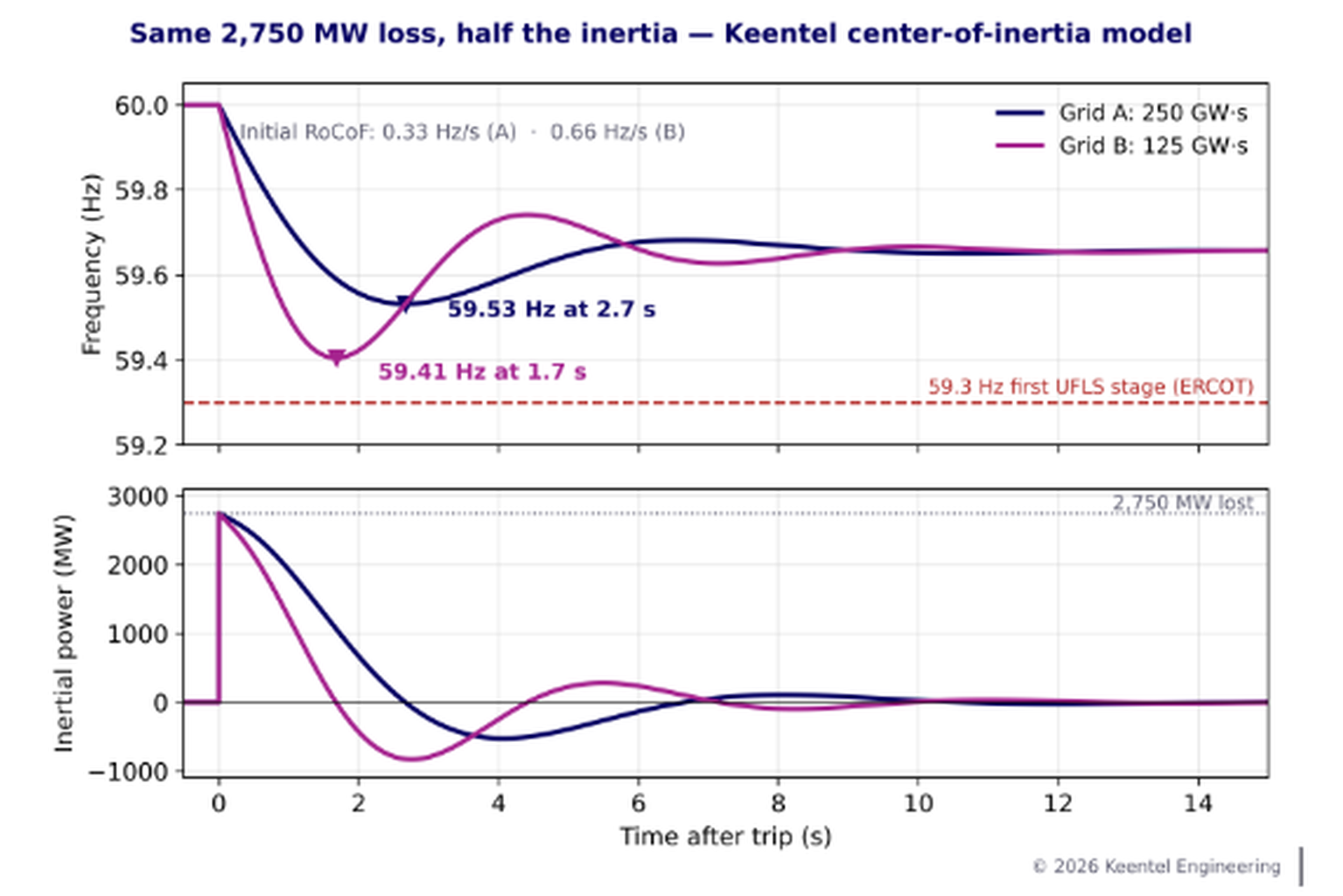

Figure 1. Frequency (top) and power supplied by rotating inertia (bottom) after the same 2,750 MW loss in two systems that differ only in inertia. Below zero, the rotors are absorbing energy as they speed back up.


What the comparison shows


  • The initial RoCoF doubles exactly when inertia halves. At the instant of the trip it depends only on the lost power and the stored rotating energy.
  • At t = 0, all of the missing power comes from inertia in both systems. Governors have not yet moved.
  • The nadir is lower and arrives sooner with less inertia, because governors have less time to respond.
  • The settling frequency is the same. It depends on governor droop and load sensitivity, not on inertia.

Inertia buys time. Governors use it. As inverter-based resources displace synchronous generation, the same trip produces a faster fall and leaves less time to stop it.


Part B — Grid Inertia, RoCoF and Frequency Response: An Engineering Guide for the US Power System

Frequency is the heartbeat of an interconnection. Every US interconnection — Eastern, Western, ERCOT and Québec — must keep frequency close to 60 Hz and arrest it quickly after the largest credible loss of generation. For most of the history of the grid, that was helped by massive synchronous machines whose rotating inertia slowed frequency decline automatically. Today, wind, solar and battery storage connect through inverters, and their share of online generation keeps growing. This guide explains what inertia is, how it determines the first seconds of a frequency event, how to calculate RoCoF, nadir and settling frequency, and what engineers can do as synchronous inertia declines.


What is inertia?


Every synchronous generator and its turbine form a heavy flywheel rotating in step with the grid. The kinetic energy stored in that rotor is commonly expressed by the inertia constant H, in seconds:

where Ek is the stored kinetic energy, J is the moment of inertia of the rotating mass, ωm is mechanical speed and S is the machine rating. H is the number of seconds the machine could supply its rated power from stored kinetic energy alone.



Typical inertia constants

Machine type Typical H (s, on machine MVA)
Large steam turbine-generator (nuclear, coal) 3 to 6
Combustion turbine 4 to 9
Combined-cycle steam turbine 3 to 5
Hydro generator 2 to 4
Synchronous condenser 1 to 2, or 5 to 8 with an added flywheel
Wind turbine (Type 3 or Type 4, inverter-coupled) No inherent synchronous inertia; synthetic response possible
Solar PV and battery storage (grid-following) None

System inertia



System stored energy is the sum over all online synchronous machines:

It is often reported in GW·s (equivalently, gigawatt-seconds or GJ). Because only online machines count, system inertia changes hour by hour with commitment and dispatch. Low-load, high-renewable hours, such as spring middays and windy nights, usually have the lowest inertia.

Online unit (illustrative) Rating (MVA) H (s) Stored energy (GW·s)
Nuclear unit 1,350 4.0 5.40
Coal unit 800 3.5 2.80
2×1 combined cycle (two CTs at 250 MVA, one ST at 300 MVA) 800 — 4.20
Hydro unit 150 3.0 0.45
Synchronous condenser (no flywheel) 250 1.5 0.38
300 MW solar plant 330 0 0
200 MW grid-following battery 220 0 0

The swing equation and initial RoCoF



The center-of-inertia form of the swing equation relates frequency change to the power imbalance:

Immediately after a loss of ΔP, before any governor or load response, the initial RoCoF is:

For Grid A: 2,750 MW × 60 Hz ÷ (2 × 250,000 MW·s) = 0.33 Hz/s. For Grid B, with half the stored energy, the result is exactly double: 0.66 Hz/s. This relationship is exact at t = 0 in the aggregate model, because no other term has yet changed.


How much power comes from inertia?



The power released by the rotating masses is proportional to the rate of frequency decline:

At t = 0, inertial power equals the full 2,750 MW in both systems. As governors and load relief begin to supply power, the RoCoF falls and inertial power declines. At the nadir, RoCoF is zero and inertia supplies nothing. After the nadir, frequency recovers and the rotors absorb energy as they speed back up, so inertial power briefly becomes negative.


A simple time buffer



Dividing the frequency margin by the initial RoCoF gives a conservative measure of how much time the system has:

With a 59.3 Hz first UFLS stage, Grid A has about 0.7 ÷ 0.33 ≈ 2.1 s and Grid B about 0.7 ÷ 0.66 ≈ 1.1 s. In reality frequency slows as response arrives, so the actual nadir is higher, but the comparison shows how quickly the available time shrinks.


Frequency nadir: where inertia and response meet


The nadir is the lowest frequency reached after the disturbance. It occurs when the combined response of governors, load relief and any fast frequency response equals the lost power. The nadir depends on:


  • Inertia: how quickly frequency falls before response arrives.
  • Response speed: governor and turbine time constants, deadbands and response delays.
  • Response amount: headroom on units with active governors.
  • Load relief: motor loads draw less power at lower frequency, typically about 1 to 2% of load per 1% frequency change.
  • Fast frequency response: batteries, load resources and other resources that inject or shed power within a fraction of a second.


In Keentel's model, halving inertia moved the nadir from about 59.53 Hz to about 59.41 Hz and brought it a full second sooner. Further reductions bring the nadir to the UFLS threshold:

System stored energy Nadir without FFR Nadir with 1,000 MW FFR (trigger 59.7 Hz, full output in 0.25 s)
250 GW·s ≈ 59.53 Hz at 2.7 s ≈ 59.63 Hz
125 GW·s ≈ 59.41 Hz at 1.7 s ≈ 59.55 Hz
100 GW·s ≈ 59.36 Hz at 1.5 s ≈ 59.51 Hz
80 GW·s ≈ 59.30 Hz at 1.3 s ≈ 59.47 Hz

Even modest amounts of fast frequency response restore much of the nadir margin lost when inertia declines.


Settling frequency: governed by droop, not inertia



After the nadir, frequency settles at a level determined by the total frequency response characteristic of the interconnection, before automatic generation control (AGC) restores 60 Hz:

where β is the frequency response in MW/Hz, D is load damping and R is governor droop. In the model, β is about 8,300 MW/Hz, so the 2,750 MW loss settles about 0.33 Hz below nominal, near 59.67 Hz, in both systems. Inertia does not appear in this equation. It changes the path, not the destination.



NERC Reliability Standard BAL-003 sets a frequency response obligation for each balancing authority, expressed in MW per 0.1 Hz, to ensure the interconnection settles above under-frequency load shedding thresholds for its design-basis resource loss.


The US frequency protection framework

Mechanism Purpose US reference
Primary frequency response Governors and IBR controls arrest and stabilize frequency within seconds NERC BAL-003; FERC Order No. 842 requires primary frequency response capability from new generators
Fast frequency response Very fast power injection or load reduction, typically within 0.5 s or less ERCOT FFR and Responsive Reserve products; NERC fast frequency response guidance
Under-frequency load shedding Automatic load shedding in stages to prevent collapse NERC PRC-006 and regional UFLS programs; ERCOT's first stage is 59.3 Hz
Generator and IBR ride-through Keep resources online during frequency excursions and high RoCoF NERC PRC-024, PRC-029; IEEE 2800-2022 for transmission-connected IBRs; IEEE 1547-2018 for DERs
AGC Restores frequency and scheduled interchange over minutes NERC BAL-001

RoCoF and ride-through


High RoCoF creates problems beyond the nadir. Older RoCoF-based anti-islanding relays (device 81R) at distributed generation can trip unnecessarily, removing more generation. IEEE 2800-2022 requires transmission-connected inverter-based resources to ride through RoCoF values up to 5 Hz/s, and IEEE 1547-2018 specifies RoCoF ride-through capability by DER performance category. Ride-through settings must be coordinated so the resources the grid depends on do not trip during the very event they are meant to help.


Why it matters now


Inverters do not add synchronous inertia


Wind, solar and battery storage connect through power electronic inverters. Most operate in grid-following mode: they synchronize to the measured grid voltage with a phase-locked loop and inject controlled current. They have no rotating mass coupled to the grid and provide no inherent inertia. As inverter-based output displaces synchronous units, the same trip produces a faster frequency fall.


Smaller interconnections feel it first


The Eastern Interconnection has very high inertia because of its size. ERCOT, a smaller interconnection with limited DC ties and very high wind and solar penetration, is more sensitive. ERCOT monitors system inertia in real time and has identified a critical inertia level, roughly 100 GW·s, below which existing reserves may not prevent UFLS for its resource loss criterion. It has responded with fast frequency response products, load resources and procurement changes.


Options for replacing synchronous inertia

Option What it provides Engineering considerations
Keep synchronous units online Inertia, short-circuit strength, voltage support Cost of must-run commitments and emissions
Synchronous condensers Inertia and short-circuit strength without fuel New units or converted retired generators; added flywheels increase inertia
Grid-forming inverters Voltage-source behavior, fast inherent response, synthetic inertia Current and energy limits; IEEE 2800 and emerging ISO/RTO grid-forming requirements; EMT studies required
Fast frequency response from batteries Very fast active power injection Trigger settings, response time, sustained duration, state-of-charge management
Load resources Very fast load reduction on under-frequency relays Customer participation and verification
Synthetic inertia from wind turbines Short-term power boost from rotor kinetic energy Recovery period reduces output after the event
Faster primary frequency response Faster governor and IBR droop response Headroom, deadband settings and verification under BAL-003

How much does each option help?



The scale of each option matters. Three 350 MVA synchronous condensers with flywheels at H ≈ 6 s add about 6.3 GW·s, a 5% increase on a 125 GW·s system. A 200 MVA grid-forming battery emulating H = 8 s provides inertial power proportional to RoCoF:

At 0.66 Hz/s, that is about 2 × 8 × 200 ÷ 60 × 0.66 ≈ 35 MW. The same battery delivering fast frequency response could provide its full 200 MW within a fraction of a second. In practice, the most effective solutions combine inertia, grid-forming behavior and fast frequency response, selected through studies of the specific system.


Studying frequency performance


Frequency studies combine several tools:


  1. Aggregate frequency models: center-of-inertia models, like the one in this article, give quick insight into RoCoF, nadir and reserve needs.
  2. Positive-sequence dynamic simulation: PSS®E or PSLF simulations with detailed generator, governor, IBR (WECC REGC/REEC/REPC) and load models.
  3. EMT studies: PSCAD studies verify grid-forming behavior, inverter current limits and protection performance during high-RoCoF events.
  4. Real-time inertia monitoring: operators track online stored energy and compare it with critical levels.
  5. Event analysis: PMU and DFR data from actual disturbances validate models and settings.

On its own, inertia does not change where primary response settles frequency. It changes how fast frequency falls and how much time every other resource has to stop it.

How Keentel Engineering helps



Keentel Engineering provides frequency, stability and interconnection studies for utilities, ISOs and RTOs, independent power producers and large loads, from 4 kV to 765 kV.

Stage Keentel scope Outcome
Frequency response studies Aggregate and detailed dynamic studies of RoCoF, nadir and settling frequency; BAL-003 support Clear understanding of system frequency risk
Grid-forming and FFR projects BESS sizing, control settings, FFR qualification studies and EMT modeling Batteries that meet market and grid requirements
Synchronous condenser projects Feasibility, sizing, generator conversion studies and interconnection Added inertia and system strength where it is needed
Interconnection studies PSS®E and PSCAD studies for solar, wind and storage at 115 kV to 345 kV Faster, more reliable interconnection approvals
Ride-through and protection PRC-024, PRC-029, IEEE 2800 and IEEE 1547 ride-through assessments; UFLS and RoCoF relay coordination Resources that stay online when the grid needs them
Microgrids and large loads Islanded frequency studies for data centers and industrial campuses Stable operation during load steps and islanding

Why clients choose Keentel Engineering


  • Deep power system expertise: stability, frequency, EMT and protection studies delivered by experienced power system engineers.
  • From studies to design: one team covers dynamic studies, substation and transmission design, and commissioning support.
  • NERC compliance experience: practical support for BAL, PRC and MOD standards.
  • Licensed professional engineering: a Florida-registered firm with offices in Tampa, Austin, Sacramento and Baltimore, supporting projects nationwide.
  • Independent advice: recommendations based on system needs, not on a single technology or vendor.

Planning a battery, synchronous condenser or large load in a low-inertia area? Talk to Keentel Engineering at (813) 389-7871, contact@keentelengineering.com, or book a 15-minute scoping call at calendly.com/keentel-engineering/15min.


Part C — Case Studies

The following are illustrative scenarios based on conditions typical of US power systems. They show how Keentel Engineering approaches inertia and frequency response problems; site details are generalised and figures are rounded.


Case Study 1 — 300 MW battery at 345 kV: qualifying for fast frequency response


Situation


A developer plans a 300 MW / 600 MWh battery connected at 345 kV in a high-renewable region and wants it to qualify for fast frequency response and responsive reserve products.


Analysis


Keentel models the plant's frequency measurement, trigger logic, response time and ride-through behavior. EMT simulations show that the original control settings would reach full output too slowly at the plant's point of interconnection, and that a protective RoCoF setting would trip the plant during severe low-inertia events.


Engineered solution


Keentel recommends revised frequency measurement filtering, faster power ramp settings and RoCoF ride-through settings consistent with IEEE 2800-2022. A state-of-charge strategy reserves energy for the required response duration.


Outcome


The plant meets the response-time requirement in simulation and testing and remains online for RoCoF events well beyond credible system values.


Case Study 2 — 230 kV system: converting a retiring coal unit to a synchronous condenser


Situation


A utility is retiring a coal unit at a 230 kV plant in an area with growing solar and wind generation. Studies show that the retirement would reduce local inertia and short-circuit strength, increasing RoCoF and creating weak-grid concerns for nearby inverter-based plants.


Analysis


Keentel evaluates three options: a new synchronous condenser, conversion of the existing generator to a synchronous condenser, and grid-forming batteries. Dynamic and short-circuit studies compare inertia, system strength, voltage support and cost.


Engineered solution


Conversion of the existing generator, with a clutch to decouple the turbine and a starting system, provides inertia and short-circuit strength using existing interconnection facilities. A grid-forming battery is recommended as a later complement.


Outcome


Local system strength is maintained after the retirement, nearby inverter-based plants meet stability criteria, and the utility reuses its existing 230 kV interconnection.


Case Study 3 — data center campus at 13.8 kV: islanded frequency stability


Situation


A data center campus with on-site gas generation at 13.8 kV plans to operate in island mode during grid outages. AI training workloads can change campus load by tens of megawatts in seconds.


Analysis


Keentel's islanded dynamic study shows that the small on-site generator fleet has limited inertia. Large load steps produce high RoCoF and frequency deviations that could trip generators on under-frequency protection or disrupt sensitive IT equipment.


Engineered solution


A grid-forming battery is added to supply fast power during load steps, with coordinated load ramp limits in the facility controls and revised generator protection and UFLS settings for island operation.


Outcome


The campus maintains frequency within its design limits during the largest credible load steps, and the generators remain online during island operation.


Part D — Technical FAQ: Grid Inertia, RoCoF and Frequency Response

  • 1. What is power system inertia?

    Inertia is the kinetic energy stored in the rotating masses of synchronous generators and motors connected to the grid. When supply and demand become unbalanced, this energy is released or absorbed automatically, slowing the rate of frequency change.

  • 2. What is the inertia constant H?

    H is the stored kinetic energy divided by the machine rating, in seconds. It represents how long the machine could supply rated power from stored rotational energy alone. Typical values for large generators are 2 to 9 seconds.

  • 3. What is RoCoF?

    RoCoF is the rate of change of frequency, in Hz per second. Immediately after a generation loss, it equals the lost power times nominal frequency divided by twice the system stored energy.

  • 4. Why does halving inertia double the initial RoCoF?

    At the moment of the trip, the same lost power must come entirely from stored rotating energy. With half the stored energy, the machines must slow down twice as fast to deliver the same power.

  • 5. Does inertia change the settling frequency?

    No. Settling frequency depends on governor droop, load damping and other frequency-responsive resources. Inertia changes how fast frequency falls and how low it goes, not where it settles.

  • 6. What is the frequency nadir?

    The nadir is the lowest frequency reached after a disturbance, occurring when frequency-responsive resources have increased output enough to balance the lost power. It must remain above the first under-frequency load shedding stage.

  • 7. What determines the frequency nadir?

    Inertia, the speed and amount of primary frequency response, load damping, governor deadbands and any fast frequency response. Lower inertia or slower response produces a lower nadir.

  • 8. What is under-frequency load shedding?

    UFLS automatically disconnects blocks of load in stages when frequency falls below set thresholds, preventing a frequency collapse. It is governed by NERC PRC-006 and regional programs. ERCOT's first stage is 59.3 Hz.

  • 9. Why don't solar, wind and batteries provide inertia?

    They connect through inverters and, in grid-following mode, have no rotating mass synchronized to the grid. They can respond quickly through controls, but they do not inherently release stored rotational energy.

  • 10. What is a grid-forming inverter?

    A grid-forming inverter behaves as a controlled voltage source, setting its own voltage and frequency reference rather than following the grid. It can respond inherently to frequency and voltage changes, provide synthetic inertia and support weak or islanded systems, within its current and energy limits.

  • 11. What is fast frequency response?

    Fast frequency response is very fast active power injection or load reduction, typically within 0.5 seconds of a frequency trigger. Batteries and load resources are common providers.

  • 12. How does fast frequency response compare to synthetic inertia?

    Synthetic inertia provides power proportional to RoCoF, which is often modest for a single plant. Fast frequency response can deliver full rated power within a fraction of a second, which can have a larger effect on the nadir.

  • 13. What is a synchronous condenser?

    A synchronous condenser is a synchronous machine running without a prime mover. It provides inertia, short-circuit strength and reactive power. Retired generators can sometimes be converted to synchronous condensers.

  • 14. What is NERC BAL-003?

    BAL-003 sets frequency response obligations for balancing authorities, expressed in MW per 0.1 Hz, so that each interconnection can arrest and stabilize frequency after its design-basis resource loss.

  • 15. What did FERC Order No. 842 require?

    It requires newly interconnecting generators, including inverter-based resources, to have primary frequency response capability with specified droop and deadband settings as part of their interconnection agreements.

  • 16. What RoCoF must inverter-based resources ride through?

    IEEE 2800-2022 requires transmission-connected inverter-based resources to ride through RoCoF up to 5 Hz/s. IEEE 1547-2018 specifies RoCoF ride-through values for distributed resources by performance category.

  • 17. Why is ERCOT especially concerned about inertia?

    ERCOT is a relatively small interconnection with limited DC ties and high wind and solar penetration. Its inertia can fall to low levels during high-renewable, low-load hours, so it monitors inertia in real time and procures fast frequency response.

  • 18. How is system inertia monitored?

    Operators estimate online stored energy from the commitment status and inertia constants of synchronous units, and some systems use measurement-based estimation from PMU data. The result is compared with critical inertia thresholds.

  • 19. Can a data center or industrial microgrid have inertia problems?

    Yes. Islanded microgrids usually have small generator fleets with limited inertia. Large, fast load changes can cause high RoCoF and frequency deviations, which grid-forming batteries and coordinated controls can mitigate.

  • 20. What studies evaluate frequency performance?

    Aggregate center-of-inertia models, PSS®E or PSLF dynamic studies, PSCAD EMT studies and event analysis using PMU and DFR data. Together they evaluate RoCoF, nadir, settling frequency and resource ride-through.


References and Further Reading

Links were current at publication (October 2026).


  • NERC Reliability Standard BAL-003, Frequency Response and Frequency Bias Setting. North American Electric Reliability Corporation.
  • NERC Reliability Standard PRC-006, Automatic Underfrequency Load Shedding; PRC-024 and PRC-029, Frequency and Voltage Ride-through. North American Electric Reliability Corporation.
  • NERC Reliability Guideline, Fast Frequency Response Concepts and Bulk Power System Reliability Needs. North American Electric Reliability Corporation.
  • FERC Order No. 842, Essential Reliability Services and the Evolving Bulk-Power System — Primary Frequency Response. Federal Energy Regulatory Commission.
  • IEEE Std 2800-2022 and IEEE Std 1547-2018. IEEE.
  • P. Kundur, Power System Stability and Control. McGraw-Hill.

Disclaimer

This article is general technical information for educational purposes. It is not engineering advice for any specific project and does not create a professional relationship. The frequency results are from Keentel Engineering's simplified center-of-inertia model with illustrative parameters, not field data; actual system performance depends on detailed generator, governor, inverter, load and protection models. UFLS settings, reserve products and requirements differ by region and change over time. Project designs must follow current standards, ISO/RTO and transmission provider requirements and project-specific engineering analysis, sealed by a licensed professional engineer where required.


Case studies are illustrative scenarios based on typical project conditions, not records of specific client projects. Figures are rounded and indicative.


NERC, FERC, ERCOT, IEEE, PSS®E, PSLF, PSCAD™ and other names are the property of their respective owners. Keentel Engineering is not affiliated with or endorsed by these organisations or any software or equipment vendor.

Office Address Phone
Head Office — Tampa 400 N Ashley Dr STE #2600, Tampa FL 33602 (813) 389-7871
Austin 5900 Balcones Drive STE 100, Austin TX 78731 (512) 591-0752
Sacramento 1401 21st St Ste R, Sacramento CA 95811 (916) 913-4524
Baltimore 306 W Redwood St STE 200, Baltimore MD 21201 (410) 225-2181

contact@keentelengineering.com  ·  keentelengineering.com  ·  calendly.com/keentel-engineering/15min


State of Florida — Registry No. 36853, KEENTEL LLC, DBA: KEENTEL ENGINEERING

Copyright 1995–2026 Keentel Engineering. All Rights Reserved.



A smiling man with glasses and a beard wearing a blue blazer stands in front of server racks in a data center.

About the Author:

Sandip "Sonny" R. Patel, P.E.

IEEE Senior Member · Founder & CEO, Keentel Engineering

In 1995, Sonny Patel earned his Electrical Engineering degree from the University of Illinois. But degrees don't build legacies — action does.

For three decades, he has worked the power industry from every side of the table: 16 years as a utility engineer at Exelon/Commonwealth Edison; generation leadership across hydroelectric, industrial steam turbine, and a 9 GW renewable fleet; NERC Regional Entity Senior Compliance Engineer and Audit Team Lead, auditing some of the nation's largest utilities; and testing and commissioning lead on equipment up to 765 kV — the very top of the North American grid.Utility. Generator. Regulator. Consultant. Few engineers have seen all four seats. Fewer still have sat in them.

His experience spans nuclear, hydro, conventional generation, renewables, oil and gas, mining — and today's data centers, where he is authoring a three-book series on data center design. He is a Licensed Professional Engineer in six states and a Licensed Electrical Contractor in Florida (Unlimited EC) — he doesn't just design the work; he's qualified to stand behind its execution.Today, as Founder and CEO of Keentel Engineering, Sonny leads a nationwide team of engineers delivering substation design, power system studies, NERC compliance, and commissioning — done right, coast to coast.Three decades. Every side of the table. One standard: accountable engineering.

Four workers in safety vests and helmets stand with arms crossed near wind turbines.

Let's Discuss Your Project

Let's book a call to discuss your electrical engineering project that we can help you with.

Man in a blazer and open shirt, looking at the camera, against a blurred background.

About the Author:

Sandip "Sonny" R. Patel, P.E.

IEEE Senior Member · Founder & CEO, Keentel Engineering

In 1995, Sonny Patel earned his Electrical Engineering degree from the University of Illinois. But degrees don't build legacies — action does.

For three decades, he has worked the power industry from every side of the table: 16 years as a utility engineer at Exelon/Commonwealth Edison; generation leadership across hydroelectric, industrial steam turbine, and a 9 GW renewable fleet; NERC Regional Entity Senior Compliance Engineer and Audit Team Lead, auditing some of the nation's largest utilities; and testing and commissioning lead on equipment up to 765 kV — the very top of the North American grid.

Utility. Generator. Regulator. Consultant. Few engineers have seen all four seats. Fewer still have sat in them.

His experience spans nuclear, hydro, conventional generation, renewables, oil and gas, mining — and today's data centers, where he is authoring a three-book series on data center design. He is a Licensed Professional Engineer in six states and a Licensed Electrical Contractor in Florida (Unlimited EC) — he doesn't just design the work; he's qualified to stand behind its execution.

Today, as Founder and CEO of Keentel Engineering, Sonny leads a nationwide team of engineers delivering substation design, power system studies, NERC compliance, and commissioning — done right, coast to coast.Three decades. Every side of the table. One standard: accountable engineering.

Leave a Comment

Related Posts

Data Center Cooling Plants: Evaporative vs Hybrid vs Dry
By SANDIP R PATEL • November 26, 2026
Compare data center cooling plants by water use, energy efficiency, peak power demand, generator sizing, grid impact and lifecycle costs.
Ground-Mount Solar Engineering: Complete Design Guide
By SANDIP R PATEL • November 26, 2026
Explore ground-mount solar engineering, from site selection and string sizing to collector design, grounding, battery storage and grid interconnection.
Gas turbine backlog and equipment lead times for power generation projects in 2026.
By SANDIP R PATEL • November 26, 2026
Explore the 2026 gas turbine backlog, equipment lead times, GSU supply constraints, interconnection challenges, NERC testing and project delay costs.
PLECS and Ansys simulation workflow for solid-state transformer engineering.
By SANDIP R PATEL • November 26, 2026
Explore how PLECS and Ansys support solid-state transformer simulation, thermal modeling, power loss analysis, control design, and engineering validation.
Solid-state transformer design through EVT with efficiency vs load comparison chart
By SANDIP R PATEL • November 25, 2026
Explore solid-state transformer design, SiC architecture, protection, insulation and EVT testing for data centers and EV charging with Keentel Engineering.
SCADA architecture for power systems showing telemetry latency, RTU, IED and ICCP communication
By SANDIP R PATEL • November 25, 2026
Explore SCADA architecture for power and process systems, including DNP3, IEC 61850, telemetry latency, alarms, time sync, NERC CIP and OT security.
Transient stability studies graph comparing rotor angles and fault clearing times in power systems
By SANDIP R PATEL • November 24, 2026
Explore transient stability studies, IEEE and NERC standards, generator models, critical clearing time, breaker protection and power system stability analysis.
Joint load and generation interconnection studies showing N-1 transmission line loading scenarios Co
By SANDIP R PATEL • November 24, 2026
Learn how joint load and generation interconnection studies work, including PJM Fast Energization, MISO LARS, co-location risks and grid modeling.
Grid flexibility load duration curve showing peak demand reduction and capacity needs
By SANDIP R PATEL • November 22, 2026
Explore dependable grid flexibility with battery storage, virtual power plants, managed EV charging and flexible loads to cut peak demand and grid costs.
