SPP's New Rules for Data Centers and Other Large Loads: A Plain-English Guide to HILL Requirements

SPP's New Rules for Data Centers and Other Large Loads
Calendar icon. D

October 30, 2026 | Blog

Southwest Power Pool (SPP) is moving to treat very large electricity users — data centers, crypto mining sites and big industrial plants — much like power plants: they must be studied before they connect, and they must stay connected through grid disturbances. SPP calls them High Impact Large Loads (HILLs). This guide explains, in plain English, what SPP's draft HILL documents require and what that means for anyone planning a large load in SPP.


1. Why SPP Created HILL Rules

The short answer: a large load that drops off the grid all at once can hurt the grid as much as a power plant that trips.


For decades, utilities expected customers' equipment to trip during a disturbance. A few homes or a factory dropping off for a second did not matter. That changed with the arrival of loads of hundreds of megawatts — the size of a mid-size power plant — often clustered in the same area.


When a fault happens on a transmission line (for example, lightning or a tree contact), voltage across a wide area dips for a fraction of a second until protection clears it. Data center electronics sense that dip and, if set to protect themselves aggressively, switch to backup power or shut down. If many megawatts disappear at once:


  • Frequency jumps up, because generators are suddenly producing more than is being used.
  • Voltage can swing high, because lightly loaded lines push voltage up.
  • Other equipment may then trip, which is how a small event turns into a large one.


SPP's draft ride-through document states this directly: there are no industry standards that require loads to ride through faults, yet uncontrolled tripping of large loads "may cause or exacerbate cascading outages." So SPP is creating load requirements modeled on what generators already have to meet.


2. What Counts as a HILL, and Who the Rules Apply To

A HILL is defined in the SPP Tariff; the ride-through document points to the Tariff rather than repeating the size threshold. In practice, the label covers very large, fast-growing loads such as data centers, crypto mining and large industrial facilities. Check the current SPP Tariff for the exact definition that applies to your project.


The study process sits under SPP Tariff Attachments AQ, AX, BA and BB and SPP's business practice BP 7850. The draft ride-through rules apply:


  • To new requests: HILLs that submit through SPP's transmission service process, or that are supported by a High Impact Large Load Generating Facility, on or after the effective date of SPP Revision Request RR 696 (the date is still a placeholder in the draft).


  • To earlier requests, more softly: HILLs that applied to their Transmission Owner before that date must make "reasonable efforts" to maximize ride-through within their equipment's capability and document those efforts if asked.


  • To generation on the same site: solar, batteries, gas generators or synchronous condensers that share a Point of Interconnection (POI) with a HILL have their own ride-through rules (Section 6 below).


One important nuance: the rules can be limited to the power-electronic part of a site. SPP's example is a 50 MW facility with 45 MW of conventional industrial load and 5 MW of power-electronic load; the requirements would apply only to the 5 MW, if SPP's study shows that exemption does not harm reliability.


3. How SPP Studies a HILL: The Delivery Point Study

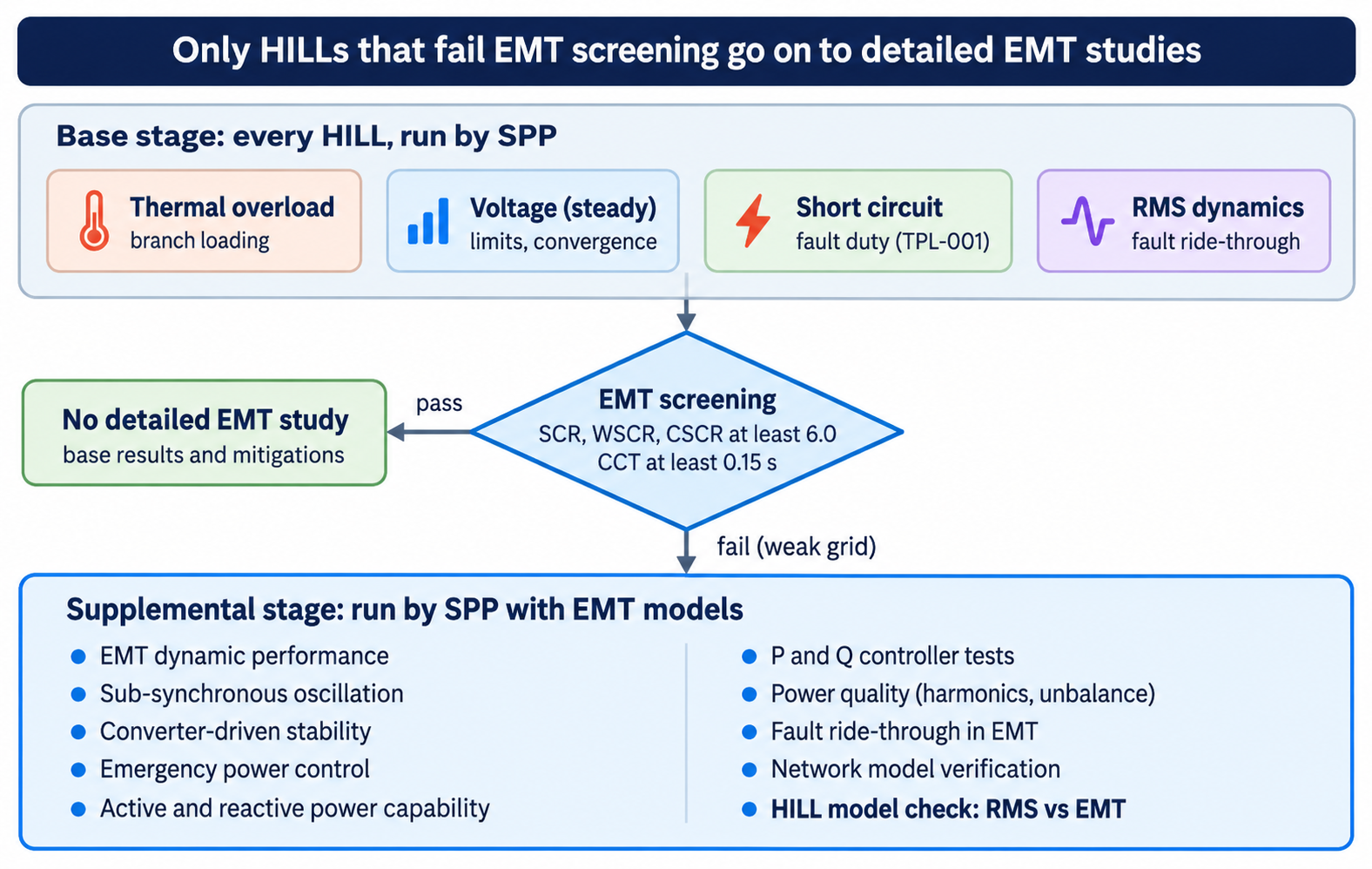

Every HILL goes through SPP's base studies; only sites on a weak part of the grid go on to the detailed EMT stage.

HILL Delivery Point Study · base and supplemental stages.


In the base stage SPP runs four studies with its full network model and your power-flow and RMS dynamic models, then screens grid strength. A site that passes screening is judged on the base results and any mitigation they call for. A site that fails goes to the supplemental stage, where SPP uses detailed EMT models of both the grid and the HILL — so your PSCAD model must be ready and must agree with your PSS®E model.


4. Voltage Ride-Through, Explained

Ride-through means staying connected and keeping the load running while grid voltage briefly goes too low or too high. SPP's draft sets a minimum time a HILL must stay connected at each voltage level, measured at the POI (the point where the site meets the transmission system).

Voltage at the POI (per unit of normal) What it looks like Must stay connected for at least
Above 1.20 Severe overvoltage Not required (may ride through or trip)
1.10 to 1.20 High voltage 0.5 seconds
0.90 to 1.10 Normal range Continuously — no tripping
0.80 to 0.90 Mild sag 2.0 seconds
0.50 to 0.80 Moderate sag 0.5 seconds
Below 0.50 Deep sag, usually a nearby fault 0.15 seconds (about 9 cycles)

"Per unit" simply means a fraction of normal voltage: 0.80 per unit on a 345 kV line is about 276 kV.


Where the numbers come from. The table blends two familiar references. The first is the ITIC (formerly CBEMA) curve, the long-standing chart of how much voltage disturbance IT power supplies should tolerate. The second is ERCOT's July 2025 proposal for large electronic loads. SPP's appendix explains the logic:


  • Below 0.5 pu for about 9 cycles (150 ms): loads close to a fault see deep sags, but most faults are cleared in 4 to 7 cycles, so loads should ride through normally cleared faults.
  • 0.5 to 0.8 pu for 0.5 seconds: loads farther from the fault see shallower sags that can last up to 30 cycles when a fault is cleared by backup protection.


What the load should do during a moderate sag (0.5 to 0.8 pu). It should keep drawing power from the grid, reduced roughly in proportion to how far voltage has dropped. Briefly using less power actually helps the grid recover, which is why SPP allows it, but the load must stay connected.


5. Deep Sags, UPS Transfer and the 1-Second Recovery Rule

This is the requirement most likely to catch data center projects out. When voltage falls below about 0.5 pu, a server power supply's rectifier can no longer pull useful power from the grid. SPP accepts that, and gives the load two options:


  1. Transfer to UPS. The uninterruptible power supply carries the servers from its batteries while the grid is disturbed.
  2. Trip. The load may disconnect.
    Either way, the load must come back to at least 90% of its pre-   disturbance grid     consumption within 1 second after voltage recovers to 0.9 pu or higher.


Why this matters: many UPS systems are set up to protect the computers, not the grid. After a sag they may stay on battery for several seconds, or ramp back slowly, to be sure the grid is stable. To the grid, a 250 MW data center that stays on battery for 10 or 15 seconds after every nearby fault looks the same as a 245 MW plant tripping offline. Under SPP's draft, that response would not meet the 1-second rule.


SPP allows one exception. In a weak grid, a fast snap-back can cause oscillations, so SPP and the Transmission Owner may agree to a longer recovery time. That is a negotiated exception, not a default.


What to do about it in practice:



  • Ask your UPS manufacturer for the return-to-grid (re-transfer) time and ramp rate after a sag, and whether firmware settings can achieve 1 second.
  • Make sure the dynamic model you give SPP uses those exact settings. A model that is more conservative than the real equipment can fail a study the equipment would pass.
  • If the site is on a weak, radial connection, raise the recovery-time question with SPP and the Transmission Owner early.

6. Overvoltage, Frequency and Reclosing Requirements

Transient overvoltage (very short spikes). Switching events and fault clearing can create voltage spikes lasting thousandths of a second. SPP borrows Table 14 of IEEE 2800-2022 (the inverter-based resource standard), counting the total time above each level within any one-minute window:

Instantaneous voltage (pu, after surge arresters) Must ride through for at least
Above 1.80 Not required
Above 1.70 0.2 milliseconds
Above 1.60 1.0 millisecond
Above 1.40 3.0 milliseconds
Above 1.20 15.0 milliseconds

Frequency ride-through. Grid frequency in North America is 60 Hz. SPP adopts the frequency limits of NERC PRC-029-1 (another generator standard):

Frequency Must stay connected for at least
61.8 Hz or higher Not required
61.2 Hz or higher 299 seconds
58.8 to 61.2 Hz Continuously
Below 58.8 Hz 299 seconds
Below 57.0 Hz Not required

In plain terms:


Across the normal and moderately disturbed range, the load must keep running for about five minutes, long enough for operators and automatic controls to restore balance. SPP says HILLs should not trip within these limits unless internal protection requires it.Reclosing — riding through more than one hit.


Transmission lines often use automatic reclosing:


After a fault the breaker opens, waits, and closes again to test whether the fault has cleared. If it has not, the grid sees a second voltage dip. SPP's rule: HILLs should not use protection that trips on these repeated dips while POI voltage stays within the ride-through limits. If equipment protection truly requires such logic, the HILL must still ride through at least six fault-clearing attempts within 90 seconds. A study case with a fault, then a second fault a few hundred milliseconds later, is testing exactly this.


7. Control Mode, Exemptions and On-Site Generation

Constant current, not constant power. Power equals voltage times current. A load in constant-power mode tries to keep its power the same when voltage drops, so it pulls more current, which drags voltage down further — the opposite of what the grid needs. A load in constant-current mode lets its power fall in step with voltage. SPP requires HILLs that are mainly power electronics or variable-speed drives to:


  1. Use constant-current control during disturbances, with a reasonable current limit (the limit is still "TBD" in the draft).
  2. Avoid constant-power control.
  3. Avoid protection that trips on repeated reclosing dips (Section 6).


Exemptions, all conditional on the study. SPP's footnotes offer several exemptions, each only if the HILL Delivery Point Study shows reliability is not harmed:

Exemption What it relieves
Non-power-electronic load The whole requirement set may apply only to the power-electronic part of the site
Variable-speed drives (VSDs) The 0.15-second deep-sag minimum, constant-current mode, the constant-power ban and transient overvoltage limits — but VSDs still must restore 90% of consumption within 1 second
Weak grid A longer recovery time than 1 second, agreed with SPP and the Transmission Owner

This creates a real design trade-off. Moving chillers onto UPS can improve how cleanly the site rides through a fault, but it also turns that load into power-electronic load that the rules fully apply to. Running chillers on VSDs can bring them under the VSD exemptions instead. Design and modeling teams should decide this together, early.


On-site generation behind the same POI. If the site has its own generation sharing the POI, those units must coordinate their ride-through with the load:


  • Inverter-based resources (solar, batteries): IEEE 2800-2022 Clause 7, except voltage protection (7.2.1) and mandatory frequency tripping (7.3.1). Reactive current gets priority during low voltage, with active power cut as little as possible. The Transmission Owner sets the nominal voltage, and SPP may specify the positive- and negative-sequence reactive current response through the HILL generator interconnection agreement (HILLGIA).
  • Synchronous generators, Type 1 and 2 wind, synchronous condensers: NERC PRC-024-4.

8. Modeling a HILL for SPP: What the Models Are and Where Projects Stumble

SPP judges a HILL almost entirely through computer models, so the model is the project during the study. Two kinds of model are involved.


RMS (positive-sequence) models in PSS®E. These are what SPP runs in its big regional studies. They represent the grid in averaged, cycle-by-cycle terms and are fast enough to simulate the whole SPP system. A data center RMS model usually combines:


  • A power-electronic load model for the UPS-fed IT load. The PERC family of data center load models has been developed through the NERC Load Modeling Working Group; they are user-written models (delivered as compiled DLL files) until they are added to the standard PSS®E library.
  • A composite load model (CMLD) for cooling and other mixed load. It splits load into motor types (A, B, C, D), power-electronic and static parts, each with its own protection, such as motor undervoltage trips.


EMT models in PSCAD. These represent every switching device and waveform in detail, microsecond by microsecond. They are slow, so SPP uses them only near the project and only when the grid is weak (Section 3).

Common pitfalls, and how to avoid them:

Pitfall What goes wrong How to avoid it
Software version mismatch A user-model DLL compiled for one PSS®E version will not load in another, and the study stops Ask SPP which PSS®E version the study uses; test the DLL in that exact version before submitting
Wrong point of interconnection Model connects at the facility substation rather than the TO's POI bus; SPP cannot drop it into its case Model from the POI bus the TO gives you, including any new POI transformer and line
Raw case only SPP needs an .idv script that adds the project to its own case Deliver an .idv (plus .raw), following the TO's template and bus numbering
Reactive power that does not match the load mix The composite load's initial compensation is set from the power-flow Q; if Q is too low, motors trip after a fault and Q swings negative Set power-flow Q consistent with the motor composition; test a POI fault before submitting
UPS settings that are too protective Long time on battery or slow ramp-back fails the 1-second recovery rule Use the vendor's real re-transfer settings and confirm they meet SPP's limits
Constant-power control Higher current during sags, worse voltage recovery Use constant-current settings in both equipment and model
RMS and EMT models that disagree SPP's model verification step flags inconsistent responses Build both from one data set and compare the same events side by side

The common thread: test the model in SPP's software and against SPP's events (fault, re-fault, sags) before you submit, and make sure the model reflects how the real equipment is set.


9. Practical Checklist for Developers

Use this before you file, and again before each model submission.

Design and equipment


  • UPS vendor has confirmed, in writing, how the UPS behaves below 0.5 pu and how fast it returns to the grid (target: 90% within 1 second of 0.9 pu)
  • UPS and drives are set to constant-current behavior during disturbances
  • No protection trips the site on repeated reclosing dips; if any must, it tolerates six attempts in 90 seconds
  • Frequency protection does not trip between 58.8 and 61.2 Hz, and allows 299 seconds outside that band
  • Cooling strategy decided: chillers on UPS, on VSDs, or direct-on-line — and which exemptions that relies on
  • On-site generation (if any) meets IEEE 2800-2022 Clause 7 or PRC-024-4 and is coordinated with the load


Interconnection data


  • POI bus, voltage and short-circuit / Thevenin data obtained from the Transmission Owner
  • Network from the POI to the load (POI transformer, line, facility transformers) taken from the TO's exhibit or design, with any assumed data flagged
  • Expected power factor and where it is measured agreed with the TO


Model package



  • PSS®E version used by SPP confirmed; all user DLLs load in that version
  • .idv script plus .raw, using the TO's bus numbers and template
  • .dyr records match the bus numbers in the .idv
  • Power-flow Q consistent with the dynamic load composition
  • Flat run, voltage sag, POI fault and fault-plus-re-fault cases run cleanly and results documented
  • PSCAD model built from the same data, with matching responses to the same events
  • Model report states every assumption, software version and setting source

10. 25 Technical FAQs


11. Sources and Disclaimer

Primary sources (SPP drafts, prepared for Revision Request RR 696):


  • SPP, High Impact Large Load Delivery Point Study (HDPS) Overview, V1.0, revision history dated September 23, 2025 (initial draft).
  • SPP, HILL Fault Ride Through Requirements, V2.0, revision history dated September 23, 2025 (initial draft).


Standards and references cited in those documents:


NERC TPL-001-5.1; NERC PRC-024-4; NERC PRC-029-1; IEEE 2800-2022; IEEE 1547; IEEE 1668-2017; ITIC (CBEMA) curve; ERCOT Large Electronic Load Voltage Ride-Through Performance Requirements proposal (LLWG, July 11, 2025); AESO Connection Requirements for Transmission-Connected Data Centers (August 22, 2025); CIGRE Technical Brochure 909; SPP Disturbance Performance Requirements; SPP Planning Criteria; SPP BP 7850.


Disclaimer:



This guide summarizes draft SPP documents in plain language for general information. The requirements are subject to stakeholder review, approval of RR 696 and future revision; several values (for example, the current limit) are still marked "TBD". It is not legal, regulatory or engineering advice for any specific project. Always confirm the current version of SPP's Tariff, business practices and requirements with SPP and your Transmission Owner before making design or filing decisions. PSS®E and PSCAD are trademarks of their respective owners.



A smiling man with glasses and a beard wearing a blue blazer stands in front of server racks in a data center.

About the Author:

Sandip "Sonny" R. Patel, P.E.

IEEE Senior Member · Founder & CEO, Keentel Engineering

In 1995, Sonny Patel earned his Electrical Engineering degree from the University of Illinois. But degrees don't build legacies — action does.

For three decades, he has worked the power industry from every side of the table: 16 years as a utility engineer at Exelon/Commonwealth Edison; generation leadership across hydroelectric, industrial steam turbine, and a 9 GW renewable fleet; NERC Regional Entity Senior Compliance Engineer and Audit Team Lead, auditing some of the nation's largest utilities; and testing and commissioning lead on equipment up to 765 kV — the very top of the North American grid.Utility. Generator. Regulator. Consultant. Few engineers have seen all four seats. Fewer still have sat in them.

His experience spans nuclear, hydro, conventional generation, renewables, oil and gas, mining — and today's data centers, where he is authoring a three-book series on data center design. He is a Licensed Professional Engineer in six states and a Licensed Electrical Contractor in Florida (Unlimited EC) — he doesn't just design the work; he's qualified to stand behind its execution.Today, as Founder and CEO of Keentel Engineering, Sonny leads a nationwide team of engineers delivering substation design, power system studies, NERC compliance, and commissioning — done right, coast to coast.Three decades. Every side of the table. One standard: accountable engineering.

Four workers in safety vests and helmets stand with arms crossed near wind turbines.

Let's Discuss Your Project

Let's book a call to discuss your electrical engineering project that we can help you with.

Man in a blazer and open shirt, looking at the camera, against a blurred background.

About the Author:

Sandip "Sonny" R. Patel, P.E.

IEEE Senior Member · Founder & CEO, Keentel Engineering

In 1995, Sonny Patel earned his Electrical Engineering degree from the University of Illinois. But degrees don't build legacies — action does.

For three decades, he has worked the power industry from every side of the table: 16 years as a utility engineer at Exelon/Commonwealth Edison; generation leadership across hydroelectric, industrial steam turbine, and a 9 GW renewable fleet; NERC Regional Entity Senior Compliance Engineer and Audit Team Lead, auditing some of the nation's largest utilities; and testing and commissioning lead on equipment up to 765 kV — the very top of the North American grid.

Utility. Generator. Regulator. Consultant. Few engineers have seen all four seats. Fewer still have sat in them.

His experience spans nuclear, hydro, conventional generation, renewables, oil and gas, mining — and today's data centers, where he is authoring a three-book series on data center design. He is a Licensed Professional Engineer in six states and a Licensed Electrical Contractor in Florida (Unlimited EC) — he doesn't just design the work; he's qualified to stand behind its execution.

Today, as Founder and CEO of Keentel Engineering, Sonny leads a nationwide team of engineers delivering substation design, power system studies, NERC compliance, and commissioning — done right, coast to coast.Three decades. Every side of the table. One standard: accountable engineering.

Leave a Comment

Related Posts

Power Swing Blocking, Out-of-Step Tripping and NERC PRC-026: How Distance Relays Tell Swings from Fa
By SANDIP R PATEL • November 14, 2026
Learn power swing blocking, out-of-step tripping, distance relay settings and NERC PRC-026 compliance with Keentel Engineering's technical guide.
NEC 2026 Field Guide showing electrical code changes for load calculations, grounding, energy manage
By SANDIP R PATEL • November 14, 2026
Explore NEC 2026 changes to load calculations, grounding, ampacity, wiring, solar, ESS and EV systems with Keentel Engineering's practical field guide. Copy
Data Center Tiers I–IV comparison showing redundancy, concurrent maintainability and fault tolerance
By SANDIP R PATEL • November 14, 2026
Explore Data Center Tiers I–IV, N+1 vs. 2N redundancy, concurrent maintainability, fault tolerance, and MEP design requirements with Keentel Engineering.
NERC compliance engineering standards covering PRC, MOD, TPL, FAC, VAR, EOP and CIP.
By SANDIP R PATEL • November 14, 2026
Explore NERC compliance engineering for generator and transmission owners, IBRs and large loads, covering PRC, MOD, TPL standards, audits and modeling.
LVRT to HVRT transition in weak grids showing post-fault overvoltage and inverter voltage response.
By SANDIP R PATEL • November 14, 2026
Learn why LVRT becomes HVRT in weak grids, how post-fault overvoltage trips solar, wind and BESS plants, and how Keentel Engineering uses EMT studies.
STATCOM V-I characteristic graph showing voltage regulation, current limits and short-term overload.
By SANDIP R PATEL • November 14, 2026
Explore STATCOM V-I characteristics, voltage control slope, current limits, short-term overload ratings, reactive power and low-voltage grid performance.
Ground distance protection R-X diagram showing mho and quadrilateral relay settings for a 230 kV lin
By SANDIP R PATEL • November 12, 2026
Learn ground distance protection settings for transmission lines: k0 compensation, mho and quadrilateral relays, mutual coupling and NERC compliance.
800 VDC vs. 1,500 VDC AI data center power distribution chart comparing rack current and conductor l
By SANDIP R PATEL • November 12, 2026
Compare 800 VDC vs. 1500 VDC for AI data centers. Explore efficiency, copper savings, DC protection, safety and power distribution with Keentel Engineering.
Transformer overcurrent protection 51/50 time-current coordination curves showing relay settings and
By SANDIP R PATEL • November 12, 2026
Learn transformer overcurrent protection using 50/51 relay stages, inverse-time curves, inrush checks, fault coordination and arc-flash mitigation.
