Protection Design

Safeguarding the Heart of the Grid: Designing and Installing a Complete Transformer Protection System

Designing and Installing a Complete
A calendar icon featuring a square outline, a top binding, and a grid of dots representing days. D

Aug 8, 2026 | Blog

A practitioner’s look at how protection elements, instrument transformers, and relays come together — and where sound engineering makes the difference.


Power transformers are the most valuable single assets in most substations, and among the slowest to replace. A large unit can take a year or more to procure, and its loss can strand an entire load pocket or generation tie. That is why a transformer protection system is never an afterthought bolted onto the primary equipment — it is a designed system in its own right, one that continuously monitors the transformer and trips the associated circuit breakers to isolate the unit the instant a fault or abnormal condition appears. Done well, it protects the asset, the people around it, and the reliability of everything downstream.



This article walks through the anatomy of a complete transformer protection scheme from an engineering standpoint — the sensing chain, the protective functions, and the trip path — and then looks at what it actually takes to design, coordinate, and commission one in the field.


The Sensing Chain: CTs, VTs, and the Relay

Every protection decision is only as good as the measurements behind it. Current transformers (CTs) on each phase step the primary current down to a standardized secondary (typically 1 A or 5 A) and provide a galvanically isolated, low-energy replica of the line current to the relay. Voltage transformers (VTs), likewise, present an isolated low-voltage image of each phase to ground. Getting this layer right is foundational: CT ratio and accuracy class, knee-point voltage, burden, and — critically for differential schemes — matched saturation characteristics all have to be engineered, not assumed.


The protection relay is the brain of the system. A modern numerical relay continuously samples the CT and VT inputs alongside temperature and gas sensors, runs the protective algorithms in real time, and issues a trip command when any element picks up and times out. A healthy relay does nothing visible for years; its value is entirely in the microseconds when it acts correctly — and in never acting when it shouldn’t.


The Protective Functions

A well-designed scheme layers several protection elements so that every credible fault has a fast primary response and a graded backup. The core functions for an oil-filled power transformer are:


  • Differential protection (87T) — the primary internal-fault element. It compares the current entering and leaving the transformer; in a healthy unit these balance (after accounting for ratio, vector group, and tap), so any significant differential current signals a winding fault between phases or to earth. Percentage-restraint and harmonic blocking keep it stable through inrush and external faults.


  • Restricted earth fault (REF / 64) — high-sensitivity detection of ground faults near the neutral, where differential sensitivity fades.


  • Overcurrent and earth fault (50/51, 50N/51N) — protection against overload and short circuits, and time-graded backup to the differential and to downstream devices.


  • Buchholz relay — a mechanical device in the pipe to the conservator that detects gas accumulation or oil surge from an incipient internal fault, providing a staged alarm (slow gas build-up) and trip (violent surge).


  • Temperature monitoring — winding and top-oil temperature devices raise an alarm and, if the condition persists, trip — protecting insulation life from sustained overheating.


  • Oil level indication — monitors the conservator level so that a low-oil condition raises an alarm before it can compromise cooling or dielectric strength.


The art is in coordination: each element must be sensitive enough to catch its target fault yet secure enough to ride through inrush, external faults, and CT saturation without a false trip. That balance is set by protection studies, not by default relay settings.

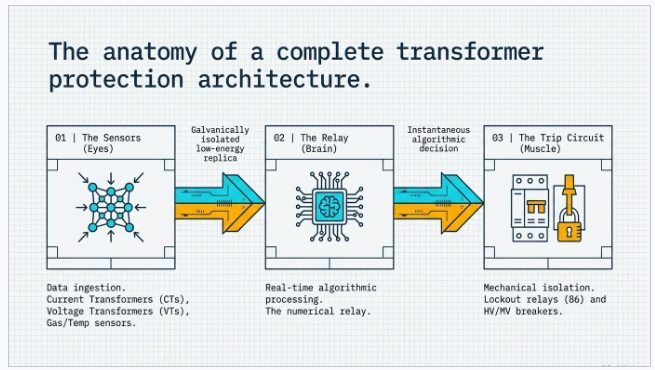

Complete transformer protection architecture showing protection relays and fault detection systems

From Detection to Isolation: The Trip Circuit

Detection is only half the job. When any protective element operates, the relay energizes the trip circuit, which opens the transformer’s circuit breakers and disconnects the unit from the system. The integrity of this path deserves as much attention as the relay logic itself: trip-coil supervision, redundant DC supplies, lockout relays (86) where a manual reset is warranted, and clearly engineered breaker-failure backup all ensure that a valid trip command actually clears the fault. A protection scheme that detects perfectly but fails to trip has protected nothing.


Design and Installation: Where Engineering Earns Its Keep

Specifying the right relay is the easy part. A protection system that performs on the worst day of its life is the product of a disciplined engineering process:

1. System studies and modeling


Short-circuit, load-flow and protection-coordination studies define the fault duties and the settings envelope. At Keentel we model these in industry-standard tools — ETAP, SKM, PSCAD, and DIgSILENT — so that CT ratios, relay pickups, and time grading are derived from the actual network, not from templates.


2. Scheme and CT/VT design


Selecting CT class and knee-point voltage for the differential zone, defining the protection zones and their overlap, sizing VT burdens, and drawing the AC/DC schematics and wiring so the as-built matches the design intent.


3. Settings, coordination, and NERC compliance


Translating study results into relay settings files, verifying selectivity across every element, and — for bulk-power-system assets — documenting the basis to satisfy NERC PRC and O&P standards.


4. Commissioning and testing


Secondary injection to prove every element, primary injection and stability checks on the differential zone, trip-path verification through to the breaker, and functional testing of Buchholz, temperature, and oil-level trips before the unit is energized. Commissioning is where design assumptions meet reality — and where an experienced engineering partner prevents the costly surprises.

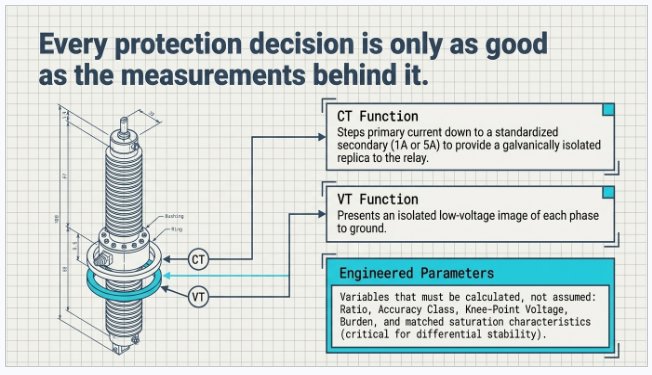

Transformer protection measurements using CT and VT inputs for relay protection coordination

What a Complete Scheme Detects

Taken together, a properly engineered transformer protection system stands guard against the full range of failure modes: internal winding faults, overcurrent and short circuits, overheating, low oil level, internal gas or oil surge, and earth faults. Each has a dedicated element, and each element is coordinated with the others so that the fastest appropriate device clears the fault while backup remains ready.


Case Studies from the Field

The following engagements are drawn from Keentel Engineering’s protection and substation work. Client names and identifying details have been withheld; figures are representative of the outcomes achieved.

CASE STUDY 01  Curing Nuisance Trips on a Utility-Scale Solar Step-Up Transformer


Challenge:  A 34.5/230 kV step-up transformer at a large PV plant tripped on differential protection during routine energization and after nearby external faults. Each event pulled the plant offline, and repeated inrush-driven misoperations were eroding the owner’s confidence in the scheme and their availability numbers.


Solution:  Our engineers re-examined the differential zone end to end. CT ratios and knee-point voltages were checked against a fresh short-circuit model in ETAP, secondary wiring and polarity were verified, and the numerical relay’s percentage-restraint slope and second-harmonic blocking were retuned to distinguish magnetizing inrush from a true internal fault. Stability was then proven by primary injection across the zone.


Result:  Nuisance trips on energization and through-faults were eliminated while full internal-fault sensitivity was preserved. The plant returned to its contractual availability target, and the owner adopted the retuned settings basis as a template across sister sites.


CASE STUDY 02  Modernizing Protection on an Aging 138 kV Substation


Challenge:  A utility operated a substation whose transformer protection still relied on decades-old electromechanical relays. Spare parts were scarce, coordination had drifted as load grew, and the assets could no longer be shown to meet current NERC PRC requirements without a documented settings basis.


Solution:  Keentel delivered a phased retrofit: a full protection-coordination study in SKM, replacement of the legacy relays with modern numerical devices providing 87T, REF, and 50/51 functions, redrawn AC/DC schematics, and a settings package with the calculations and margins documented for compliance. The cutover was sequenced to keep the substation in service throughout.


Result:  Selectivity was restored across every element, obsolescence risk was removed, and the utility received an audit-ready compliance package. Protection operating times for close-in faults were reduced, lowering through-fault stress on the transformer.


CASE STUDY 03  Protection Design and Commissioning for a New BESS Interconnection


Challenge:  A developer bringing a battery energy storage system online at a new point of interconnection needed a complete transformer protection scheme designed, coordinated, and commissioned to a tight energization deadline — with the interconnecting utility’s protection requirements to satisfy before approval.


Solution:  Acting as owner’s engineer, our team designed the full scheme from the ground up: protection zones and CT/VT specification, differential and restricted earth fault elements, time-graded overcurrent backup, and a redundant trip path with trip-coil supervision and a lockout relay. We modeled fault duties, produced the settings, coordinated the relay philosophy with the utility, and led secondary- and primary-injection commissioning through to breaker trip.


Result:  The scheme passed the utility’s witnessed testing on the first attempt and the asset energized on schedule. The documented design and test records shortened the interconnection approval and gave the developer a clean baseline for operations and maintenance.


Frequently asked questions

  • Q. What is the difference between differential (87T) and overcurrent (50/51) protection on a transformer?

    Differential protection is a unit scheme: it responds only to faults inside the zone bounded by its CTs — that is, internal winding faults — and does so almost instantaneously with no need for time grading. Overcurrent protection responds to the magnitude of current regardless of where the fault is, so it serves as overload protection and as time-graded backup to the differential and to downstream devices. A complete scheme uses both: differential as the fast primary element, overcurrent as coordinated backup.

  • Q. Why does a differential relay need harmonic restraint?

    When a transformer is energized, magnetizing inrush can draw a large current on the primary with no corresponding secondary current — which looks exactly like an internal fault to a simple differential comparison. Inrush is rich in second-harmonic content, so the relay uses second-harmonic blocking (and often fifth-harmonic restraint for overexcitation) to recognize inrush and hold off tripping, while still operating quickly for a genuine fault.


  • Q. Is a Buchholz relay still necessary if I have modern numerical protection?

    Yes. The Buchholz relay detects incipient faults — slowly developing insulation breakdown or partial discharge — by sensing the gas they generate, often before the fault produces enough electrical signature for the differential element to act. It also detects loss of oil and violent oil surge. It is a mechanical, independent line of defense that complements, rather than duplicates, the numerical relay, which is why oil-filled power transformers are typically fitted with both.


  • Q. How often should transformer protection settings be reviewed?

    Settings should be revisited whenever the surrounding network changes materially — new generation or load, altered fault levels, reconfiguration, or a transformer replacement — and periodically as part of a maintenance and compliance program. For bulk-power-system assets, NERC PRC standards drive a documented review and testing cadence; even where they don’t apply, a coordination review every few years is sound practice because fault duties and coordination margins drift over time.


  • Q. What is restricted earth fault (REF) protection and when do I need it?

    REF is a high-sensitivity element that protects against ground faults near the transformer neutral, where the current available to the phase differential element is small and its sensitivity falls off. By comparing neutral current with the residual of the phase CTs, REF detects winding-to-earth faults close to the star point that a standard differential might miss. It is commonly applied on solidly or impedance-earthed windings where earth-fault sensitivity matters.


  • Q. What does commissioning a transformer protection system actually involve?

    Commissioning proves that the design works as installed. It typically includes secondary injection to verify each protective element and its settings, primary injection and a stability check to confirm the differential zone is correctly wired and polarized, verification of the complete trip path through to the breaker (including trip-coil supervision and lockout), and functional testing of the mechanical trips — Buchholz, winding and oil temperature, and oil level — before the transformer is energized.


  • Q. Can Keentel work as an owner’s engineer rather than replacing our in-house team?

    Yes. Much of our protection work is delivered in an owner’s-engineer capacity — providing independent design review, studies, settings, and commissioning oversight that sit alongside a client’s own staff or EPC. The goal is to bring specialist protection expertise and an independent check to the project without displacing the people who know the asset best.



Why Keentel Engineering

Keentel Engineering delivers end-to-end electrical power engineering across high-, extra-high-, and medium-voltage systems, with more than three decades of experience in substation design, protection and control, and interconnection. Our teams in Tampa, Austin, Sacramento, and Baltimore support utilities, independent power producers, EPCs, and developers — from the initial system studies through detailed protection design settings, and field commissioning.


Whether you are protecting a new step-up transformer for a utility-scale solar or BESS project, modernizing protection on an aging substation, or adding an owner’s engineer to keep a project honest, we design protection systems that are sensitive, secure, and compliant — built to protect not just equipment, but reliability, uptime, and the people who depend on it.



A smiling man with glasses and a beard wearing a blue blazer stands in front of server racks in a data center.

About the Author:

Sandip "Sonny" R. Patel, P.E.

IEEE Senior Member · Founder & CEO, Keentel Engineering

In 1995, Sonny Patel earned his Electrical Engineering degree from the University of Illinois. But degrees don't build legacies — action does.

For three decades, he has worked the power industry from every side of the table: 16 years as a utility engineer at Exelon/Commonwealth Edison; generation leadership across hydroelectric, industrial steam turbine, and a 9 GW renewable fleet; NERC Regional Entity Senior Compliance Engineer and Audit Team Lead, auditing some of the nation's largest utilities; and testing and commissioning lead on equipment up to 765 kV — the very top of the North American grid.Utility. Generator. Regulator. Consultant. Few engineers have seen all four seats. Fewer still have sat in them.

His experience spans nuclear, hydro, conventional generation, renewables, oil and gas, mining — and today's data centers, where he is authoring a three-book series on data center design. He is a Licensed Professional Engineer in six states and a Licensed Electrical Contractor in Florida (Unlimited EC) — he doesn't just design the work; he's qualified to stand behind its execution.Today, as Founder and CEO of Keentel Engineering, Sonny leads a nationwide team of engineers delivering substation design, power system studies, NERC compliance, and commissioning — done right, coast to coast.Three decades. Every side of the table. One standard: accountable engineering.

Four workers in safety vests and helmets stand with arms crossed near wind turbines.

Let's Discuss Your Project

Let's book a call to discuss your electrical engineering project that we can help you with.

Man in a blazer and open shirt, looking at the camera, against a blurred background.

About the Author:

Sandip "Sonny" R. Patel, P.E.

IEEE Senior Member · Founder & CEO, Keentel Engineering

In 1995, Sonny Patel earned his Electrical Engineering degree from the University of Illinois. But degrees don't build legacies — action does.

For three decades, he has worked the power industry from every side of the table: 16 years as a utility engineer at Exelon/Commonwealth Edison; generation leadership across hydroelectric, industrial steam turbine, and a 9 GW renewable fleet; NERC Regional Entity Senior Compliance Engineer and Audit Team Lead, auditing some of the nation's largest utilities; and testing and commissioning lead on equipment up to 765 kV — the very top of the North American grid.

Utility. Generator. Regulator. Consultant. Few engineers have seen all four seats. Fewer still have sat in them.

His experience spans nuclear, hydro, conventional generation, renewables, oil and gas, mining — and today's data centers, where he is authoring a three-book series on data center design. He is a Licensed Professional Engineer in six states and a Licensed Electrical Contractor in Florida (Unlimited EC) — he doesn't just design the work; he's qualified to stand behind its execution.

Today, as Founder and CEO of Keentel Engineering, Sonny leads a nationwide team of engineers delivering substation design, power system studies, NERC compliance, and commissioning — done right, coast to coast.Three decades. Every side of the table. One standard: accountable engineering.

Leave a Comment

Related Posts

Data Center Cooling Plants: Evaporative vs Hybrid vs Dry
By SANDIP R PATEL • November 26, 2026
Compare data center cooling plants by water use, energy efficiency, peak power demand, generator sizing, grid impact and lifecycle costs.
Ground-Mount Solar Engineering: Complete Design Guide
By SANDIP R PATEL • November 26, 2026
Explore ground-mount solar engineering, from site selection and string sizing to collector design, grounding, battery storage and grid interconnection.
Gas turbine backlog and equipment lead times for power generation projects in 2026.
By SANDIP R PATEL • November 26, 2026
Explore the 2026 gas turbine backlog, equipment lead times, GSU supply constraints, interconnection challenges, NERC testing and project delay costs.
PLECS and Ansys simulation workflow for solid-state transformer engineering.
By SANDIP R PATEL • November 26, 2026
Explore how PLECS and Ansys support solid-state transformer simulation, thermal modeling, power loss analysis, control design, and engineering validation.
STATCOM POD tuning graph comparing 0.4 Hz power oscillation damping before and after tuning
By SANDIP R PATEL • November 26, 2026
Explore STATCOM POD tuning for power oscillation damping, including observability, controllability, lead-lag design, gain margins and commissioning.
Solid-state transformer design through EVT with efficiency vs load comparison chart
By SANDIP R PATEL • November 25, 2026
Explore solid-state transformer design, SiC architecture, protection, insulation and EVT testing for data centers and EV charging with Keentel Engineering.
SCADA architecture for power systems showing telemetry latency, RTU, IED and ICCP communication
By SANDIP R PATEL • November 25, 2026
Explore SCADA architecture for power and process systems, including DNP3, IEC 61850, telemetry latency, alarms, time sync, NERC CIP and OT security.
Transient stability studies graph comparing rotor angles and fault clearing times in power systems
By SANDIP R PATEL • November 24, 2026
Explore transient stability studies, IEEE and NERC standards, generator models, critical clearing time, breaker protection and power system stability analysis.
Joint load and generation interconnection studies showing N-1 transmission line loading scenarios Co
By SANDIP R PATEL • November 24, 2026
Learn how joint load and generation interconnection studies work, including PJM Fast Energization, MISO LARS, co-location risks and grid modeling.
