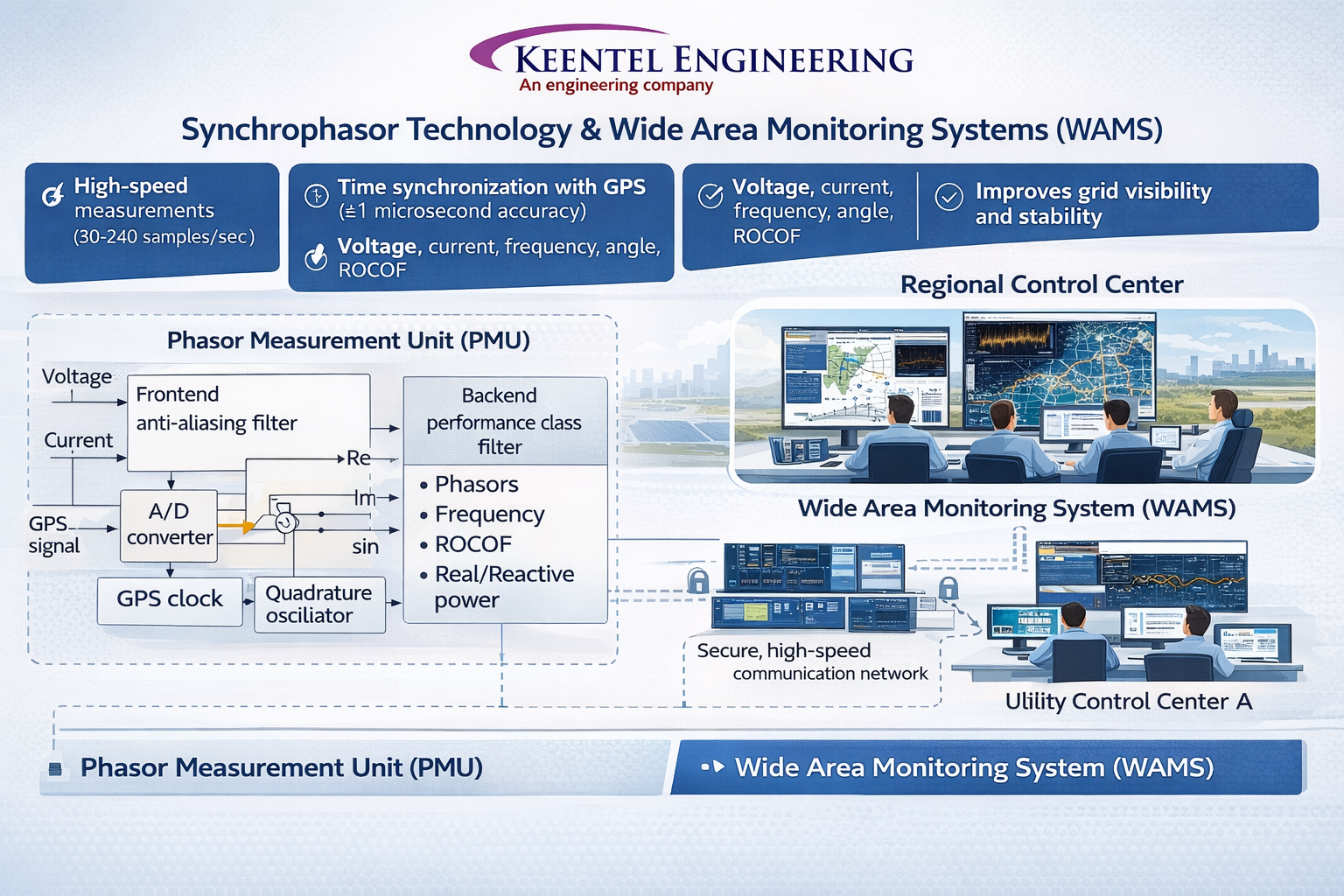

PMU , Synchrophasor Technology and Wide Area Monitoring Systems (WAMS): Transforming Grid Visibility and Stability in Modern Power Systems

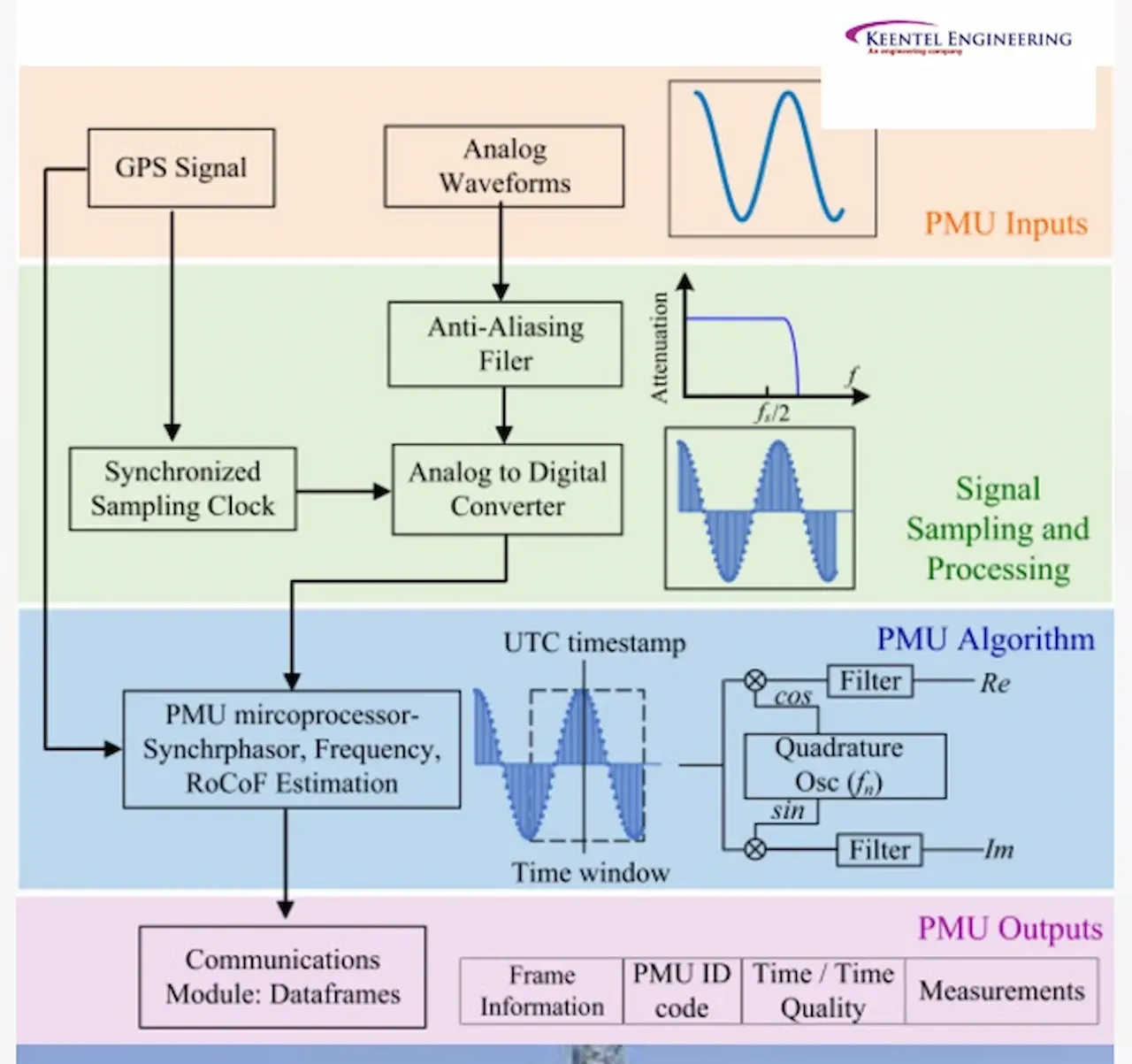

Phasor Measurement Unit (PMU) and WAMS system architecture for real-time power grid monitoring
Calendar icon. D

Mar 28, 2026  | blog

1. Introduction: The Shift from SCADA to High-Resolution Grid Intelligence

Traditional SCADA systems, while foundational, operate at time resolutions of seconds far too slow for today’s dynamic grids dominated by inverter-based resources (IBRs), renewable variability and complex interconnections.


Enter synchrophasor technology and Wide Area Monitoring Systems (WAMS) a paradigm shift enabling:


  • Sub-second situational awareness
  • Real-time angle stability monitoring
  • Oscillation detection and damping
  • Data-driven operational decision-making


For utilities, ISOs, and developers, synchrophasors are no longer optional they are becoming critical infrastructure for grid reliability and compliance.


2. What Are Synchrophasors? A Precise Engineering Definition

A synchrophasor is a time-synchronized measurement of electrical quantities (voltage/current phasors) referenced to a common time source, typically GPS.


Key Characteristics:


  • Time synchronization accuracy: ±1 microsecond
  • Reporting rates: 30–240 samples per second
  • Measured parameters:


  • Voltage magnitude & angle
  • Current magnitude & angle
  • Frequency
  • Rate of Change of Frequency (ROCOF)


Governing Standard:


  • IEEE C37.118.1 / C37.118.2



  • Defines measurement accuracy and communication protocols

PMUs are the field devices that generate synchrophasor data.


Functional Components:



  • Signal Acquisition
  • CT/PT inputs (HV/MV substations)


  • GPS Time Synchronization
  • Provides absolute timestamp alignment across grid


  • Phasor Estimation Engine
  • Uses Discrete Fourier Transform (DFT) or advanced filtering


  • Communication Interface
  • Streams data to Phasor Data Concentrators (PDCs)

3. Phasor Measurement Units (PMUs): The Core Hardware Layer

Why PMUs Are Superior to SCADA

Feature SCADA PMU
Sampling Rate 2–4 sec 30–240 samples/sec
Time Sync None GPS synchronized
Data Type RMS values Phasors + dynamic data
Use Case Monitoring Dynamic stability analysis

4. Wide Area Monitoring Systems (WAMS): System-Level Architecture

WAMS integrates PMUs across geographically dispersed locations into a unified monitoring platform.

Core Architecture:

PMUs → Local PDCs → Central PDC → Control Center Applications

Components Explained:

🔹 Phasor Data Concentrators (PDCs)


  • Align data streams by timestamp
  • Filter bad/missing data
  • Aggregate multiple PMU inputs


🔹 Communication Network


  • Fiber optic / MPLS / microwave
  • Latency requirement: <100 ms for real-time applications


🔹 Control Center Applications



  • Visualization dashboards
  • Stability monitoring tools
  • Oscillation detection systems

5. Key Applications of Synchrophasors and WAMS

5.1 Real-Time Angle Stability Monitoring


Voltage phase angle differences across the grid directly indicate system stress.

  • Large angle separation → instability risk
  • Enables operators to detect impending blackouts


5.2 Oscillation Detection and Damping


PMUs can identify:


  • Inter-area oscillations (0.1–1 Hz)
  • Local oscillations (1–3 Hz)


Advanced analytics:


  • Mode estimation
  • Damping ratio calculation
  • Real-time alarms


5.3 Frequency Stability & ROCOF Monitoring


Critical for:


  • Low-inertia systems (IBR-heavy grids)
  • Under-frequency load shedding (UFLS)


5.4 Model Validation (PSSE / TSAT / PSCAD)


Synchrophasor data is used to:


  • Validate dynamic models
  • Tune inverter controls
  • Ensure compliance with interconnection studies


5.5 Event Analysis and Post-Disturbance Forensics



High-resolution data enables:


  • Fault reconstruction
  • Relay performance validation
  • Root cause analysis

6. Integration with Renewable and Inverter-Based Resources (IBRs)

Modern grids are transitioning toward:


  • Solar PV
  • Wind
  • Battery Energy Storage Systems (BESS)


Challenges:


  • Reduced system inertia
  • Fast transient behavior
  • Complex control interactions


Role of Synchrophasors:


  • Monitor inverter dynamics
  • Detect control instabilities
  • Support grid-forming vs grid-following analysis

7. Synchrophasors vs EMS vs SCADA: Hybrid Operational Framework

System Role


  • SCADA
  • Steady-state monitoring
  • EMS
  • Control & dispatch
  • WAMS
  • Dynamic situational awareness


Future grids rely on integrated SCADA + EMS + WAMS architecture


8. Communication and Data Challenges

8.1 Latency Constraints


  • Real-time applications require <100 ms
  • Protection applications require even lower


8.2 Data Volume


  • High sampling rates → massive data streams
  • Requires:


  • Data compression
  • Edge processing


8.3 Cybersecurity Risks



  • GPS spoofing
  • Data injection attacks

9. NERC and Grid Code Relevance

Synchrophasor deployment supports compliance with:


  • NERC PRC standards
  • MOD-026 / MOD-027 (Model validation)
  • TPL standards (system stability)


Regional relevance:


  • ERCOT → dynamic model validation (DWG requirements)
  • WECC → oscillation monitoring
  • PJM / SPP → interconnection and disturbance analysis

10. Future of WAMS: AI, Big Data, and Predictive Analytics

Next-generation systems are integrating:


🔹 Artificial Intelligence


  • Predict instability before it occurs
  • Automated control actions


🔹 Digital Twins


  • Real-time grid replicas
  • Continuous model calibration


🔹 Edge Computing



  • Local decision-making at substations

11. Challenges in Implementation

  • High capital cost for PMU deployment
  • Communication infrastructure upgrades
  • Data management complexity
  • Integration with legacy systems

12. Case Studies (Confidential – Representative Engineering Scenarios)

Case Study 1: Oscillation Detection in a Renewable-Rich Grid

Scenario:


  • A 500 MW solar plant connected to a weak grid exhibited oscillations.


Solution:


  • PMUs installed at POI and nearby substations
  • Identified 0.4 Hz oscillation mode
  • Adjusted inverter control parameters


Result:



  • Damping improved from 2% → 8%
  • Grid stability restored

Case Study 2: Angle Stability Monitoring in Transmission Corridor

Scenario:


  • High loading in a 345 kV corridor caused angle separation concerns.


Solution:


  • WAMS deployed across 5 substations
  • Real-time angle monitoring implemented


Result:



  • Operators prevented cascading outage
  • Improved situational awareness

Case Study 3: Model Validation for BESS Integration

Scenario:


  • Battery system model mismatch during dynamic studies.


Solution:


  • Synchrophasor data used for validation
  • Updated PSSE dynamic model


Result:



  • Accurate simulation alignment
  • Successful interconnection approval

13. Conclusion: Synchrophasors as the Backbone of the Future Grid

Synchrophasors and WAMS are no longer emerging technologies they are essential tools for modern grid operation.


They enable:


  • Faster decision-making
  • Improved reliability
  • Better integration of renewables
  • Compliance with evolving standards


For engineering firms like Keentel Engineering, synchrophasor expertise is critical in delivering:


  • High-fidelity modeling
  • Grid compliance solutions
  • Advanced system studies

Technical FAQs (Engineer-Level)

  • 1. What is Total Vector Error (TVE) in PMU measurements?

    TVE quantifies the accuracy of synchrophasor measurements as defined in IEEE C37.118.1.


  • 2. What is the typical reporting rate of PMUs?

    30, 60, or 120 samples per second depending on system requirements.


  • 3. How does GPS synchronization impact PMU accuracy?

    It ensures time alignment across geographically dispersed measurements within microseconds.


  • 4. What is ROCOF and why is it important?

    Rate of Change of Frequency indicates system inertia and stability conditions.


  • 5. How are PMUs used in oscillation detection?

    They provide high-resolution time-series data for modal analysis.


  • 6. What is a PDC?

    A Phasor Data Concentrator aggregates and aligns PMU data streams.


  • 7. How do synchrophasors support NERC compliance?

    They enable model validation, disturbance analysis, and system monitoring.


  • 8. What is the difference between static and dynamic phasors?

    Dynamic phasors account for time-varying signals and transient conditions.


  • 9. What communication protocols are used in WAMS?

    IEEE C37.118.2 and IEC 61850 extensions.


  • 10. Can PMUs be used for protection?

    Yes, but with stringent latency and reliability requirements.


  • 11. What is angle stability?

    It refers to maintaining synchronism between generators.


  • 12. How do synchrophasors help renewable integration?

    They monitor fast dynamics of inverter-based resources.


  • 13. What are inter-area oscillations?

    Low-frequency oscillations between large grid regions.


  • 14. What is damping ratio?

    A measure of how quickly oscillations decay.


  • 15. How is PMU data used in PSSE?

    For model validation and tuning.


  • 16. What are the cybersecurity risks in WAMS?

    GPS spoofing, data injection, and communication attacks.


  • 17. What is latency requirement for real-time WAMS?

    Typically less than 100 ms.


  • 18. What is the role of edge computing in WAMS?

    Local processing to reduce latency and data load.


  • 19. How do PMUs differ from digital fault recorders?

    PMUs provide continuous synchronized data, while DFRs capture events.


  • 20. What is the future of synchrophasor technology?

    Integration with AI, predictive analytics, and digital twins.




A smiling man with glasses and a beard wearing a blue blazer stands in front of server racks in a data center.

About the Author:

Sandip "Sonny" R. Patel, P.E.

IEEE Senior Member · Founder & CEO, Keentel Engineering

In 1995, Sonny Patel earned his Electrical Engineering degree from the University of Illinois. But degrees don't build legacies — action does.

For three decades, he has worked the power industry from every side of the table: 16 years as a utility engineer at Exelon/Commonwealth Edison; generation leadership across hydroelectric, industrial steam turbine, and a 9 GW renewable fleet; NERC Regional Entity Senior Compliance Engineer and Audit Team Lead, auditing some of the nation's largest utilities; and testing and commissioning lead on equipment up to 765 kV — the very top of the North American grid.Utility. Generator. Regulator. Consultant. Few engineers have seen all four seats. Fewer still have sat in them.

His experience spans nuclear, hydro, conventional generation, renewables, oil and gas, mining — and today's data centers, where he is authoring a three-book series on data center design. He is a Licensed Professional Engineer in six states and a Licensed Electrical Contractor in Florida (Unlimited EC) — he doesn't just design the work; he's qualified to stand behind its execution.Today, as Founder and CEO of Keentel Engineering, Sonny leads a nationwide team of engineers delivering substation design, power system studies, NERC compliance, and commissioning — done right, coast to coast.Three decades. Every side of the table. One standard: accountable engineering.

Four workers in safety vests and helmets stand with arms crossed near wind turbines.

Let's Discuss Your Project

Let's book a call to discuss your electrical engineering project that we can help you with.

Man in a blazer and open shirt, looking at the camera, against a blurred background.

About the Author:

Sandip "Sonny" R. Patel, P.E.

IEEE Senior Member · Founder & CEO, Keentel Engineering

In 1995, Sonny Patel earned his Electrical Engineering degree from the University of Illinois. But degrees don't build legacies — action does.

For three decades, he has worked the power industry from every side of the table: 16 years as a utility engineer at Exelon/Commonwealth Edison; generation leadership across hydroelectric, industrial steam turbine, and a 9 GW renewable fleet; NERC Regional Entity Senior Compliance Engineer and Audit Team Lead, auditing some of the nation's largest utilities; and testing and commissioning lead on equipment up to 765 kV — the very top of the North American grid.

Utility. Generator. Regulator. Consultant. Few engineers have seen all four seats. Fewer still have sat in them.

His experience spans nuclear, hydro, conventional generation, renewables, oil and gas, mining — and today's data centers, where he is authoring a three-book series on data center design. He is a Licensed Professional Engineer in six states and a Licensed Electrical Contractor in Florida (Unlimited EC) — he doesn't just design the work; he's qualified to stand behind its execution.

Today, as Founder and CEO of Keentel Engineering, Sonny leads a nationwide team of engineers delivering substation design, power system studies, NERC compliance, and commissioning — done right, coast to coast.Three decades. Every side of the table. One standard: accountable engineering.

Leave a Comment

Related Posts

Data Center Cooling Plants: Evaporative vs Hybrid vs Dry
By SANDIP R PATEL • November 26, 2026
Compare data center cooling plants by water use, energy efficiency, peak power demand, generator sizing, grid impact and lifecycle costs.
Ground-Mount Solar Engineering: Complete Design Guide
By SANDIP R PATEL • November 26, 2026
Explore ground-mount solar engineering, from site selection and string sizing to collector design, grounding, battery storage and grid interconnection.
Gas turbine backlog and equipment lead times for power generation projects in 2026.
By SANDIP R PATEL • November 26, 2026
Explore the 2026 gas turbine backlog, equipment lead times, GSU supply constraints, interconnection challenges, NERC testing and project delay costs.
PLECS and Ansys simulation workflow for solid-state transformer engineering.
By SANDIP R PATEL • November 26, 2026
Explore how PLECS and Ansys support solid-state transformer simulation, thermal modeling, power loss analysis, control design, and engineering validation.
Solid-state transformer design through EVT with efficiency vs load comparison chart
By SANDIP R PATEL • November 25, 2026
Explore solid-state transformer design, SiC architecture, protection, insulation and EVT testing for data centers and EV charging with Keentel Engineering.
SCADA architecture for power systems showing telemetry latency, RTU, IED and ICCP communication
By SANDIP R PATEL • November 25, 2026
Explore SCADA architecture for power and process systems, including DNP3, IEC 61850, telemetry latency, alarms, time sync, NERC CIP and OT security.
Transient stability studies graph comparing rotor angles and fault clearing times in power systems
By SANDIP R PATEL • November 24, 2026
Explore transient stability studies, IEEE and NERC standards, generator models, critical clearing time, breaker protection and power system stability analysis.
Joint load and generation interconnection studies showing N-1 transmission line loading scenarios Co
By SANDIP R PATEL • November 24, 2026
Learn how joint load and generation interconnection studies work, including PJM Fast Energization, MISO LARS, co-location risks and grid modeling.
Grid flexibility load duration curve showing peak demand reduction and capacity needs
By SANDIP R PATEL • November 22, 2026
Explore dependable grid flexibility with battery storage, virtual power plants, managed EV charging and flexible loads to cut peak demand and grid costs.
