Buchholz and Sudden Pressure Relays: Transformer Protection & NERC PRC-005-6

Buchholz and sudden pressure relay transformer protection comparison
Calendar icon. D

October 24, 2026 | Blog

Part A — Buchholz Relays, Sudden Pressure Relays and PRC-005-6 at a Glance

Every liquid-filled power transformer carries two kinds of protection. Electrical protection — transformer differential (87T), restricted earth fault (87N), overcurrent (50/51) and thermal (49) — measures currents and voltages. Mechanical protection measures what the fault does to the oil: the gas it produces, the pressure wave it creates and the oil surge it drives. The Buchholz relay and the sudden pressure relay are the two classic mechanical devices, and for utility and generator transformers on the US Bulk Electric System, their trip functions fall under NERC Reliability Standard PRC-005-6 as Sudden Pressure Relaying.


Why mechanical protection still matters


A short circuit between a few turns of a large winding may change terminal currents by only a few percent — too little for a differential relay set with the slope and pickup needed for CT errors, tap changers and inrush. Yet the arc inside the tank decomposes oil into gas within milliseconds. A Buchholz relay or sudden pressure relay sees that gas or pressure directly. Mechanical relays also detect events with no electrical signature at all: core faults, loss of oil and slowly developing overheating.

The devices in one table

Device Typical ANSI number Where it is used What it senses Output
Buchholz relay (gas element) 63 (often designated 63G or 63GA) Pipe between main tank and conservator Slow gas accumulation; loss of oil Alarm
Buchholz relay (surge element) 63 (often designated 63GT or 63S) Same Oil surge toward conservator above set velocity; severe oil loss Trip
Sudden pressure relay (fault pressure relay) 63 (often designated 63SPR or 63FP) Tank wall, under oil or in gas space, especially sealed and nitrogen blanketed tanks Rapid rate of rise of oil or gas pressure Trip (often supervised)
On load tap changer protective relay 63 (often designated 63LTC or 63OSR) Pipe between tap changer compartment and its conservator Oil surge from a tap changer fault Trip
Pressure relief device 63 (often designated 63PRD) Tank cover Static overpressure; opens to vent Alarm or trip

What Keentel's model shows


Keentel Engineering built a lumped model of an internal arc in a conservator-type transformer: gas generated at about 70 cm³ per kJ of arc energy, tank and oil compliance, and oil inertia and friction in an 80 mm (about 3 inch) connecting pipe. The model computes when the oil velocity reaches a Buchholz surge setting and when a rate-of-rise pressure element would operate.

Arc power Buchholz surge at 1.0 m/s Sudden pressure element (illustrative)
0.05 MW Does not operate (steady velocity only 0.7 m/s) Does not operate
0.2 MW ≈ 457 ms ≈ 283 ms
1 MW ≈ 196 ms ≈ 51 ms
5 MW ≈ 87 ms ≈ 10 ms
20 MW ≈ 43 ms ≈ 3 ms

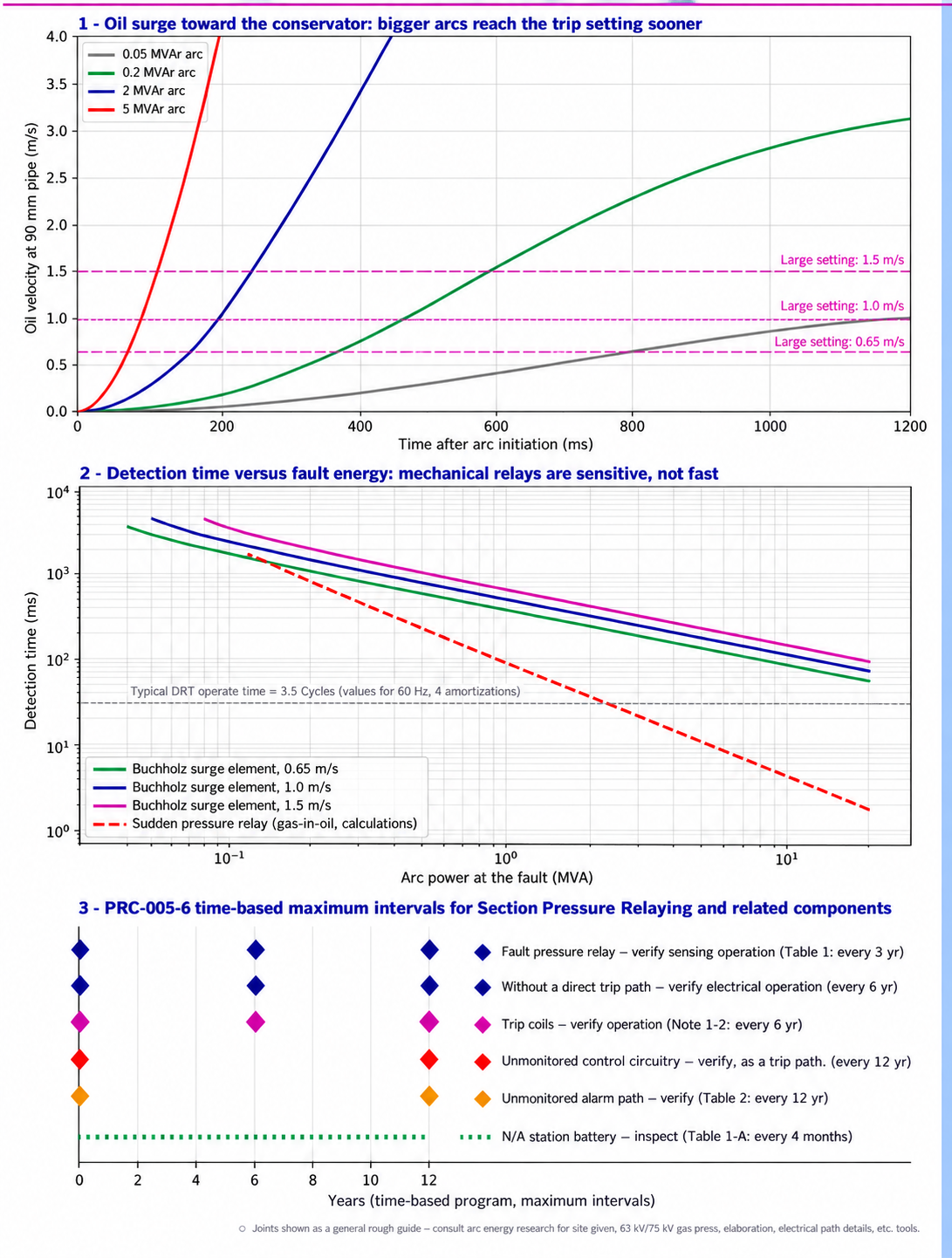

Figure 1. Keentel analysis. Panel 1: oil velocity in the Buchholz pipe for four arc powers. Panel 2: detection time versus arc power for three surge settings and a rate-of-rise pressure element. Panel 3: PRC-005-6 time-based maximum intervals for Sudden Pressure Relaying and related components.


Four lessons


  • Mechanical relays are sensitive, not fast. A 0.2 MW arc — small enough to escape a differential relay — still trips a Buchholz relay in under half a second. But for heavy faults, a differential relay operating in about 1 to 1.5 cycles is faster. The two protections complement each other.
  • There is a sensitivity floor. For a 1.0 m/s surge setting in an 80 mm pipe, the steady oil velocity reaches the setting only when gas production exceeds the pipe flow area times the setting — about 72 kW of arc power in Keentel's model. Smaller faults rely on the gas-accumulation alarm and dissolved gas analysis.
  • Pressure-rate relays are faster for large faults because pressure rises before the oil column accelerates, which is why sudden pressure relays dominate on US sealed-tank designs.
  • Maintenance is a compliance obligation. Under PRC-005-6, a fault pressure relay that trips a BES transformer must have its sensing verified at least every 6 calendar years, its lockouts every 6 years and its unmonitored control circuitry every 12 years — or be maintained under a qualifying performance-based program.


Engineering review of a common explanation


Popular explanations of the Buchholz relay often contain errors that matter during testing and troubleshooting.

Common statement Keentel's correction
"Gas collects in the upper chamber and the float rises to operate the alarm." Gas displaces oil from the top of the relay housing, so the oil level falls and the upper float drops, closing the alarm contact. Floats rise only when the relay is full of oil.
"In a severe fault, a large amount of gas makes the float rise further and operate the trip contact." The trip element is a separate lower float with a flap (baffle) that is deflected by the oil surge toward the conservator. It also operates if oil is lost and the lower float drops. It does not depend on gas volume in the relay.
"Gas is automatically released through the gas vent to the conservator." Gas is trapped in the relay housing for inspection and sampling through a test cock or gas sampling device. Only after the housing is full of gas does further gas pass up the pipe to the conservator. Analyzing the trapped gas is a key diagnostic step.
"Oil flows smoothly through the relay under normal conditions." Under normal conditions oil moves only slowly as it expands and contracts with temperature. The relay must not operate on these flows or on oil movement from cooling pumps, through-faults or energization.
"The Buchholz relay is a fast fault-detection device." It is sensitive but relatively slow: typically 50 to 300 ms or more, depending on fault energy. It supplements, not replaces, differential protection.
"Widely used in power transformers." Widely used on conservator-type transformers worldwide and increasingly in the US on large units. Many US transformers use sealed tanks or nitrogen blankets without a conservator and therefore use sudden pressure relays instead.

Part B — Mechanical Protection of Power Transformers: Buchholz Relays, Sudden Pressure Relays and NERC PRC-005-6 Compliance

1. The role of mechanical protection


1.1 Faults that electrical protection struggles to see


Consider a turn-to-turn fault in the high-voltage winding of a 230/115 kV, 300 MVA autotransformer. If a single turn of a 1,000-turn winding is shorted, the shorted turn carries a very large circulating current, but the terminal current changes only by roughly the ratio of the shorted turns to the total — a fraction of a percent of rated current in the early stage. A differential relay with a minimum pickup of 0.3 pu and a 25% to 40% slope cannot detect it. Meanwhile the arc in the shorted turn is dissipating tens to hundreds of kilowatts into the oil.


The basic relationship is the turns ratio between the fault loop and the winding:

where nf is the number of shorted turns, N is the winding turns and If,loop is the current in the shorted loop. With nf/N = 0.001 and a loop current of 20 times rated, the terminal change is only about 0.02 pu.

Fault type Electrical signature Mechanical signature
Turn-to-turn fault, few turns Very small terminal current change Arc gas and pressure; often detected by Buchholz or sudden pressure relay
Core fault, shorted laminations or core-to-ground loop Little or none Gas from overheating; Buchholz alarm and dissolved gas analysis
Loose connection or contact overheating None until failure Thermal gases; gas accumulation alarm
Partial discharge None Hydrogen; slow gas; dissolved gas analysis
Winding-to-ground fault near neutral Small in resistance- or impedance-grounded systems Arc gas and surge
Major winding or lead fault Large; differential operates Large surge and pressure rise
Loss of oil (leak) None Buchholz lower float drop; low oil level gauge

1.2 IEEE guidance


IEEE C37.91, the guide for protecting power transformers, recognizes gas accumulation relays, sudden pressure relays and pressure relief devices as important supplements to electrical protection, particularly for low-level internal faults. IEEE C57.104 (2019) governs interpretation of dissolved gases. IEEE C57.12.00 sets general transformer requirements, and IEEE C57.152 covers diagnostic field testing after a protective operation.


2. US transformer oil-preservation systems and which relays apply

Oil preservation system Description Typical mechanical relays
Sealed tank with gas space Gas cushion above the oil absorbs expansion; tank sealed from atmosphere Gas-space rapid pressure rise relay; pressure relief device
Inert gas pressure (nitrogen blanket) Nitrogen at regulated positive pressure above oil Rapid pressure rise relay; pressure relief device
Conservator (free-breathing or with bladder/diaphragm) Separate expansion tank above the main tank, connected by a pipe Buchholz relay in the connecting pipe; under-oil sudden pressure relay; pressure relief device
Conservator with separate tap-changer compartment Tap changer has its own oil and small conservator Main-tank Buchholz plus tap-changer oil surge relay

US practice historically favored sealed and nitrogen-blanketed designs, which is why sudden pressure relays are the dominant mechanical protection in the US fleet. Conservator designs with rubber bladders are now common on large transformers, especially 345 kV, 500 kV and 765 kV units and generator step-up transformers, so many US owners operate both relay types.

3. How faults generate gas



3.1 Oil and cellulose decomposition

Gas Primary source Typical fault indication
Hydrogen (H2) Partial discharge, low-energy discharge, all faults Corona, partial discharge
Methane (CH4) and ethane (C2H6) Oil overheating at lower temperatures (roughly 150 to 300 °C) Low-temperature thermal faults
Ethylene (C2H4) Oil overheating at higher temperatures (above about 300 to 700 °C) High-temperature thermal faults, hot joints, circulating currents
Acetylene (C2H2) Arcing (above about 700 °C to well over 1,000 °C) Arcing, high-energy discharge
Carbon monoxide (CO) and carbon dioxide (CO2) Cellulose (paper) degradation Overheated insulation

Temperature ranges are approximate and overlap; interpretation methods such as the Duval triangle and the methods in IEEE C57.104 consider gas ratios and rates of change together.


3.2 Gas yield of arcs


High-energy arcs in mineral oil produce on the order of 50 to 100 cm³ of gas per kilojoule of arc energy (at standard conditions), predominantly hydrogen and acetylene. Keentel's model uses 70 cm³/kJ. The gas generation rate is therefore approximately:

where Parc is the arc power. A 1 MW arc produces about 70 liters of gas per second — enough to drive oil violently toward the conservator and raise tank pressure.


3.3 Slow gas and dissolution


Slowly generated gas largely dissolves in the oil before reaching the Buchholz relay. Only when the oil near the fault becomes locally saturated, or the generation rate is high enough, do free bubbles rise and collect. This is why a Buchholz gas alarm indicates a fault that is already significant, and why online dissolved gas monitoring detects incipient faults much earlier.


4. The Buchholz relay


4.1 Construction

Element Function
Housing Cast body with inspection windows, inserted in the pipe between tank and conservator
Upper float (gas element) Supported by oil; drops when gas displaces oil, closing the alarm contact
Lower float with flap (surge element) The flap is deflected by oil surge above the set velocity; the float also drops on complete oil loss; closes the trip contact
Contacts Magnetically operated reed switches in modern relays; mercury switches in older relays
Test cock and gas sampling valve Release and collect accumulated gas; inject air for testing
Test button or mechanical test Mechanically operate the elements
Volume scale on window Estimate collected gas volume

4.2 Operating sequence

Condition What happens in the relay Output
Normal Relay full of oil; floats up; slow oil movement with temperature None
Slow gas generation Bubbles rise into relay; oil level falls; upper float drops Alarm when collected gas reaches set volume
Continued gas Relay housing fills; further gas passes to conservator Alarm persists
Severe internal fault Oil surge from tank to conservator deflects flap Trip
Severe oil loss Oil level falls below relay; lower float drops Trip (and alarm)

4.3 Typical ratings and installation

Parameter Typical values
Nominal pipe size 25 mm (1 in.), 50 mm (2 in.) and 80 mm (3 in.)
Gas volume for alarm About 100 to 300 cm³
Surge (flap) trip settings About 0.65, 1.0, 1.5 or 2.0 m/s oil velocity, selected by size and cooling
Installation Arrow pointing toward conservator; pipe rising toward conservator at about 1° to 5° (often 2° to 4°)
Straight pipe Several pipe diameters of straight run on each side, per manufacturer
Contact rating Typically suitable for 125 V dc trip and alarm circuits; verify interposing relay needs

Settings must be chosen with the transformer manufacturer. A setting too low can operate on oil movement when forced-oil pumps start or during through-faults; a setting too high reduces sensitivity.


4.4 Worked example: sensitivity floor of the surge element


The surge element can operate only if the oil velocity in the pipe reaches its setting. In steady state, the volume flow toward the conservator equals the gas generation rate:

For D = 80 mm, A = 0.00503 m², kg = 70 cm³/kJ and a setting of 1.0 m/s:

Below about 72 kW, the surge element does not operate no matter how long the arc persists; protection relies on the gas element, which needs free gas to collect, and on dissolved gas monitoring.


4.5 Worked example: time to gas alarm



If an incipient fault releases free gas into the relay at a given rate, the time to reach a 200 cm³ alarm volume is:

Free gas reaching the relay Time to alarm
10 mL/day 20 days
50 mL/day 4 days
200 mL/day 1 day
1,000 mL/day About 5 hours

These rates refer to free gas actually arriving at the relay, which can be a small fraction of the gas generated at the fault.


5. Sudden pressure relays


5.1 Principle


A sudden pressure relay — the device NERC calls a fault pressure relay — responds to the rate of rise of pressure rather than to static pressure. A typical design uses a sensing bellows or diaphragm exposed to tank pressure on one side, and a reference chamber connected through a small equalizing orifice on the other. Slow pressure changes from temperature or load equalize through the orifice; a rapid rise produces a differential pressure that operates a microswitch.

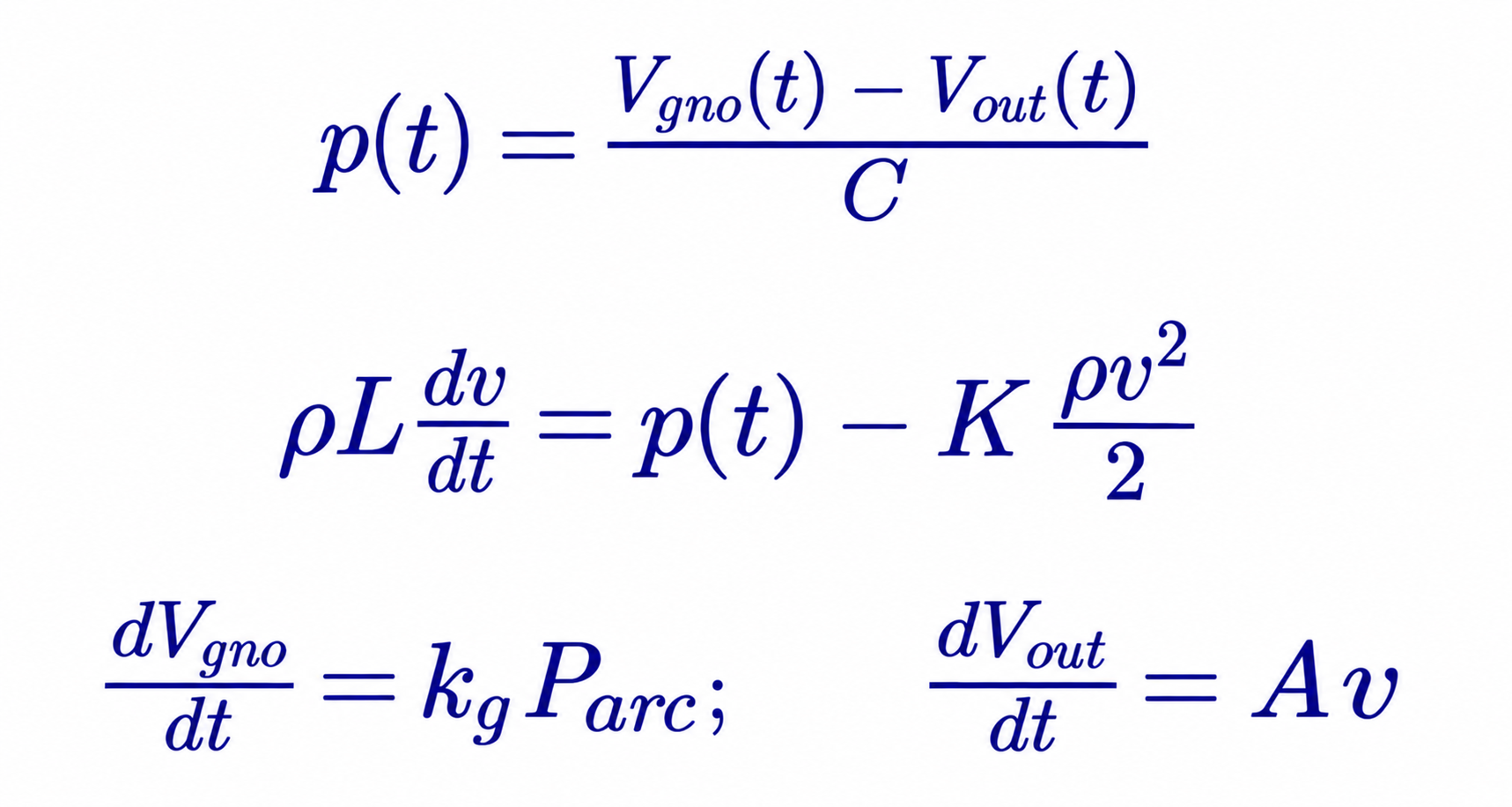

The behavior can be approximated as a first-order lag:

The relay operates when the differential reaches its setting. For a constant rate of rise r, the differential approaches rτ, so the relay has an effective minimum operating rate:

Above this rate, operating time falls as the rate increases. Manufacturers publish operating curves of time versus rate of rise; Keentel's model uses illustrative values of a 7 kPa (about 1 psi) differential setting and a 2-second equalizing time constant, giving a minimum operating rate of about 3.5 kPa/s (0.5 psi/s).


5.2 Gas-space and under-oil relays

Type Mounting Characteristics
Gas-space rapid pressure rise relay Above oil in sealed or nitrogen-blanketed tanks Responds to gas cushion pressure; affected by gas volume and temperature
Under-oil fault pressure relay Below oil level, on a tank wall valve Responds directly to oil pressure wave; faster; can be mounted on conservator transformers

5.3 Worked example: pressure rise in a gas cushion

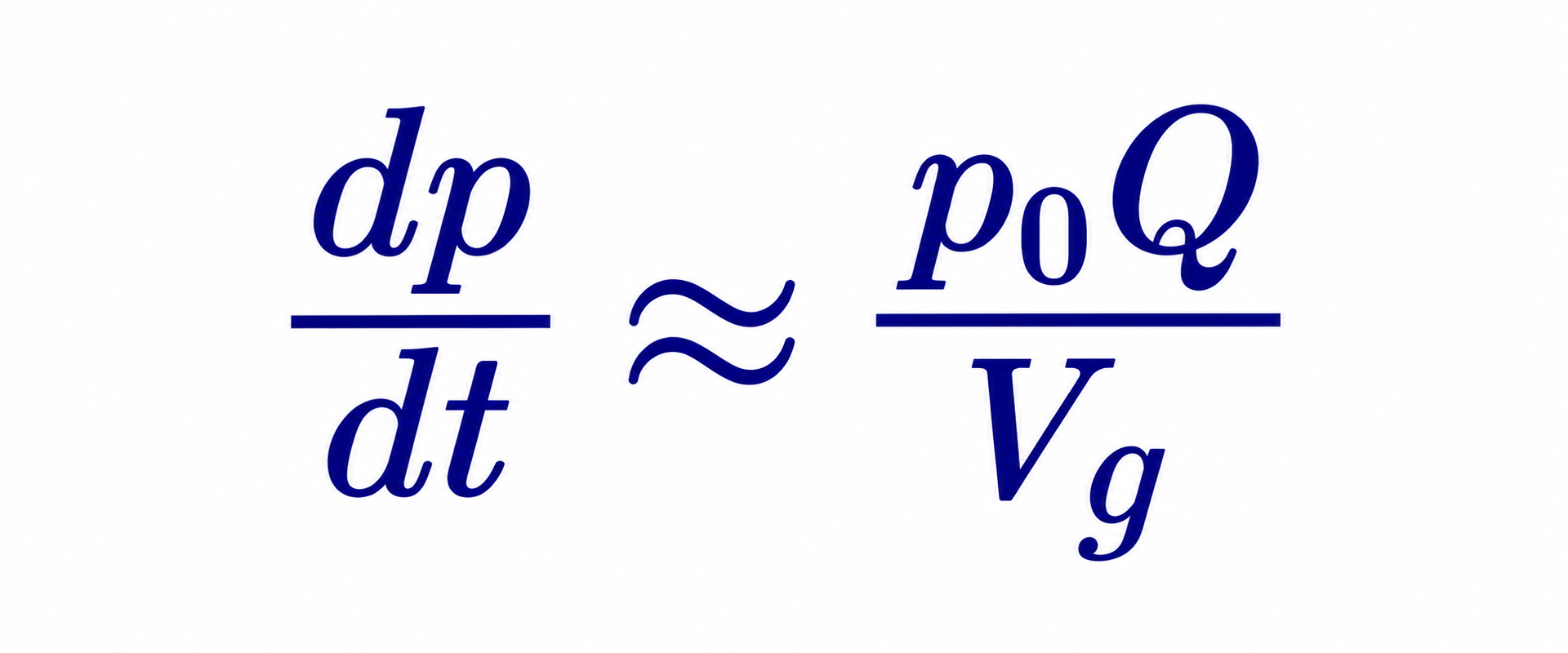

For a sealed tank with a gas cushion of volume Vg at absolute pressure p0, gas generation Q compresses the cushion approximately isothermally:

With p0 = 101.3 kPa, Vg = 3 m³ and a 1 MW arc producing 0.07 m³/s:

This is a relatively slow rate for a gas-space relay because the cushion absorbs the pressure, which is one reason under-oil relays respond faster. The real pressure wave near the fault is much faster and larger than this average estimate, because oil is nearly incompressible and the tank walls take time to deflect.



5.4 Misoperation risks


Sudden pressure relays have a mixed history of misoperation, which led many US utilities in past decades to use them for alarm only. Common causes include:

Situation Penalty basis Illustrative penalty
Transitional cluster withdrawal Nine times study costs ≈ $2.29 million
Regular cluster, withdrawal during cluster study Two times allocated study costs (or study deposit, if greater) ≈ $0.51 million
Regular cluster, after restudy, before facilities study 5% of estimated network upgrade costs 5% × $178M = $8.9 million
Regular cluster, during facilities study or after draft agreement 10% of estimated network upgrade costs $17.8 million
Regular cluster, after agreement execution 20% of estimated network upgrade costs $35.6 million

IEEE C37.91 and industry reports describe supervision schemes. A common approach requires the sudden pressure relay contact and an independent electrical indication — for example, an instantaneous overcurrent or differential element pickup, or a neutral current detector — before tripping. Supervision must be designed so that it does not block tripping for the low-level faults that the sudden pressure relay exists to detect; a supervision element set too high defeats the purpose.


5.5 Worked example: operating time versus rate of rise


For a constant rate of pressure rise r, the first-order model gives a differential pressure that builds as:

so the operating time for a setting Δpset is:

With Δpset = 7 kPa and τ = 2 s (illustrative values):

Rate of rise Rate (psi/s, approx.) Operating time
3.5 kPa/s or less 0.5 or less Does not operate
5 kPa/s 0.7 ≈ 2.4 s
10 kPa/s 1.5 ≈ 0.86 s
20 kPa/s 2.9 ≈ 0.39 s
50 kPa/s 7.3 ≈ 145 ms
200 kPa/s 29 ≈ 35 ms
1,000 kPa/s 145 ≈ 7 ms

The curve explains the relay's two personalities: very slow and insensitive to gradual changes such as thermal expansion, and very fast for the steep pressure fronts of high-energy faults. When testing, the test kit must deliver a rate of rise above the minimum operating rate; a test at too low a rate will fail a good relay, and recording the applied rate is good practice. Actual characteristics differ by manufacturer and model, so procedures must use the manufacturer's published curve and test values.


5.6 Application checklist for sudden pressure relays

Item Good practice
Location On the main tank, away from pump discharges and cooler headers, at the manufacturer's recommended elevation
Isolation valve Install a valve so the relay can be tested and replaced without draining the transformer
Seismic rating Use seismically qualified relays in seismic zones, consistent with IEEE 693 practice for substation equipment
Wiring Weatherproof terminal box, sealed conduit, drip loops, separate trip and alarm cables where practical
Interposing relay Use a fast, high-burden auxiliary relay if the relay contact rating or cable length requires it, avoiding nuisance pickup from cable capacitance
Supervision Decide on supervision philosophy with documented sensitivity analysis
Monitoring Trip circuit supervision for PRC-005-6 monitoring credit
Event recording Wire the trip contact to the transformer event recorder or digital relay input

6. Keentel's surge and pressure model


6.1 Equations



The model represents the tank as a compliance C (combining oil compressibility and tank wall flexibility), the

with ρ = 870 kg/m³, L = 3 m, D = 80 mm, K = 3 and C = 5 × 10⁻⁷ m³/Pa.



6.2 Results and interpretation

Arc power Gas rate Buchholz 0.65 m/s Buchholz 1.0 m/s Buchholz 1.5 m/s Pressure element
0.1 MW 7 L/s ≈ 524 ms ≈ 683 ms ≈ 934 ms Below minimum rate
0.2 MW 14 L/s ≈ 360 ms ≈ 457 ms ≈ 586 ms ≈ 283 ms
1 MW 70 L/s ≈ 157 ms ≈ 196 ms ≈ 243 ms ≈ 51 ms
5 MW 350 L/s ≈ 70 ms ≈ 87 ms ≈ 107 ms ≈ 10 ms

Values are read from the model and rounded. They show the trends, not design values: the lower the surge setting, the more sensitive and faster the relay, but the greater the risk of operation on non-fault oil movement. Real transformers have more complex geometry, multiple oil paths and nonlinear tank deflection; manufacturer data and field experience govern settings.



The model's predicted tank pressures at high arc power — hundreds of kilopascals within a few hundred milliseconds — also illustrate why fast electrical clearing matters. Transformer tanks and pressure relief devices are designed for modest overpressure; a high-energy fault left uncleared for several cycles can rupture a tank and start a fire, which NFPA 850 and utility fire protection practices seek to prevent.


7. An integrated transformer protection scheme

Protection Device Function Speed Sensitivity to low-level internal faults
Differential 87T Primary protection for internal faults ≈ 1 to 1.5 cycles Limited by pickup and slope
Restricted earth fault 87N (REF) Ground faults near the neutral of wye windings ≈ 1 to 2 cycles High for ground faults
Buchholz surge 63 (trip) Internal faults producing oil surge; oil loss ≈ 50 to 500 ms High
Buchholz gas 63 (alarm) Slow gas accumulation Hours to days Very high for gassing faults
Sudden pressure 63SPR Internal faults producing rapid pressure rise ≈ 1 cycle to several hundred ms High
Pressure relief 63PRD Static overpressure venting Mechanical Not a fault detector
Overcurrent 50/51 Backup for external and internal faults Coordinated Low
Thermal 49, 26 Overload and cooling failure Minutes Not a fault detector
Oil level 71 Low oil Slow Not a fault detector
Lockout 86T Trips and blocks closing of all transformer breakers Milliseconds —

7.1 Tripping design considerations



  • Mechanical relay trips typically operate the transformer lockout relay (86T), which trips all breakers and blocks reclosing until reset.
  • Breaker failure initiation from mechanical relays requires care, because breaker failure schemes usually rely on current detectors that may not pick up for low-level faults. Some designs use breaker auxiliary contact logic for these trips.
  • Contacts on the transformer are exposed to harsh environments. Interposing auxiliary relays, sealed cable entries and trip circuit monitoring improve reliability.
  • Event recording of mechanical relay operations, with time stamps, supports post-event analysis and misoperation investigation.


8. NERC PRC-005-6 in depth


8.1 Purpose and scope


PRC-005-6, "Protection System, Automatic Reclosing, and Sudden Pressure Relaying Maintenance," requires applicable entities to document and implement maintenance programs so that these systems remain in working order. Sudden Pressure Relaying was added in PRC-005-6, following FERC's directive to address it after recognizing that fault pressure relays, although not part of the defined Protection System, trip BES Elements and must be maintained.


8.2 Definitions

Term NERC definition (summarized)
Sudden Pressure Relaying A system that trips an interrupting device to isolate the equipment it monitors, consisting of a fault pressure relay and its associated control circuitry
Fault pressure relay A mechanical relay or device that detects rapid changes in gas pressure, oil pressure or oil flow indicative of faults within liquid-filled, wire-wound equipment
Unresolved Maintenance Issue A deficiency found during maintenance that causes the Component not to meet intended performance and cannot be corrected during the maintenance interval
Countable Event A Component failure requiring repair or replacement, a condition found requiring corrective action, or a Misoperation due to hardware or calibration failure

The Buchholz surge (trip) element and sudden pressure relays that trip BES Elements fall within this definition. Gas accumulation elements used only for alarm, and thermal or oil-level devices, do not.


8.3 Applicability


PRC-005-6 applies to Transmission Owners, Generator Owners and Distribution Providers for the systems that protect BES Elements. For transformers, this generally means Sudden Pressure Relaying that trips interrupting devices isolating BES transformers — for example, transmission transformers with primary and secondary terminals at 100 kV or above (such as 345/138 kV and 230/115 kV autotransformers) and generator step-up transformers of BES generating units. Dispersed generating resources are covered as specified in the standard. Each entity must confirm applicability against the BES definition and its registration.


8.4 Requirements

Requirement Summary
R1 Establish a Protection System Maintenance Program (PSMP) that identifies, for each Component Type, whether maintenance is time-based, performance-based or a combination, and documents monitoring attributes used to justify intervals
R2 For performance-based maintenance, follow Attachment A
R3 For time-based maintenance, perform the activities in the tables within the maximum intervals
R4 For performance-based maintenance, implement and follow the program
R5 Demonstrate efforts to correct Unresolved Maintenance Issues

8.5 Table 5 — Sudden Pressure Relaying

Component Maximum interval Minimum maintenance activity
Fault pressure relay 6 calendar years Verify the pressure or flow sensing mechanism is operable
Electromechanical lockout and tripping auxiliary devices in the direct trip path from the fault pressure relay 6 calendar years Verify electrical operation
Unmonitored control circuitry associated with Sudden Pressure Relaying 12 calendar years Verify all paths of the trip circuits, including auxiliary relays, through to the trip coils
Control circuitry monitored and alarmed for continuity and power No periodic maintenance specified Monitoring with alarm meeting the standard's criteria

Related components also apply: trip coils of the interrupting devices (Table 1-5, 6 calendar years), station dc supply (Table 1-4, with 4-month, 18-month and longer activities depending on battery type) and alarm paths (Table 2).


8.6 What "verify the sensing mechanism is operable" means in practice



The standard does not prescribe a test method. Common approaches:

Device Typical verification
Buchholz surge element Operate the flap mechanically with the test device; where possible, verify with a flow test; confirm contact operation and trip output
Buchholz gas element (if included in program) Inject air through the test cock until the upper float drops; confirm alarm
Under-oil sudden pressure relay Isolate from tank with the valve; apply a controlled rate of pressure rise with a test kit through the test port; confirm operation and, where specified, operating time
Gas-space rapid pressure rise relay Apply pressure rise through the test port; confirm operation

Evidence should show the device, date, method, as-found and as-left condition, and the person performing the test.


8.7 Performance-based maintenance


Attachment A allows longer intervals based on demonstrated performance:


  • define segments of similar Components with at least 60 Components in each segment;
  • maintain on time-based intervals until at least 30 Components have results;
  • set intervals so that Countable Events occur on no more than 4% of Components;
  • maintain at least the greater of 5% of the segment or 3 Components each year;
  • analyze results annually; if Countable Events reach 4% or more, implement an action plan to get below 4% within 3 years.


8.8 Worked example: performance-based segment


A utility owns 84 sudden pressure relays of the same make and model on BES transformers. Over the last two years it tested 30 relays and found 3 relays with failed microswitches or blocked orifices requiring replacement.

This exceeds the 4% threshold, so the utility cannot extend the interval. It must keep the segment on an interval that reduces Countable Events below 4% and implement an action plan, such as replacing the aging model. If, after replacement, testing finds 1 Countable Event in 32 relays (3.1%), the segment can support a performance-based interval, subject to annual testing of at least max(5% × 84, 3) = 5 relays.


8.9 Worked example: time-based compliance and VSL exposure


A transmission owner has 40 BES transformers with Sudden Pressure Relaying, each with one fault pressure relay, one lockout device and unmonitored control circuitry — 120 Components. During an audit, 7 Components are found past their maximum interval.

Under the R3 Violation Severity Levels, failing to maintain more than 5% but no more than 10% of Components is a Moderate VSL. Missing 6 Components (5.0%) would have been Lower. A robust maintenance tracking system with automatic warnings well before the maximum interval is the most effective mitigation.


8.10 Evidence and recordkeeping

Item Retention (summary)
Protection System Maintenance Program Current version and versions in effect since the last audit
Maintenance Records For intervals longer than the audit cycle, the most recent record; for shorter intervals, all records since the last audit
Unresolved Maintenance Issues All identified since the last audit, with corrective action evidence

8.11 Practical PSMP design for sudden pressure relaying


  1. Inventory: list every fault pressure relay that trips a BES Element, with location, model, trip path and associated lockouts and breakers.
  2. Classify: Component Types — fault pressure relay, lockout, control circuitry — and monitoring status.
  3. Choose methods: time-based for small fleets; performance-based for large, uniform fleets.
  4. Write procedures: test methods, equipment, safety, acceptance criteria and evidence forms.
  5. Schedule: coordinate with transformer outages; many tests require isolating valves or de-energization.
  6. Track: maintenance management system with due dates well ahead of maximum intervals.
  7. Correct: document Unresolved Maintenance Issues and corrective actions.
  8. Review: annual program review and lessons from misoperations.


8.13 Worked example: scheduling a 6-year Sudden Pressure Relaying program


A transmission owner with 42 BES transformers (each with one fault pressure relay and one lockout) wants an even workload. Tests require a transformer outage about half the time, so they must fit the outage plan.

Planning item Calculation Result
Relays and lockouts per year at the maximum interval 42 ÷ 6 7 transformers per year
Planning target with margin (complete by year 5) 42 ÷ 5 About 9 transformers per year
Unmonitored control circuitry per year at the 12-year interval 42 ÷ 12 3.5 per year; combine with relay tests where trip paths are verified
Outage-dependent tests About 50% of 9 About 5 outages per year coordinated with the system operator
Buffer for missed outages Keep at least 12 months between planned test date and maximum interval Reduces risk of a late Component

Scheduling to complete each cycle in about five years — rather than at the six-year limit — leaves room for cancelled outages, storms and relay replacements. Combining fault pressure relay tests with trip coil (6-year) and dc system activities in the same outage reduces both cost and risk.



8.14 Relationship to other NERC standards

Standard Relationship to Sudden Pressure Relaying
PRC-004 (Protection System Misoperation Identification and correction) Sudden Pressure Relaying is defined separately from the Protection System; confirm with your Regional Entity how operations of fault pressure relays are treated, and analyze every operation internally regardless.
PRC-005-6 Maintenance of Sudden Pressure Relaying, Protection Systems and Automatic Reclosing
PRC-027 Coordination of Protection Systems for performance during faults; mechanical relays should be considered in transformer protection reviews
FAC-008 Facility ratings; transformer protection and limiting elements affect ratings documentation
TOP and EOP standards Operating procedures and restoration following transformer trips

8.15 Status of revisions


PRC-005-6 is the effective version. A NERC project has been developing revisions (proposed PRC-005-7) focused mainly on clarifying applicability to protective functions in excitation systems and other equipment; entities should monitor the project for any changes that affect their programs.


9. Field testing and safety


9.1 Buchholz relay test procedure (typical)


  1. Obtain clearances and verify the transformer state required by the procedure; many tests can be done energized only with alarm and trip outputs isolated, and only if the manufacturer and owner procedures allow.
  2. Isolate trip outputs at the test switch, or schedule a transformer outage for full trip testing.
  3. Inject dry air through the test cock until the upper float operates; record volume and alarm.
  4. Release air and refill with oil; confirm the float resets.
  5. Operate the surge element with the mechanical test device; confirm the trip contact.
  6. Verify the trip path through interposing relays, lockout and breaker trip coils as required by the PSMP.
  7. Inspect wiring, cable glands and terminal boxes for moisture and damage.
  8. Restore and document.


9.2 Sudden pressure relay test procedure (typical)


  1. Close the isolation valve between relay and tank.
  2. Connect the test kit to the test port.
  3. Apply a controlled pressure rise; confirm operation; record pressure and, where specified, time.
  4. Confirm the relay does not operate for slow pressure changes, if the procedure includes this check.
  5. Vent, reopen the isolation valve and confirm the relay is reset.
  6. Verify the trip path as required.


9.3 Safety


Work on transformer protection involves energized equipment, stored energy in dc circuits and oil handling. NFPA 70E governs electrical safe work practices, OSHA 29 CFR 1910.269 applies to generation, transmission and distribution work, and the NESC governs clearances. Oil spills must be managed under spill prevention plans.


10. After an operation: diagnosis


10.1 Gas alarm


A Buchholz gas alarm means free gas has collected. Steps:


  1. Note the volume of gas in the relay and the time since the last observation.
  2. Collect a gas sample using a gas sampling device; do not ignite gas as a field test.
  3. Collect an oil sample from the main tank for dissolved gas analysis per IEEE C57.104.
  4. Compare free gas with dissolved gas using Ostwald coefficients.
  5. Decide whether the transformer can remain in service, with increased monitoring, or must be removed.


10.2 Worked example: free gas versus dissolved gas


The equilibrium concentration of a gas in oil is approximately the gas-phase concentration times the Ostwald coefficient:

Using typical mineral oil Ostwald coefficients near 25 °C:

Gas Relay gas sample (ppm) Ostwald coefficient (approx.) Equivalent in oil if in equilibrium (ppm) Measured in oil (ppm)
Hydrogen 120,000 0.06 7,200 410
Acetylene 18,000 1.2 21,600 95
Ethylene 12,000 1.7 20,400 140
Methane 25,000 0.44 11,000 260
Carbon monoxide 6,000 0.13 780 520

The measured dissolved gases are far below equilibrium with the free gas, meaning gas is being generated faster than it can dissolve — an active, energetic fault. The high acetylene and hydrogen content points to arcing. The transformer should be removed from service for diagnostic testing.

If instead the measured dissolved gases were close to the equilibrium values, the free gas would most likely have evolved slowly from oil that was already gassy, or from a historical event, and the urgency would be lower.


10.3 Trip


After a Buchholz surge or sudden pressure trip, the transformer must not be re-energized until the cause is understood. Typical diagnostics per IEEE C57.152 include dissolved gas analysis, turns ratio, winding resistance, excitation current, sweep frequency response analysis, insulation power factor and capacitance, leakage reactance, and core insulation resistance. A trip with no gas, normal electrical tests and evidence of a wiring fault or mechanical shock points to a misoperation; the cause must still be corrected.


11. Upgrades and modernization

Upgrade Benefit
Replace mercury-switch relays with reed-switch relays Removes mercury; better vibration immunity
Add trip circuit monitoring Allows PRC-005-6 "monitored" status for control circuitry, eliminating periodic trip-path verification
Add supervision to sudden pressure trips Reduces misoperation risk while preserving sensitivity
Install online dissolved gas monitors Detects incipient faults long before Buchholz gas alarm
Digital Buchholz relays and gas monitors Measure gas volume continuously and report through SCADA
Seismic-rated relays Reduce operation on ground motion
Event recorder inputs Time-stamped mechanical relay operations for analysis

12. Common misconceptions corrected

Misconception Engineering reality
"Buchholz floats rise when gas collects." Gas displaces oil; floats drop.
"Large gas volume operates the trip contact." The trip element responds to oil surge velocity or oil loss.
"Gas is vented automatically." Gas is trapped for sampling; it reaches the conservator only after the relay is full.
"Mechanical relays replace differential protection." They supplement it; they are slower for heavy faults.
"Alarm-only sudden pressure relays are covered by PRC-005-6." Sudden Pressure Relaying is defined by its trip function; alarm-only devices are not included.
"PRC-005-6 requires a specific test method." It specifies activities and maximum intervals; the entity's procedures define methods.
"Supervision always improves sudden pressure relaying." Poorly set supervision can block the very low-level faults the relay is meant to detect.

13. Key takeaways


  1. Mechanical relays detect faults electrical relays can miss, especially low-level turn faults and core faults.
  2. Understand the elements: gas accumulation alarm, oil surge trip, rate-of-rise pressure trip.
  3. Correct the physics: floats drop as gas collects; the trip element responds to surge.
  4. Know the limits: sensitivity floors, operating times and misoperation causes.
  5. PRC-005-6 applies to trip functions on BES transformers: 6 years for relays and lockouts, 12 years for unmonitored control circuitry, or a qualified performance-based program.
  6. Diagnose every operation: gas analysis, Ostwald comparison and field testing before re-energizing.


14. How Keentel Engineering helps


Keentel Engineering supports transmission owners, generator owners, renewable and storage developers and industrial facilities with transformer protection and NERC compliance, from 4 kV to 765 kV.

Service Keentel scope Outcome
PRC-005-6 program development PSMP authoring, Component inventory, Sudden Pressure Relaying identification, monitoring attribute documentation Audit-ready maintenance programs
Gap assessments and mock audits Review of evidence, intervals and Unresolved Maintenance Issue tracking Reduced compliance risk
Performance-based programs Segment design, Countable Event analysis, interval justification Optimized maintenance cost
Transformer protection design 87T, 87N, 63, 63SPR, 86T schemes, supervision logic, breaker failure integration Sensitive, secure protection
Relay settings and coordination Differential, REF, overcurrent and mechanical relay application Coordinated, documented settings
Misoperation analysis Event review, root cause, corrective action plans Fewer repeat events
Commissioning and testing support Test procedures, witness testing, trip-path verification Verified protection from day one
Transformer diagnostics support DGA interpretation, post-trip test planning, return-to-service decisions Informed asset decisions

Why clients choose Keentel Engineering


  • Protection and compliance under one roof: engineers who design protection and understand NERC standards.
  • Practical field knowledge: test procedures that work in substations, not just on paper.
  • Audit-ready documentation: programs and evidence structured for Regional Entity audits.
  • Transformer expertise: from 13.8 kV distribution transformers to 765 kV autotransformers and generator step-up units.
  • Licensed professional engineering: a Florida-registered firm with offices in Tampa, Austin, Sacramento and Baltimore, supporting projects nationwide.


Need a PRC-005-6 program review, sudden pressure relay testing procedures or transformer protection design? Talk to Keentel Engineering at (813) 389-7871, contact@keentelengineering.com, or book a 15-minute scoping call at calendly.com/keentel-engineering/15min.


Part C — Case Studies

The following are illustrative scenarios based on conditions typical of US utilities and generator owners. They show how Keentel Engineering approaches mechanical transformer protection and PRC-005-6 compliance; site details are generalized and figures are rounded.


Case Study 1 — 230/115 kV autotransformer: sudden pressure misoperation on an external fault


Situation. A transmission owner's 230/115 kV, 336 MVA autotransformer tripped by its sudden pressure relay during a close-in 115 kV line fault. The line fault was cleared correctly by line protection. The transformer showed no gas and passed initial electrical tests.


Analysis. Keentel reviews event records and finds that the sudden pressure relay operated about 80 ms after fault inception, during a through-fault of about 12 times transformer rating. The relay was an older model with no through-fault immunity, unsupervised, and installed close to a forced-oil pump discharge. Testing shows its operating rate threshold had drifted lower than the manufacturer's specification.


Engineered solution. Keentel recommends replacement with a current-generation under-oil sudden pressure relay, relocation away from the pump discharge, and supervision by a differential element pickup set low enough to preserve sensitivity for internal faults. The PSMP is updated to include the new relay and its supervision path.


Outcome. The transformer returns to service after diagnostics confirm no internal damage, and subsequent through-faults cause no further operations.


Case Study 2 — 345 kV generator step-up transformer: Buchholz alarm prevents a failure


Situation. A 345 kV generator step-up transformer at a combined-cycle plant receives a Buchholz gas alarm. Plant operators consider resetting the alarm because electrical protection shows no problem.


Analysis. Keentel advises gas sampling and dissolved gas analysis. Free gas is rich in hydrogen and acetylene, and dissolved gases are far below equilibrium with the free gas, indicating an active arcing source. Electrical testing during a planned outage shows abnormal winding resistance on one phase.


Engineered solution. Internal inspection finds a loose and burned lead connection. The connection is repaired, oil is processed, and an online dissolved gas monitor is installed with alarms to the control room.


Outcome. A likely in-service failure is avoided, and the plant gains early warning capability for the remaining life of the transformer.


Case Study 3 — Transmission owner: Sudden Pressure Relaying missing from the PSMP


Situation. During preparation for an audit, a transmission owner discovers that its PSMP covers protective relays, communications, sensing, dc supply and control circuitry, but not Sudden Pressure Relaying on 28 BES transformers.


Analysis. Keentel performs an inventory: 28 transformers, 31 fault pressure relays (some transformers have both Buchholz and sudden pressure trips), 28 lockouts already covered under protective relay control circuitry, and unmonitored trip paths. Several relays have no maintenance records in the past six years.


Engineered solution. Keentel drafts PSMP revisions defining Sudden Pressure Relaying Component Types and methods, writes test procedures for each relay model, and builds a prioritized test plan coordinated with outage schedules. Relays without records are tested first. The client also adds trip circuit monitoring on new installations to simplify future maintenance.


Outcome. The owner brings all Sudden Pressure Relaying within its maximum intervals before the audit, documents its corrective actions, and establishes a sustainable maintenance program.


Part D — Technical FAQ: Buchholz Relays, Sudden Pressure Relays and PRC-005-6

A gas- and oil-actuated relay installed in the pipe between a transformer's main tank and its conservator. It alarms on slow gas accumulation and trips on oil surge or severe oil loss.

It falls. Gas displaces oil from the top of the relay housing, lowering the oil level and dropping the upper float to close the alarm contact.

A flap or baffle on the lower element deflected by oil surging toward the conservator above the set velocity, or the lower float dropping on severe oil loss.

Alarm at about 100 to 300 cm³ of collected gas; surge trip at about 0.65 to 2.0 m/s, depending on pipe size, transformer design and cooling.

It operates in tens to hundreds of milliseconds, slower than differential protection for heavy faults, and it does not detect faults outside the tank such as bushing or lead faults.

A relay that responds to the rate of rise of oil or gas pressure in the tank. NERC calls it a fault pressure relay.

Many US transformers use sealed tanks or nitrogen blankets without conservators, so Buchholz relays cannot be applied. Sudden pressure relays work with any preservation system.

Through-fault forces, energization, pump surges, vibration, seismic events, wiring faults and relay aging can produce pressure waves or false contacts.

By requiring an independent electrical indication, such as a low-set differential or overcurrent pickup, before tripping. Supervision must be sensitive enough not to block low-level internal faults.

Maintenance of Protection Systems, Automatic Reclosing and Sudden Pressure Relaying that protect or affect BES Elements.

A system that trips an interrupting device to isolate the equipment it monitors, consisting of a fault pressure relay and its associated control circuitry.

Yes, when their oil surge or flow element trips an interrupting device for a BES Element. Alarm-only elements are not included.

Fault pressure relays and electromechanical lockouts in the direct trip path every 6 calendar years; unmonitored control circuitry every 12 calendar years; monitored and alarmed control circuitry has no periodic requirement.

No. It specifies minimum activities, such as verifying the sensing mechanism is operable, and maximum intervals. The entity's procedures define how.

Yes, through a performance-based program under Attachment A: segments of at least 60 Components, Countable Events below 4%, and annual testing of at least 5% of the segment or 3 Components.

The current PSMP and prior versions since the last audit, maintenance records showing activities and dates, and records of Unresolved Maintenance Issues and corrective actions.

Sample the free gas and the oil, analyze per IEEE C57.104, compare free and dissolved gases using Ostwald coefficients, and decide on service status based on the results.

Gas is being generated faster than it can dissolve, indicating an active and energetic fault.

Dissolved gas analysis, turns ratio, winding resistance, excitation current, sweep frequency response analysis, insulation power factor and capacitance, leakage reactance and core insulation resistance, per IEEE C57.152.

By adding monitoring and alarming of control circuitry, using performance-based programs for large uniform fleets, and replacing unreliable relay models that generate Countable Events.


References and Further Reading

Links were current at publication (October 2026).



  • NERC Reliability Standard PRC-005-6, Protection System, Automatic Reclosing, and Sudden Pressure Relaying Maintenance, and supporting Supplementary Reference and FAQ. North American Electric Reliability Corporation.
  • NERC Glossary of Terms Used in NERC Reliability Standards (Protection System, Sudden Pressure Relaying, Countable Event, Unresolved Maintenance Issue). North American Electric Reliability Corporation.
  • IEEE Std C37.91, Guide for Protecting Power Transformers. IEEE.
  • IEEE Std C37.2, Standard for Electrical Power System Device Function Numbers, Acronyms, and Contact Designations. IEEE.
  • IEEE Std C57.104-2019, Guide for the Interpretation of Gases Generated in Mineral Oil-Immersed Transformers. IEEE.
  • IEEE Std C57.152, Guide for Diagnostic Field Testing of Fluid-Filled Power Transformers, Regulators, and Reactors. IEEE.
  • IEEE Std C57.12.00, General Requirements for Liquid-Immersed Distribution, Power, and Regulating Transformers. IEEE.
  • NFPA 70E, Standard for Electrical Safety in the Workplace; NFPA 850, Fire Protection for Electric Generating Plants and High Voltage Direct Current Converter Stations. National Fire Protection Association.
  • OSHA 29 CFR 1910.269, Electric Power Generation, Transmission, and Distribution.
  • National Electrical Safety Code (NESC), IEEE C2. IEEE.

Disclaimer

his article is general technical information for educational purposes. It is not engineering, legal or compliance advice for any specific facility and does not create a professional relationship. Keentel Engineering's oil-surge and pressure model is a simplified illustration with assumed parameters; actual relay settings, operating times and test methods must follow manufacturer data, transformer design and owner procedures. NERC requirements are summarized; entities must consult the current effective standard, their registration and their Regional Entity, and maintain their own compliance programs. Designs and procedures must follow applicable IEEE standards, the NESC, NFPA codes and OSHA requirements, sealed by a licensed professional engineer where required.


Case studies are illustrative scenarios based on typical project conditions, not records of specific client projects. Figures are rounded and indicative.



NERC, IEEE, NFPA and other names are the property of their respective owners. Keentel Engineering is not affiliated with or endorsed by these organizations or any equipment vendor.

Office Address Phone
Head Office — Tampa 400 N Ashley Dr STE #2600, Tampa FL 33602 (813) 389-7871
Austin 5900 Balcones Drive STE 100, Austin TX 78731 (512) 591-0752
Sacramento 1401 21st St Ste R, Sacramento CA 95811 (916) 913-4524
Baltimore 306 W Redwood St STE 200, Baltimore MD 21201 (410) 225-2181


A smiling man with glasses and a beard wearing a blue blazer stands in front of server racks in a data center.

About the Author:

Sandip "Sonny" R. Patel, P.E.

IEEE Senior Member · Founder & CEO, Keentel Engineering

In 1995, Sonny Patel earned his Electrical Engineering degree from the University of Illinois. But degrees don't build legacies — action does.

For three decades, he has worked the power industry from every side of the table: 16 years as a utility engineer at Exelon/Commonwealth Edison; generation leadership across hydroelectric, industrial steam turbine, and a 9 GW renewable fleet; NERC Regional Entity Senior Compliance Engineer and Audit Team Lead, auditing some of the nation's largest utilities; and testing and commissioning lead on equipment up to 765 kV — the very top of the North American grid.Utility. Generator. Regulator. Consultant. Few engineers have seen all four seats. Fewer still have sat in them.

His experience spans nuclear, hydro, conventional generation, renewables, oil and gas, mining — and today's data centers, where he is authoring a three-book series on data center design. He is a Licensed Professional Engineer in six states and a Licensed Electrical Contractor in Florida (Unlimited EC) — he doesn't just design the work; he's qualified to stand behind its execution.Today, as Founder and CEO of Keentel Engineering, Sonny leads a nationwide team of engineers delivering substation design, power system studies, NERC compliance, and commissioning — done right, coast to coast.Three decades. Every side of the table. One standard: accountable engineering.

Four workers in safety vests and helmets stand with arms crossed near wind turbines.

Let's Discuss Your Project

Let's book a call to discuss your electrical engineering project that we can help you with.

Man in a blazer and open shirt, looking at the camera, against a blurred background.

About the Author:

Sandip "Sonny" R. Patel, P.E.

IEEE Senior Member · Founder & CEO, Keentel Engineering

In 1995, Sonny Patel earned his Electrical Engineering degree from the University of Illinois. But degrees don't build legacies — action does.

For three decades, he has worked the power industry from every side of the table: 16 years as a utility engineer at Exelon/Commonwealth Edison; generation leadership across hydroelectric, industrial steam turbine, and a 9 GW renewable fleet; NERC Regional Entity Senior Compliance Engineer and Audit Team Lead, auditing some of the nation's largest utilities; and testing and commissioning lead on equipment up to 765 kV — the very top of the North American grid.

Utility. Generator. Regulator. Consultant. Few engineers have seen all four seats. Fewer still have sat in them.

His experience spans nuclear, hydro, conventional generation, renewables, oil and gas, mining — and today's data centers, where he is authoring a three-book series on data center design. He is a Licensed Professional Engineer in six states and a Licensed Electrical Contractor in Florida (Unlimited EC) — he doesn't just design the work; he's qualified to stand behind its execution.

Today, as Founder and CEO of Keentel Engineering, Sonny leads a nationwide team of engineers delivering substation design, power system studies, NERC compliance, and commissioning — done right, coast to coast.Three decades. Every side of the table. One standard: accountable engineering.

Leave a Comment

Related Posts

Gas turbine backlog and equipment lead times for power generation projects in 2026.
By SANDIP R PATEL • November 26, 2026
Explore the 2026 gas turbine backlog, equipment lead times, GSU supply constraints, interconnection challenges, NERC testing and project delay costs.
PLECS and Ansys simulation workflow for solid-state transformer engineering.
By SANDIP R PATEL • November 26, 2026
Explore how PLECS and Ansys support solid-state transformer simulation, thermal modeling, power loss analysis, control design, and engineering validation.
Solid-state transformer design through EVT with efficiency vs load comparison chart
By SANDIP R PATEL • November 25, 2026
Explore solid-state transformer design, SiC architecture, protection, insulation and EVT testing for data centers and EV charging with Keentel Engineering.
SCADA architecture for power systems showing telemetry latency, RTU, IED and ICCP communication
By SANDIP R PATEL • November 25, 2026
Explore SCADA architecture for power and process systems, including DNP3, IEC 61850, telemetry latency, alarms, time sync, NERC CIP and OT security.
Transient stability studies graph comparing rotor angles and fault clearing times in power systems
By SANDIP R PATEL • November 24, 2026
Explore transient stability studies, IEEE and NERC standards, generator models, critical clearing time, breaker protection and power system stability analysis.
Joint load and generation interconnection studies showing N-1 transmission line loading scenarios Co
By SANDIP R PATEL • November 24, 2026
Learn how joint load and generation interconnection studies work, including PJM Fast Energization, MISO LARS, co-location risks and grid modeling.
Grid flexibility load duration curve showing peak demand reduction and capacity needs
By SANDIP R PATEL • November 22, 2026
Explore dependable grid flexibility with battery storage, virtual power plants, managed EV charging and flexible loads to cut peak demand and grid costs.
Temporary vs transient overvoltages chart showing TOV, lightning, switching and insulation limits
By SANDIP R PATEL • November 22, 2026
Compare temporary vs transient overvoltages, including TOV, lightning and switching surges, insulation coordination, surge arresters and NERC PRC-026.
87T vs 87N restricted earth fault protection sensitivity comparison for power transformers
By SANDIP R PATEL • November 22, 2026
Compare 87T transformer differential and 87N restricted earth fault protection, including fault sensitivity, relay settings and resistance-grounded transformers.
