Electrical Protection and Relay Coordination for Hyperscale Data Centers: A U.S. / IEEE Engineering Guide
Jul 19, 2026 | Blog
By Keentel Engineering — EHV, HV & MV Electrical Power Engineering | Tampa, FL · Austin, TX · Sacramento, CA · Baltimore, MD
Why Protection Engineering Decides Whether a Hyperscale Data Center Stays Online
A hyperscale data center is, electrically, one of the most demanding loads on the North American grid. A single campus can draw 100 to 300 MW continuously, run at a power-usage-effectiveness target that leaves almost no thermal slack, and contractually promise the operator's customers 99.982% availability (Uptime Institute Tier III) or 99.995% availability (Tier IV) — the difference between roughly 1.6 hours and 26 minutes of allowable downtime per year.
At that level, the protection and relay coordination scheme is not a code-compliance checkbox. It is the system that decides, in the first three to five cycles of a fault, whether a bolted short circuit on one 480 V branch trips one molded-case breaker or cascades upstream and drops a data hall. Good coordination isolates the smallest possible section of the network; poor coordination sacrifices selectivity and takes down critical load that was never in fault.
This guide lays out how Keentel Engineering approaches protection and coordination for U.S. hyperscale facilities: the voltage architecture under ANSI C84.1, the IEEE/ANSI/NEC standards that govern the work, a fully worked short-circuit and coordination example on a 138 kV / 13.8 kV / 4.16 kV / 480 V system at 60 Hz, and the arc-flash, grounding, and commissioning decisions that separate a resilient design from one that merely passes plan review. It closes with a detailed FAQ and three anonymized case studies drawn from the kind of work our power-systems group performs for utilities, developers, and EPC partners.

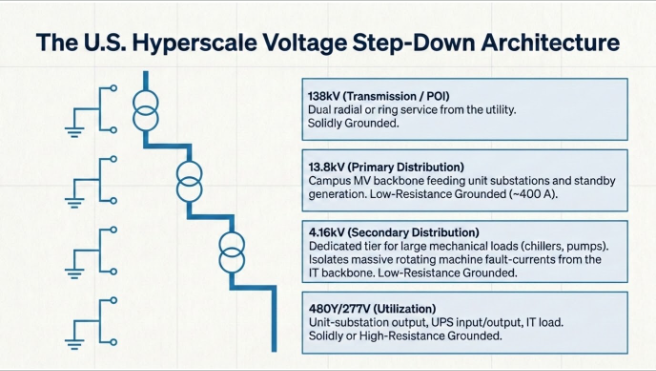

The U.S. Voltage Architecture: 138 kV → 13.8 kV → 4.16 kV → 480/277 V
In the United States, the system is designed to ANSI C84.1 nominal voltage classes and operated at 60 Hz, which sets equipment ratings, standard impedances, protective-relay curve families, and the entire standards stack. A representative U.S. hyperscale one-line steps down through four voltage classes:
| Level | ANSI C84.1 Nominal | Role in the Data Center | Typical Grounding |
|---|---|---|---|
| Transmission / utility service | 138 kV, 60 Hz | Point of interconnection (POI) from the utility; dual radial or ring service. | Solidly grounded |
| Primary distribution | 13.8 kV | Campus MV backbone; feeds unit substations and MV standby generation. | Low-resistance grounded (~400 A) |
| Secondary distribution | 4.16 kV | Large mechanical loads — chillers, high-capacity pumps, air handlers. | Low-resistance grounded (~400 A) |
| Utilization | 480Y/277 V | Unit-substation output; UPS input/output, mechanical MCCs. | Solidly or high-resistance grounded |
| Receptacle / control | 208Y/120 V | Lighting, controls, convenience power. | Solidly grounded |
The two-tier medium-voltage approach — 13.8 kV for the campus backbone and 4.16 kV for large motor loads — is deliberate. Keeping the largest rotating machines on a dedicated 4.16 kV bus limits their fault-current contribution to the 13.8 kV backbone, keeps 480 V utilization transformers a single transformation away from the critical IT load, and gives the coordination engineer more discrete grading steps between the utility and the branch circuit.
Frequency matters more than it appears. At 60 Hz, standard U.S. medium-voltage switchgear is built and tested to IEEE C37.20.2 (metal-clad) with short-circuit ratings from ANSI C37.06 (for example 25 kA, 40 kA, 50 kA, and 63 kA classes), and protective relays apply the inverse-time curve equations of IEEE C37.112. Every interrupting duty, CT saturation check, and curve-coordination step in the design flows directly from these 60 Hz ratings and the ANSI C84.1 voltage classes.
The U.S. Standards Stack (and What Each One Governs)
Protection engineering in the United States draws on a layered set of IEEE, ANSI, NFPA, and infrastructure standards. The table below maps each protection domain to the governing document.
| Domain | U.S. / IEEE-ANSI Standard | What It Governs |
|---|---|---|
| Device function numbers | IEEE C37.2 | ANSI device numbers (50, 51, 87, 21, etc.) |
| Protective relay ratings & testing | IEEE C37.90 / C37.90.1 / C37.90.2 | Relay surge, dielectric, and EMI withstand |
| Inverse-time curve equations | IEEE C37.112 | Moderately / Very / Extremely Inverse curve math |
| Short-circuit calculation | IEEE 3002.3, ANSI C37.010, C37.13 | First-cycle and interrupting duty; breaker application |
| Protection & coordination methodology | IEEE 3004 series (formerly IEEE 242, "Buff Book") | System protection philosophy |
| Reliability & availability analysis | IEEE 3006 series (formerly IEEE 493, "Gold Book") | Tier III/IV availability modeling |
| Grounding | IEEE 142 (Green Book), IEEE 80 (Substation) | System and equipment grounding |
| Arc-flash incident energy | IEEE 1584-2018 | Incident-energy calculation |
| Electrical safety in the workplace | NFPA 70E | Arc-flash labeling, PPE, and safe work practices |
| Wiring & overcurrent protection | NEC (NFPA 70) | Article 645 (IT rooms), 700/701/708 (emergency & critical systems) |
| Substation & line safety | NESC (ANSI C2) | Clearances, grounding, and worker safety |
| Substation automation & GOOSE | IEC 61850 + DNP3 (IEEE 1815) | Station bus, protection messaging, and SCADA communications |
| Time synchronization | IEEE 1588 (PTP), IRIG-B | Sub-microsecond relay and merging-unit synchronization |
| Data center topology | ANSI/TIA-942, Uptime Institute Tier | Redundancy classification (N, N+1, 2N) |
| Power quality / harmonics | IEEE 519 | Harmonic limits at the Point of Common Coupling (PCC) |
| Physical & cyber security | ISO/IEC 27001, NERC CIP | Security of critical cyber assets |
For any facility that includes on-site generation capable of exporting to or operating in parallel with the grid, NERC reliability standards and the utility's interconnection requirements (often echoing IEEE 2800 and IEEE 1547 where inverter-based or distributed resources are involved) become binding — an area where Keentel's POI interconnection and NERC-compliance practice is routinely engaged.
Protection Functions and ANSI Device Numbers
The protective scheme is organized by zone, each bounded by current transformers and cleared by dedicated relays. The following functions, identified by IEEE C37.2 device numbers, form the core of a U.S. hyperscale scheme:
| ANSI Code | Function | Applied To |
|---|---|---|
| 50 / 51 | Instantaneous / Time Overcurrent (phase) | All feeders and mains |
| 50N / 51N (50G / 51G) | Instantaneous / Time Overcurrent (ground) | All feeders, resistance-grounded systems |
| 87 | Current Differential | Transformers (87T), buses (87B), generators (87G) |
| 21 | Distance | 138 kV utility incomers / lines |
| 27 / 59 | Under- / Overvoltage | All MV and LV buses |
| 81 U/O | Under- / Overfrequency | Generators, load-shed schemes |
| 32 | Directional Power (reverse power) | Generators |
| 40 | Loss of Field / Underexcitation | Generators |
| 46 | Negative-Sequence / Unbalanced Current | Generators, feeders |
| 49 | Thermal Overload | Transformers, generators, feeders |
| 50BF | Breaker Failure | All power circuit breakers |
| 67 / 67N | Directional Overcurrent (phase/ground) | Ring or parallel-source buses |
| 25 | Synchronism Check | Generator and tie breakers |
| 86 / 94 | Lockout / Trip Auxiliary | Transformer and bus zones |
| AF (an) | Arc-Flash Light + Current | MV and LV switchgear |
Worked Example: Short-Circuit Study on a 138 kV / 13.8 kV / 4.16 kV System
The single most common defect we find when reviewing an inherited data-center design is a short-circuit table whose numbers are internally inconsistent — fault levels that cannot be produced by the stated source and transformer impedances. Below is a fully worked, self-consistent example on a 100 MVA calculation base, computed per the IEEE 3002.3 / ANSI C37.010 method.
System assumptions
- Utility source at 138 kV with an available three-phase short-circuit of 31.5 kA symmetrical → source short-circuit capacity ≈ √3 × 138 kV × 31.5 kA ≈ 7,530 MVA; source impedance ≈ 0.0133 pu on 100 MVA; X/R ≈ 20.
- Two main transformers, 138 / 13.8 kV, 60 MVA, Z = 12% → 0.20 pu on 100 MVA each.
- Distribution transformers, 13.8 / 4.16 kV, 3.75 MVA, Z = 5.75% → 1.53 pu on 100 MVA.
- Unit-substation transformers, 13.8 / 0.48 kV, 2.5 MVA, Z = 5.75% → 2.30 pu on 100 MVA.
- Standby generation, 4 × 2.5 MVA, 13.8 kV, X″d = 16% (contributes in island/parallel modes).
- Main-tie-main MV switchgear with the bus tie normally open.
Results (three-phase symmetrical, first-cycle)
| Location | Nominal | Series Impedance (pu, 100 MVA) | I 3φ (kA) | Design / Equipment Rating |
|---|---|---|---|---|
| 138 kV main bus | 138 kV | 0.0133 | 31.5 | Utility-limited; 40 kA switchgear |
| 13.8 kV bus — one transformer, tie open | 13.8 kV | 0.213 | 19.6 | Design basis per section |
| 13.8 kV bus — both transformers, tie closed | 13.8 kV | 0.113 | 36.9 | Why the tie is normally open |
| 13.8 kV feeder end (with cable Z) | 13.8 kV | ~0.28 | ~15 | Cable impedance reduces duty |
| 4.16 kV bus | 4.16 kV | 1.746 | 7.9 (+ motor contribution → ~10) | 25 kA switchgear |
| 480 V unit-substation bus | 480 V | 2.513 | ~48 (first-cycle, + motors) | 65 kA switchgear |
The critical insight is the 13.8 kV row: a single 60 MVA, 12% transformer fed from this source can pass only about 19.6 kA. Paralleling both transformers onto one section nearly doubles the duty to 36.9 kA. That is precisely why the campus runs main-tie-main with the tie normally open, backed by bus differential (87B) — the topology holds each section's duty comfortably inside the 40 kA switchgear rating and preserves selectivity. Any design claiming ~40 kA "per transformer" on this class of equipment has either mislabeled a switchgear rating as a calculated duty or has an error in the model.
Grounding and single-line-to-ground faults. The 138 kV and 480 V systems are solidly grounded, so their SLG duty is comparable to (and can locally exceed) the three-phase value. The 13.8 kV and 4.16 kV systems are low-resistance grounded, deliberately limiting ground-fault current to roughly 400 A. This is a defining U.S.-practice choice: it caps equipment damage and step-and-touch hazard, but it also means ground-fault protection at MV must be a sensitive 51G / 51N scheme (often with zero-sequence CTs) rather than relying on phase overcurrent — a coordination detail that must be engineered explicitly.
CT and PT Sizing
| Application | Full-Load Current | CT Ratio | Accuracy Class |
|---|---|---|---|
| 138 kV utility incomer (60 MVA) | 251 A | 300 : 5 | C400, 0.3B |
| 138 kV bus differential | — | 1200 : 5 | C800 |
| Transformer HV (138 kV) | 251 A | 300 : 5 | C400 |
| Transformer LV (13.8 kV) | 2,510 A | 3000 : 5 | C400 |
| 13.8 kV main / bus tie | 2,510 A | 3000 : 5 | C400 |
| 13.8 kV feeder | ≤1,200 A | 1200 : 5 | C200 |
| 13.8 / 4.16 kV transformer (HV / LV) | 157 A / 520 A | 200 : 5 / 600 : 5 | C200 |
| 4.16 kV feeder | ≤400 A | 400 : 5 | C200 |
| Standby generator (2.5 MVA) | 105 A | 150 : 5 | C100 |
| 480 V main (2.5 MVA) | 3,007 A | 4000 : 5 | C200 |
| PT Application | Ratio | Secondary | Class |
|---|---|---|---|
| 138 kV system | 1150 : 1 (138 kV : 120 V) | 120 V L-L | 0.3 |
| 13.8 kV system | 120 : 1 (14,400 : 120) | 120 V | 0.3 |
| 4.16 kV system | 35 : 1 (4,200 : 120) | 120 V | 0.3 |
| 480 V system | 4 : 1 (480 : 120) | 120 V | 0.3 |
A note we make on nearly every design review: the transformer LV overcurrent pickup must sit above the transformer's full-load current — typically 115–125% of FLC — or the relay will nuisance-trip on normal load. On the 60 MVA / 13.8 kV transformer above, LV FLC is ~2,510 A, so the CT is a 3000:5 and the 51 pickup is set near 3,000 A, never below FLC.
6. Protection and Control Design
Utility interconnection (138 kV): distance (21) with directional overcurrent backup. Dual 138 kV service is protected with three-zone distance — Zone 1 at ~80% of line impedance (instantaneous), Zone 2 at ~120% (time-delayed), Zone 3 as remote backup — coordinated with the utility per the interconnection agreement, plus 67/67N directional overcurrent where the sources can parallel.
Transformer protection (87T + 49 + 51/51G). Each 138/13.8 kV transformer carries percentage-restrained differential (87T) with second-harmonic (inrush) and fifth-harmonic (overexcitation) blocking, restricted earth fault on the resistance-grounded LV winding, thermal overload (49) using winding RTD/loss-of-life models, and sudden-pressure (63) mechanical protection. Through-fault CT saturation is checked explicitly at the 19.6 kA LV duty.
Bus protection (87B). Both 138 kV and 13.8 kV buses use high-speed, low-impedance bus differential with a check zone and breaker-fail initiation, exchanging trip and status over IEC 61850 GOOSE on a redundant station bus. Bus differential is what makes the normally-open-tie strategy safe — a bus fault is cleared in one to two cycles without waiting for upstream time-overcurrent grading.
Generator protection (87G, 32, 40, 46, 81, 27/59, 25). MV standby generators carry stator differential (87G), reverse power (32) to detect motoring, loss-of-field (40), negative-sequence (46) for unbalance, over/underfrequency (81), and synchronism check (25) at the paralleling breaker. In a Tier IV facility the generators must pick up critical load within the UPS ride-through window, so the load-shed and frequency scheme is engineered jointly with the protection.
Feeder and utilization protection (51/50, 51G, arc-flash). Feeders use coordinated time-overcurrent with instantaneous elements set above the maximum downstream fault. At the switchgear, arc-flash relays combining light sensors with a current check trip in 2–4 ms of arc initiation, dramatically reducing incident energy.
Breaker failure (50BF). Every power circuit breaker has breaker-failure logic that, on a failure-to-clear within ~100 ms, trips the upstream bus zone — essential where a stuck breaker would otherwise expose critical load to a sustained fault.
Relay Coordination: Time-Current Curves and Grading
Selectivity is achieved on a time-current characteristic (TCC) plot, grading each device against the next downstream device using a Coordination Time Interval (CTI) of 0.3–0.4 seconds — the U.S. norm for modern microprocessor relays (breaker clearing time ~3 cycles/50 ms, plus relay overtravel and margin). Curves follow IEEE C37.112 — Moderately Inverse, Very Inverse, and Extremely Inverse — chosen so the shape matches the equipment being protected (Extremely Inverse pairs well with downstream fuses and transformer damage curves).
| Device | Pickup | Curve (IEEE C37.112) | Time Dial / Delay |
|---|---|---|---|
| 138 kV incomer (51) | 300 A | Very Inverse | TD 3.0 |
| Transformer HV (51) | 350 A | Very Inverse | TD 2.5 |
| Transformer LV (51) | 3,000 A | Very Inverse | TD 2.0 |
| 13.8 kV feeder (51) | 1.25 × feeder FLC | Extremely Inverse | TD 1.5 |
| 4.16 kV feeder (51) | 1.25 × feeder FLC | Extremely Inverse | TD 1.0 |
| 480 V main (51) | 1.15 × FLC | Extremely Inverse | TD 0.5 |
| Ground (51G / 51N) | 40–60 A (on 400 A resistance-grounded MV) | Very Inverse | Coordinated separately |
The grading direction is the point: time dials increase as you move upstream (480 V main lowest, 138 kV incomer highest), so the device closest to the fault operates first and the fault is cleared at the smallest possible zone. Every setting is validated in a study tool (SKM Power*Tools, ETAP, or EasyPower) against transformer damage curves, cable withstand curves, motor starting envelopes, and the calculated fault duties — never set from rules of thumb alone.
Arc Flash: The U.S. Differentiator (NFPA 70E + IEEE 1584-2018)
A U.S. hyperscale design is not complete until it has an arc-flash study to IEEE 1584-2018 and a labeling/work-practice program to NFPA 70E. Incident energy (cal/cm²) is a direct function of available fault current and clearing time — which means protection settings and arc-flash safety are the same problem. Faster clearing (through arc-flash relays, zone-selective interlocking, or a maintenance-mode "reduced clearing time" setting) lowers incident energy and PPE category at the same time it improves selectivity.
The engineering tension is real: raising a relay's time dial to guarantee coordination can push incident energy into a higher PPE category. Resolving that trade-off — often with zone-selective interlocking (ZSI) and instantaneous "maintenance mode" settings that operators enable during energized work — is core protection-study work, and it is exactly the kind of value-engineering our studies group is retained to deliver.
Testing, Commissioning, and Lifecycle
A protection scheme is only as good as its commissioning. Best practice for U.S. facilities includes: primary (full-load) current injection to prove CT ratios and polarity end-to-end; secondary injection to verify each relay element and curve; documented relay settings management and change control; time synchronization to IEEE 1588 (PTP) or IRIG-B so sequence-of-events records are trustworthy; and periodic maintenance testing per NETA acceptance and maintenance specifications. On systems with GOOSE messaging, the station-bus network itself is tested (message timing, failover, and loss-of-communication fallback) because the protection now depends on it.
How Keentel Engineering Supports Hyperscale Protection Programs
Keentel's power-systems practice delivers the full protection lifecycle for data-center owners, developers, and EPC partners:
short-circuit device-coordination, and arc-flash studies (IEEE 3002.3 / 3004 / 1584); 138 kV substation and POI interconnection design with utility and NERC coordination; protective-relay setting files and settings management; Owner's Engineer and commissioning support including primary-injection oversight; and MEP coordination so the electrical protection scheme, the mechanical load profile, and the redundancy target (N+1, 2N, Tier III/IV) are engineered as one system rather than three. With offices in Tampa, Austin, Sacramento, and Baltimore, we support projects nationwide — with an emphasis on precision, code compliance, and value engineering over billable-hour padding.
Case Studies
The following are anonymized to protect client confidentiality; figures are representative of the engagements described.
Case Study 1 — Correcting an Inconsistent Short-Circuit Basis on a 200 MW Campus (Southeast U.S.)
A developer building a Tier III hyperscale campus inherited a protection design from a previous consultant whose short-circuit table listed roughly 40 kA at each 13.8 kV bus "per transformer." During our independent review, the numbers did not reconcile: a single 60 MVA, 12% transformer fed from the stated utility source can pass only about 19.6 kA. The 40 kA figure had been carried over from a switchgear catalog rating and mistaken for a calculated duty.
We rebuilt the model in ETAP on a consistent 100 MVA base, confirmed 19.6 kA per section with the tie open (36.9 kA if paralleled), and demonstrated that the originally specified 25 kA switchgear was adequate for normal operation but not for an inadvertent tie-closed condition. The design was revised to main-tie-main with a normally-open tie, high-speed bus differential, and 40 kA switchgear for margin. The correction avoided both an over-purchase of unnecessarily high-rated gear on some sections and a dangerous under-rating on others, and it gave the AHJ a defensible, self-consistent study for plan approval.
Case Study 2 — Resolving an Arc-Flash / Coordination Conflict at 480 V (Texas)
At a colocation facility, the commissioning team flagged that several 480 V unit-substation buses carried an arc-flash incident energy above 12 cal/cm² — pushing maintenance work into a restrictive PPE category and slowing energized service. The root cause was a raised time-dial on the main breakers, added to guarantee coordination with downstream feeders, which lengthened clearing time and drove incident energy up.
Our study group resolved the conflict with zone-selective interlocking between the main and feeder breakers plus an instantaneous maintenance-mode setting operators enable during energized work. ZSI let the main clear a bus fault quickly without sacrificing feeder selectivity for downstream faults. Recalculated incident energy dropped below 8 cal/cm² on the affected buses, lowering the PPE category, shortening safe service windows, and — because the fault now cleared faster — actually improving the selectivity margin rather than trading it away.
Case Study 3 — 138 kV POI Protection and NERC Coordination for a Generation-Backed Facility (Mid-Atlantic)
A hyperscale operator added 4 × 2.5 MVA of 13.8 kV standby generation intended to run in brief parallel with the utility during planned transfers, at a site served by dual 138 kV lines. The parallel-operation capability changed the facility from a simple load into an interconnected resource, triggering utility interconnection and NERC obligations that the original single-source protection scheme did not address.
We delivered three-zone distance protection (21) on the 138 kV incomers coordinated with the utility's line relays, added directional overcurrent (67/67N) for the parallel-source condition, and engineered the generator package — reverse power (32), loss-of-field (40), negative-sequence (46), and synchronism check (25) — with a load-shed and underfrequency (81) scheme tuned to pick up critical load inside the UPS ride-through window. We coordinated the settings and metering with the utility to satisfy the interconnection agreement and supported the NERC compliance documentation. The facility achieved its transfer-without-interruption objective while meeting every interconnection requirement on the first utility review.
Talk to Keentel Engineering
Whether you are scoping a new hyperscale campus, validating an inherited design, or updating studies after a system change, Keentel's EHV/HV/MV power-systems group can deliver the short-circuit, coordination, and arc-flash studies, the 138 kV substation and POI interconnection design, and the Owner's Engineer support your project needs — with precision, compliance, and value engineering at the core.
Keentel Engineering — Tampa, FL (HQ) · Austin, TX · Sacramento, CA · Baltimore, MD We're ready to take charge of your EHV, HV & MV electrical power engineering needs.
This article is provided for general engineering information. All fault currents, ratings, and settings shown are illustrative examples on stated assumptions; every facility requires a project-specific study stamped by a licensed Professional Engineer, coordinated with the serving utility and the authority having jurisdiction.
Frequently Asked Questions
1. Why 138 kV and 13.8 kV for a U.S. hyperscale data center?
These are the standard North American nominal voltage classes under ANSI C84.1 — 138 kV, 230kV, 345 kV for transmission-level service, 34.5 , 13.8 kV and 4.16 kV for medium-voltage distribution, and 480Y/277 V for utilization — all operated at 60 Hz. The choice sets equipment ratings, standard transformer impedances, CT/PT conventions (5 A / 120 V secondaries), and the relay curve family (IEEE C37.112), so the voltage architecture is fixed early and the entire protection design is built on it.
2. What standards govern data-center protection in the United States?
The core stack is IEEE C37.2 (device numbers), IEEE 3002.3 / ANSI C37.010 (short-circuit), IEEE 3004 series (protection & coordination, formerly the IEEE 242 Buff Book), IEEE 1584 + NFPA 70E (arc flash and electrical safety), the NEC (NFPA 70) — especially Articles 645, 700, 701, and 708 — plus ANSI/TIA-942 and the Uptime Institute Tier system for redundancy, and NERC requirements where on-site generation parallels the grid.
3. What is relay coordination, in one paragraph?
It is the deliberate setting of every protective device so that, for a fault anywhere in the system, only the device immediately upstream of the fault operates — isolating the smallest possible section while every other device holds. It is proven on a time-current characteristic (TCC) plot, with each device graded above the next by a coordination time interval of about 0.3–0.4 seconds.
4. Why is the medium-voltage bus tie normally kept open?
Because paralleling both main transformers onto one bus section nearly doubles the available fault current (in our worked example, from 19.6 kA to 36.9 kA). Running main-tie-main with the tie normally open, backed by high-speed bus differential (87B), keeps each section's duty inside the switchgear rating and preserves selectivity, while still allowing fast automatic transfer if a source is lost.
5. Why are the 13.8 kV and 4.16 kV systems resistance-grounded but 480 V is not?
Low-resistance grounding on the MV systems limits ground-fault current to roughly 400 A, sharply reducing equipment damage and arc-flash energy for the most common fault type. It requires sensitive, dedicated ground-fault relaying (51G/51N with zero-sequence CTs). At 480 V, solidly grounded (or high-resistance grounded, where continuity of service is paramount) systems are used per NEC, balancing fault-clearing against service continuity.
6. How does arc-flash mitigation relate to coordination?
They are two views of the same variable: clearing time. Incident energy (per IEEE 1584-2018) rises with both available fault current and how long the fault persists. Faster protection lowers arc-flash energy and improves selectivity — achieved through arc-flash relays, zone-selective interlocking, and maintenance-mode settings that reduce clearing time during energized work.
7. What fault-current level should hyperscale switchgear be rated for?
It depends on the source strength and transformer impedances, but for the architecture described here, typical selections are 40 kA at 13.8 kV, 25 kA at 4.16 kV, and 65 kA at 480 V — always chosen with margin above the calculated first-cycle duty and verified in a study, never assumed.
8. Do data centers need distance protection (21) if they're just a load?
When the facility connects at transmission voltage (138 kV) with dual or ring service, yes — distance protection coordinates the facility's incomers with the utility's line protection per the interconnection agreement, and directional elements (67/67N) handle parallel-source conditions. A purely radial, single-source service may use directional or non-directional overcurrent instead.
9. Which software is used for these studies?
Industry-standard packages are SKM Power*Tools, ETAP, and EasyPower. They perform the short-circuit, coordination, and arc-flash calculations and produce the TCC plots and IEEE 1584 labels. The tool is only as good as the model, so validated equipment data and field-verified impedances are essential.
10. How often should the protection study be updated?
Whenever the system changes — added transformers, new generation, a revised utility source impedance — and as a periodic best practice (many operators refresh short-circuit and arc-flash studies on a five-year cycle, or sooner if the utility's available fault duty changes). Settings and label data should be under formal change management.
11. Where does NERC compliance enter a data-center project?
Primarily through on-site generation. If standby or prime generators can export to or operate in parallel with the grid, the interconnection triggers utility and NERC requirements — protection settings, ride-through, and metering must satisfy the interconnection agreement. Keentel's POI and NERC-compliance practice is engaged specifically for this scope.

About the Author:
Sonny Patel P.E. EC
IEEE Senior Member
In 1995, Sandip (Sonny) R. Patel earned his Electrical Engineering degree from the University of Illinois, specializing in Electrical Engineering . But degrees don’t build legacies—action does. For three decades, he’s been shaping the future of engineering, not just as a licensed Professional Engineer across multiple states (Florida, California, New York, West Virginia, and Minnesota), but as a doer. A builder. A leader. Not just an engineer. A Licensed Electrical Contractor in Florida with an Unlimited EC license. Not just an executive. The founder and CEO of KEENTEL LLC—where expertise meets execution. Three decades. Multiple states. Endless impact.
Services

Let's Discuss Your Project
Let's book a call to discuss your electrical engineering project that we can help you with.

About the Author:
Sonny Patel P.E. EC
IEEE Senior Member
In 1995, Sandip (Sonny) R. Patel earned his Electrical Engineering degree from the University of Illinois, specializing in Electrical Engineering . But degrees don’t build legacies—action does. For three decades, he’s been shaping the future of engineering, not just as a licensed Professional Engineer across multiple states (Florida, California, New York, West Virginia, and Minnesota), but as a doer. A builder. A leader. Not just an engineer. A Licensed Electrical Contractor in Florida with an Unlimited EC license. Not just an executive. The founder and CEO of KEENTEL LLC—where expertise meets execution. Three decades. Multiple states. Endless impact.
Leave a Comment
We will get back to you as soon as possible.
Please try again later.
