VAR – Voltage & Reactive Control Compliance

The Voltage and Reactive family keeps transmission voltages within limits by coordinating two parties: the Transmission Operator, which sets voltage schedules and manages reactive resources, and the generator, which regulates voltage automatically and reports when it cannot. Most VAR evidence comes down to three questions — what was the schedule, how was the unit controlling to it, and who was told when that changed.

Keentel Engineering supports the engineering behind those answers: reactive capability verification, voltage schedule studies, AVR and power system stabilizer review, and plant voltage controller evaluation for solar, wind and battery storage.

  • Directory of VAR-001, VAR-002 and VAR-501-WECC with applicable functions and typical evidence
  • Generator Operator and Generator Owner obligations explained for synchronous and inverter-based plants
  • Reactive capability and voltage control evidence tied to MOD-025, MOD-026 and PRC-019
  • A practical calendar of recurring and event-driven VAR activities
3 VAR standards in this hub
GO · GOP · TOP Functions supported
Sync + IBR Voltage control technologies
30+ yrs Power-system engineering experience

About Keentel Engineering

Your Trusted Partner in Electrical Engineering and Power Systems

At Keentel Engineering, we deliver electrical power engineering services built on 30 years of experience and a commitment to excellence. Our clients include utilities, developers, EPCs, and public agencies across the U.S.

Unlike firms that sacrifice technical depth to chase billable hours, we prioritize precision, compliance, and value engineering. From transmission services and relay modeling to winterization and SCADA planning, we never compromise on quality.

Keentel Engineering team of electrical engineers in hard hats and safety vests at a high-voltage substation site

Why Choose Keentel Engineering?

Client-Focused Work Approach

At Keentel Engineering, we take pride in being the go-to electrical power engineering firm for power and utility system planning, substation design, protection, control, and power system analysis. The following attributes distinguish our team in utility-grade substation engineering and compliance-driven project delivery.

30 Years of Experience

With three decades of hands-on project delivery, we bring unmatched expertise in substation layout design, substation electrical and civil engineering, relay protection, and grid-tie solutions. Our experience includes projects in complex terrain, urban retrofit environments, and utility-scale renewable integrations.

Quality with Innovation

Our engineering process applies AutoCAD 3D, BIM modeling, and system-level substation design practices to ensure accurate planning, reduced errors, and efficient coordination across all project stakeholders.

Our workflow includes 3D substation design, enabling clash-free coordination between structural, electrical, and civil disciplines.

Attention to Detail

From grounding grid studies to relay protection settings, we engineer every detail to improve system reliability, performance, and operational safety. Our rigorous QA/QC process ensures compliance with IEEE, NFPA, and ISO/TSO interconnection standards.

Among leading electrical substation design companies, Keentel Engineering stands out for 30+ years of proven high-voltage and utility-grade project delivery.

Keentel Engineering video

Accreditations and memberships

NSPE, National Society of Professional Engineers
D-U-N-S Registered
IEEE Senior Member
BBB Accredited Business, A plus rating

Contact details

Tell Us About Your Project

1 business day reply

First name, email and what you're interested in are all we need to get moving. Everything else, including drawings or an RFP, is optional.

We reply within one business day. Sending this does not create a contract or an engineer and client relationship.

Voltage Control Is a Two-Party Obligation

Under VAR-001, the Transmission Operator is responsible for voltage and reactive control in its area: specifying voltage schedules, scheduling reactive resources and operating to keep voltages within limits. Under VAR-002, the Generator Operator operates each unit with its automatic voltage regulator in voltage control mode unless the TOP has exempted it, maintains the schedule it has been given and notifies the TOP of status and capability changes. The Generator Owner supplies step-up transformer tap information and changes. In the WECC region, VAR-501-WECC adds a regional requirement for power system stabilizers on applicable synchronous units.

The common thread is verifiable data. A voltage schedule is only achievable if the reactive capability behind it is real, and an AVR is only in voltage control mode if its settings and limiters say so.

Most VAR findings are about records, not physics. An AVR that was in service but whose status change was never logged, or a schedule that was met but never documented, reads the same as non-compliance in an audit.
VAR-001 VAR-002 VAR-501-WECC
Electrical engineers configuring protective relays and substation automation control panels for voltage and reactive control studies
Operations and evidence have to match. Voltage schedules, AVR mode and transformer records all need the same story.

VAR Standards and the Standards That Support Them

IDs are shown without version suffixes. Confirm the version in effect for your facility and audit period and check Section 4 (Applicability) for unit and facility criteria.

Standard (Keentel page) Title Applicable functions Typical evidence
VAR-001 Voltage and Reactive Control TOP Voltage schedules and their basis, reactive resource scheduling, system voltage limits, exemption decisions and communications to GOPs
VAR-002 Generator Operation for Maintaining Network Voltage Schedules GO, GOP AVR operating-mode logs, voltage schedule adherence records, TOP notifications, GSU tap information and change notices
VAR-501-WECC Power System Stabilizer GO, GOP (WECC region) PSS in-service records, tuning and test documentation, outage notifications, applicability determinations
MOD-025 Verification and Data Reporting of Generator Real and Reactive Power Capability and Synchronous Condenser Reactive Power Capability GO, TO Capability test or verification data and reported capability
MOD-026 Verification of Models and Data for Generator Excitation Control System or Plant Volt/Var Control Functions GO, TP Verified excitation or plant volt/var control models and supporting test data
PRC-019 Coordination of Generating Unit or Plant Voltage Regulating Controls, Limiters, Equipment Capabilities and Protection GO; TO with synchronous condensers Coordination of voltage regulating controls and limiters with equipment capability and protection

Function abbreviations: TOP Transmission Operator · GO Generator Owner · GOP Generator Operator · TO Transmission Owner · TP Transmission Planner.

Get Expert Support for VAR Voltage and Reactive Control Compliance

VAR Obligations by Function and Technology

Transmission side Schedules, reactive resources and communications
Generator side AVR, PSS, plant controller and GSU records
Technology Synchronous units and inverter-based resources
Transmission Operator

VAR focus

Voltage schedules, reactive scheduling, exemptions and GOP communications under VAR-001

How Keentel helps

Voltage schedule and reactive studies, documented basis for schedules and bandwidths

Generator Operator

VAR focus

Operating in automatic voltage control mode, meeting the schedule, timely notifications under VAR-002

How Keentel helps

Procedure review, notification workflow, operator guidance and evidence mapping

Generator Owner

VAR focus

GSU tap information and change notices under VAR-002; PSS under VAR-501-WECC where applicable

How Keentel helps

GSU tap documentation, AVR and PSS settings review, capability verification

Synchronous units

VAR focus

AVR mode and limiters, PSS in WECC, reactive capability curve

How Keentel helps

AVR/PSS model and settings review, MOD-025 capability, PRC-019 coordination

Inverter-based resources

VAR focus

Plant-level voltage control through the power plant controller and inverters

How Keentel helps

Plant voltage controller review, reactive capability at the point of interconnection, PSCAD™ or PSS®E verification

For IBRs, “automatic voltage control mode” lives in the power plant controller. Mode selection, droop, deadband and reactive limits are configured there and in inverter settings — evidence depends on retrieving and documenting them.

For synchronous units, AVR mode, excitation limiters and PSS status are the core records, supported by verified models and capability data.

Developments Affecting the VAR Family

New technology raises the bar for evidence. Controller settings, models and capability data are being reviewed together more often.

IBR Models
Solar panels, battery storage containers and wind turbines representing inverter-based resources and reactive power control

Growth of inverter-based resources.

As IBRs make up more of the generation fleet, TOPs rely on plant controllers for voltage support, and the evidence for VAR-002 increasingly comes from controller configurations rather than exciter panels.

Category 2 IBR registration.

Newly registered GO/GOP IBR owners take on VAR-002 obligations for their plants as registration and applicable implementation plans take effect.

Model and data expectations.

FERC Order No. 901 directs NERC to address IBR model validation and data sharing in phases, which is expected to raise expectations for the plant controller models and capability data that underpin voltage schedules.

Tighter links across families.

Reactive capability reported under MOD-025, models verified under MOD-026 and limiter coordination under PRC-019 are increasingly reviewed together with VAR evidence.

A voltage schedule the plant cannot physically meet is a problem for both parties. Verified reactive capability at the point of interconnection is the foundation for a workable schedule.

Where to Focus First

Generator Operators:

confirm the notification process works on nights and weekends and that every AVR or PSS status change is logged with time and recipient.

Generator Owners:

confirm the TOP has current GSU tap information and that tap changes trigger a notice.

IBR owners:

document the plant controller’s voltage control mode, setpoints and reactive limits, and confirm they match what the TOP expects.

Transmission Operators:

make sure each voltage schedule has a documented basis and has been communicated to the right GOP.

Everyone:

reconcile reported reactive capability with MOD-025 results so the numbers used in operations are the verified ones.

A VAR View of the Compliance Year

Many VAR obligations are event-driven. Exact notification timelines and review periods come from the standard version in effect and your TOP’s instructions.

Activity Typical cadence Standards
Operation in automatic voltage control mode and schedule adherence Continuous VAR-002
Notification of AVR, PSS or capability status changes Event-driven, within the timelines in the standard VAR-002, VAR-501-WECC
Voltage schedule issue and revision When the TOP issues or revises a schedule VAR-001, VAR-002
GSU tap information and change notices On request and after tap changes, per the standard VAR-002
Reactive capability verification Periodic, on the cycle in the standard, and after relevant equipment changes MOD-025
Excitation or plant volt/var model verification Periodic and after relevant changes, per the standard MOD-026
PSS tuning and in-service verification Per the regional standard and unit commissioning or modification VAR-501-WECC

How Keentel Supports VAR Compliance

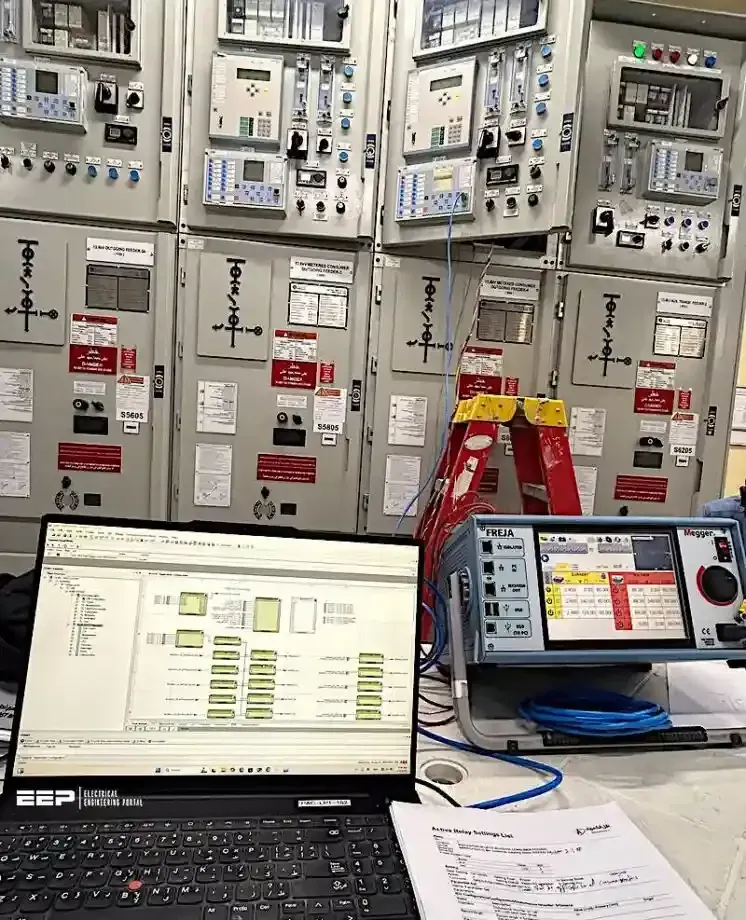

Field Records Controller Review
Engineers inspecting electrical control equipment with a laptop for voltage control, settings review and compliance evidence
Keentel ties the field record to the compliance record. Settings, models, studies and notifications are checked together.

Reactive capability verification

MOD-025 test planning, data review and capability reporting that give VAR-002 schedules a verified foundation.

Voltage schedule studies

For TOPs and plants: studies of achievable voltage schedules and bandwidths given capability, GSU taps and system conditions.

AVR and PSS model and settings review

Review of excitation, limiter and stabilizer settings and models, including IEEE 421.5 model representation and MOD-026 alignment.

IBR plant voltage controller review

Power plant controller mode, droop, deadband and reactive limit review, with simulation in PSS®E or PSCAD™ where needed.

GSU tap documentation

Tap position, range and impedance records assembled for VAR-002 requests and change notices.

Procedures and evidence

GOP notification procedures, logs and requirement-mapped evidence for audit.

How a VAR Engagement Runs

The process connects field settings to audit evidence.

Each step moves from applicability and records to engineering verification, correction and documentation.

01

Confirm obligations

Identify which VAR requirements apply to each unit or plant, including any regional requirements.

02

Gather the records

Voltage schedules, AVR and PSS settings, plant controller configuration, GSU data, capability tests and logs.

03

Verify the engineering

Check reactive capability, control settings, models and limiter coordination against each other.

04

Test the process

Walk through the notification and logging workflow with the GOP to confirm it produces evidence.

05

Close the gaps

Recommend setting, study, procedure or data corrections and verify them.

06

Document

Issue the evidence package and keep it current as equipment or schedules change.

What a VAR Engagement Produces

Engineering Verified studies and settings
Evidence Requirement-mapped documentation
Operations Records ready for review
Deliverable What it gives you
VAR applicability summary Each unit or plant mapped to the VAR requirements that apply
Reactive capability report Verified capability at the terminals and point of interconnection, reconciled with MOD-025
Voltage schedule study Achievable schedule and bandwidth with documented assumptions
AVR / PSS / plant controller review Settings, modes and models checked against expectations and standards
GSU tap data sheet Tap information ready for TOP requests and change notices
Notification procedure and evidence index A workable GOP process and a requirement-mapped record of compliance

Explore Keentel's Voltage and Reactive Control Compliance Services

VAR Gaps We See Most Often

Gap Consequence
AVR or PSS status changes not logged The unit may have been compliant, but the entity cannot demonstrate it.
Notifications made but not recorded No evidence of who was told, or when.
Reported reactive capability differs from verified capability Schedules and operating studies rely on numbers the unit cannot deliver.
IBR voltage control mode undocumented The owner cannot show the plant was regulating voltage as required.
GSU tap information out of date The TOP’s schedule assumptions no longer match the installed transformer.
Limiter settings not coordinated VAR operation and PRC-019 coordination evidence conflict with each other.

How VAR Connects to Other NERC Standards

MOD — capability and models

MOD-025 reactive capability and MOD-026 excitation or plant volt/var models are the technical backbone of VAR evidence.

PRC — coordination

PRC-019 requires voltage regulating controls and limiters to coordinate with equipment capability and protection.

TOP — operating data

TOP-003 data specifications often request AVR, PSS and reactive capability data used in voltage control.

TPL and FAC — studies and limits

Planning models and voltage-based SOLs depend on accurate reactive capability and control models.

Registration

GO and GOP registration, including Category 2 IBRs, determines who holds VAR-002 obligations.

VAR Family — Frequently Asked Questions

The Transmission Operator specifies the voltage schedule under VAR-001. The Generator Operator is responsible under VAR-002 for operating the unit to maintain it, or notifying the TOP when it cannot.
For inverter-based resources, voltage regulation is typically performed at the plant level by the power plant controller, coordinating the inverters and any reactive devices. Operating in voltage control mode means the controller is actively regulating voltage to the schedule rather than holding a fixed power factor or reactive output.
VAR-002 allows the Transmission Operator to exempt a unit from operating in automatic voltage control mode. The exemption should be documented by the TOP and retained by the GOP.
Generator Owners provide step-up transformer tap information to the TOP when requested and notify the TOP of changes to tap settings. We assemble that information from nameplates, test reports and field records.
No. VAR-501-WECC is a regional standard that applies only in the WECC region, and within it only to units meeting the standard’s applicability criteria.
MOD-025 verifies and reports a unit’s real and reactive capability. That verified capability is what the TOP and GOP should rely on when setting and meeting voltage schedules.
VAR-002 requires notifications to the TOP for changes such as AVR status and reactive capability changes, within the timelines in the version in effect. We help GOPs build procedures and logs that capture every notification.
Yes. We review mode selection, voltage setpoint, droop, deadband and reactive limits, compare them with the TOP’s expectations and the plant’s capability, and simulate behavior where needed.
The same excitation limiters and plant controller limits that affect voltage control must coordinate with equipment capability and protection under PRC-019. Reviewing them together avoids conflicting evidence.
No. Keentel’s NERC services cover Operations & Planning standards only. CIP cybersecurity is a separate discipline.

Back Every Voltage Schedule With Verified Data

Send us your voltage schedule, capability data and AVR or plant controller settings. Keentel will verify they agree, close the gaps and organize the VAR evidence for audit.

Call 813-389-7871 · contact@keentelengineering.com

Who We've Served

Serving utilities, EPCs, developers, and infrastructure organizations supporting critical power systems nationwide.

Voltage & Reactive Power Compliance Videos

Technical guidance from Keentel Engineering covering reactive capability, voltage control, AVR operation, generator and IBR capability verification, MVAr supply and absorption, and engineering considerations supporting NERC VAR compliance.

Subscribe on YouTube

PJM D-Curve Reactive Capability Testing for IBRs

Reactive capability testing for inverter-based resources, including MW/MVAr operating limits, reactive output and absorption, voltage support, and verified plant capability.

MOD-025 Generator Real & Reactive Capability Verification

Generator capability verification covering real and reactive output, AVR operation, voltage schedule coordination, operating limits, and documentation of sustainable MVAr capability.

Generator Reactive Power Capability & Voltage Control

How generator capability curves define reactive supply and absorption, how excitation and voltage affect MVAr limits, and why declared capability can differ from what reaches the grid.

FAC-008-5 Facility Ratings Compliance

Facility ratings methodology, documentation, equipment limits, and NERC compliance requirements for reliable grid operation.

PRC-006-5 NERC Compliance – UFLS

Underfrequency load-shedding requirements, program coordination, studies, settings, and compliance documentation.

NERC PRC-019-2 Compliance Services

Coordination of generating-unit voltage controls, limiters, protection functions, engineering studies, and compliance evidence.

PRC-005-6 Protection System Maintenance

Protection-system maintenance programs, testing intervals, evidence tracking, documentation, and audit-ready compliance.

MOD-025 & MOD-026 After COD

Post-COD verification and model validation requirements for generator capability, excitation controls, and dynamic models.

PRC-029-1 Compliance Deadlines & Enforcement Discretion

Key compliance timing, implementation expectations, documentation planning, and readiness considerations for PRC-029-1.

 Blogs

MOD-025 & MOD-026 After COD: Verification & Model Validation Guide
MOD-025 & MOD-026 After COD: Verification & Model Validation Guide
By SANDIP R PATEL • August 15, 2026
Learn MOD-025 and MOD-026 post-COD requirements for generator capability verification, PSS®E and PSCAD model validation, IBR testing, and NERC compliance.
Read More →
Mastering Synchronous Generator Modeling for Grid Stability: Insights from IEEE 1110-2019 and Keentel Engineering
Mastering Synchronous Generator Modeling for Grid Stability: Insights from IEEE 1110-2019 and Keentel Engineering
By SANDIP R PATEL • August 22, 2025
Learn how IEEE 1110-2019 improves synchronous generator modeling for power system stability, validation, and NERC compliance in modern grids.
Read More →
PRC-019-2 Compliance Guide | Keentel Engineering
PRC-019-2 Compliance Guide | Keentel Engineering
By SANDIP R PATEL • August 12, 2026
Learn how to manage NERC PRC-019-2 generator voltage control coordination, R1 and R2 evidence, audit readiness, inverter-based resources, and compliance software workflows.
Read More →
MOD-025 Reactive Capability Testing in the PJM Footprint
MOD-025 Reactive Capability Testing in the PJM Footprint
By SANDIP R PATEL • September 20, 2026
Every five years, the owner of a large generator connected to the bulk electric system has to prove two things to the people who plan and operate the grid: how much real power the unit can really deliver, and how much reactive power it can push out or pull in while doing it.
Read More →
Generator Capability Curve: Reactive Power Absorption Guide
Generator Capability Curve: Reactive Power Absorption Guide
By SANDIP R PATEL • September 20, 2026
Understand generator capability curves, reactive power absorption, MVAr limits, MOD-025 verification, protection coordination, and grid requirements.
Read More →
ERCOT Reactive Capability Testing: Compliance, CURL, and Best Practices Explained
ERCOT Reactive Capability Testing: Compliance, CURL, and Best Practices Explained
By SANDIP R PATEL • July 24, 2025
Ensure ERCOT compliance with expert-tested CURL/URL verification, telemetry protocols, and RARF updates. Read Keentel's practical guide to reactive testing.
Read More →
PRC-030-1 R1 Event Detection Guide for IBR Owners
PRC-030-1 R1 Event Detection Guide for IBR Owners
By SANDIP R PATEL • September 22, 2026
Learn PRC-030-1 R1 event detection requirements for inverter-based resources, SEL platforms, disturbance monitoring, and audit-ready compliance.
Read More →
PSS®E and PSCAD™ Model Updates for Power Plants
PSS®E and PSCAD™ Model Updates for Power Plants
By SANDIP R PATEL • September 22, 2026
Learn how PSS®E and PSCAD™ model updates support plant augmentations, repowering, equipment changes, testing, benchmarking, and grid compliance.
Read More →
NERC Large Load Registration: Data Center CLO Standards Guide
NERC Large Load Registration: Data Center CLO Standards Guide
By SANDIP R PATEL • September 9, 2026
Learn how NERC computational load registration impacts data centers, CLO standards, ride-through requirements, modeling, and grid reliability compliance.
Read More →
NERC MOD-032-1 Compliance: CAISO Generator Data Guide
NERC MOD-032-1 Compliance: CAISO Generator Data Guide
By SANDIP R PATEL • September 6, 2026
Learn how NERC MOD-032-1 applies across CAISO, SCE, PG&E, VEA and SDG&E, including generator data, PSLF models, EMT requirements and WECC submissions.
Read More →
NERC IBR Registration: Compliance Guide for Generator Owners
NERC IBR Registration: Compliance Guide for Generator Owners
By SANDIP R PATEL • September 5, 2026
Understand NERC IBR registration requirements, Category 2 obligations, compliance programmes, modelling, verification, ride-through, and owner responsibilities.
Read More →
NERC Data Center Rules
NERC Data Center Rules
By SANDIP R PATEL • August 22, 2026
Learn how NERC's new data center rules affect registration, modeling, protection, compliance, and what computational load operators should do now.
Read More →
POI Interconnection for Data Centers & Large Loads | 2026 Guide
POI Interconnection for Data Centers & Large Loads | 2026 Guide
By SANDIP R PATEL • August 20, 2026
2026 guide to POI interconnection for data centers and large loads. Explore ISO/RTO requirements, grid studies, PSCAD modeling, costs, timelines and NERC rules.
Read More →
PRC-005-6 NERC Compliance Guide | Protection System Maintenance
PRC-005-6 NERC Compliance Guide | Protection System Maintenance
By SANDIP R PATEL • August 12, 2026
Learn PRC-005-6 NERC compliance requirements for Protection System maintenance, Automatic Reclosing, Sudden Pressure Relaying, PBM, audit readiness, and compliance software.
Read More →
PRC-006-5 NERC Compliance & UFLS Guide | Keentel Engineering
PRC-006-5 NERC Compliance & UFLS Guide | Keentel Engineering
By SANDIP R PATEL • August 11, 2026
Complete PRC-006-5 NERC compliance guide covering UFLS requirements, dynamic studies, audit readiness, evidence management, event assessment, and CAPs.
Read More →
PRC-029-1 CAISO Compliance Guide
PRC-029-1 CAISO Compliance Guide
By SANDIP R PATEL • August 7, 2026
Understand NERC PRC-029-1 ride-through requirements for IBRs in the CAISO region — voltage/frequency curves, key dates, EMT modeling, and compliance steps.
Read More →
SEL RTAC Protection Monitoring for NERC PRC-005
SEL RTAC Protection Monitoring for NERC PRC-005
By SANDIP R PATEL • July 18, 2026
Learn how SEL RTAC protection monitoring supports NERC PRC-005 compliance, predictive maintenance alarms, automated reporting, and relay verification.
Read More →
NERC Large Loads Action Plan (LLAP) Guide for AI Data Centers
NERC Large Loads Action Plan (LLAP) Guide for AI Data Centers
By SANDIP R PATEL • July 8, 2026
Learn how NERC's Large Loads Action Plan impacts AI data centers, grid interconnection, compliance, modeling, and power system reliability in 2026.
Read More →
CCPP Electrical Design Engineering | 30%, 60%, 90% & IFC
CCPP Electrical Design Engineering | 30%, 60%, 90% & IFC
By SANDIP R PATEL • July 7, 2026
Learn the complete CCPP electrical design process, from 30% through IFC, including interconnection, power system studies, protection, grounding, and NERC compliance.
Read More →
Synchronous Condenser Protection: Complete Guide 2026
Synchronous Condenser Protection: Complete Guide 2026
By SANDIP R PATEL • June 20, 2026
Learn synchronous condenser protection, loss of field settings, NERC PRC compliance, and protection philosophy. Discover expert engineering guidance.
Read More →
NERC Compliance for Generator Owners | Audit-Ready Guide
NERC Compliance for Generator Owners | Audit-Ready Guide
By SANDIP R PATEL • June 11, 2026
NERC compliance guide for Generator Owners and Operators covering audits, CIP cybersecurity, IBR standards, and managed compliance. Learn more.
Read More →
NERC Large Loads: Grid Reliability Risks Explained
NERC Large Loads: Grid Reliability Risks Explained
By SANDIP R PATEL • June 7, 2026
Learn how NERC large loads affect grid reliability, data centers, power electronic loads, and interconnection planning. Discover key risks now.
Read More →
NERC Large Loads: 2026 Interconnection Guide
NERC Large Loads: 2026 Interconnection Guide
By SANDIP R PATEL • May 25, 2026
Explore NERC 2026 large load guidelines, interconnection requirements, and grid reliability insights. Learn how to comply and optimize large industrial loads.
Read More →
Category 2 IBR Compliance Services for Solar, Wind & BESS
Category 2 IBR Compliance Services for Solar, Wind & BESS
By SANDIP R PATEL • May 16, 2026
Category 2 IBR compliance services for solar, wind, and BESS projects. Learn NERC registration, EMT modeling, and PRC readiness today.
Read More →
NERC Draws the Line on Computational Load Risk: What You Need to Do Now
NERC Draws the Line on Computational Load Risk: What You Need to Do Now
By SANDIP R PATEL • May 8, 2026
Understand NERC large load compliance, EMT studies, and computational load modeling for AI data center reliability.
Read More →
The Complete Lifecycle of a Power Substation Project: From Design to Commissioning (A Keentel Engineering Technical Guide) Source Reference
The Complete Lifecycle of a Power Substation Project: From Design to Commissioning (A Keentel Engineering Technical Guide) Source Reference
By SANDIP R PATEL • April 19, 2026
Explore the full lifecycle of a power substation project with Keentel Engineering, covering design, construction, and commissioning. Learn more about AIS, GIS, and NERC compliance.
Read More →
NERC MOD-032-2, IBR & DER Modeling: What It Means for Grid Reliability—and How Keentel Engineering Leads Compliance
NERC MOD-032-2, IBR & DER Modeling: What It Means for Grid Reliability—and How Keentel Engineering Leads Compliance
By SANDIP R PATEL • April 18, 2026
Discover Keentel Engineering's expert solutions for NERC MOD-032-2 compliance, IBR & DER modeling. Get your power systems future-ready with our engineering excellence.
Read More →
MOD-026-2 Compliance Services: Verification & Validation of Dynamic Models for Grid Reliability
MOD-026-2 Compliance Services: Verification & Validation of Dynamic Models for Grid Reliability
By SANDIP R PATEL • April 7, 2026
Learn MOD-026-2 compliance requirements for dynamic model verification and validation of inverter-based resources, ensuring power system reliability and NERC compliance.
Read More →
NERC BAL-007-1 Explained: Near-Term Energy Reliability Assessments (ERA) and What It Means for Grid Operators & Developers
NERC BAL-007-1 Explained: Near-Term Energy Reliability Assessments (ERA) and What It Means for Grid Operators & Developers
By SANDIP R PATEL • April 3, 2026
Learn how NERC BAL-007-1 ensures energy adequacy, ERA methods, and proactive grid reliability strategies for utilities, developers & BAs.
Read More →
NERC Standards 2026–2029: BAL-007 IBR & CIP Compliance
NERC Standards 2026–2029: BAL-007 IBR & CIP Compliance
By SANDIP R PATEL • April 1, 2026
Explore upcoming NERC Reliability Standards (2026–2029), including BAL-007 energy assessments, IBR ride-through rules, cybersecurity (CIP-003-9), and extreme weather planning. Learn compliance strategies, risks, and real-world case studies.
Read More →
End-to-End Substation Equipment Validation: From Design Verification to Field Commissioning (FAT to SAT) | Keentel Engineering
End-to-End Substation Equipment Validation: From Design Verification to Field Commissioning (FAT to SAT) | Keentel Engineering
By SANDIP R PATEL • March 31, 2026
Learn the complete substation testing lifecycle including Type Testing, FAT, and SAT. Discover how to reduce risks, improve reliability, and ensure NERC compliance.
Read More →
NERC PRC-012-2 Compliance for Solar, Wind, and Battery Energy Storage Systems (BESS): What Generator Owners Must Know
NERC PRC-012-2 Compliance for Solar, Wind, and Battery Energy Storage Systems (BESS): What Generator Owners Must Know
By SANDIP R PATEL • March 7, 2026
Guide to NERC PRC-012-2 compliance for solar plants, wind farms, and BESS. Understand RAS requirements, generator owner obligations, and testing rules.
Read More →
FAC-008-5 Facility Ratings: NERC Compliance Services – Engineering Support for Reliable Bulk Power Systems | Keentel Engineering
FAC-008-5 Facility Ratings: NERC Compliance Services – Engineering Support for Reliable Bulk Power Systems | Keentel Engineering
By SANDIP R PATEL • March 5, 2026
Learn how FAC-008-5 defines Facility Ratings for BES equipment. Discover rating methodologies, compliance requirements, and engineering practices for NERC reliability standards.
Read More →
NERC Compliance Service for Substations
NERC Compliance Service for Substations
By SANDIP R PATEL • February 26, 2026
Ensure NERC compliance with proper programming of RTACs, DFRs, clocks, and protection devices. Learn how Keentel Engineering can help you meet PRC-028-1 standards for disturbance monitoring and reporting
Read More →
Advanced Substation SCADA Design Using the SEL-3555-2 RTAC How Keentel Engineering Delivers Secure, High-Performance, Standards-Compliant Automation Architectures
Advanced Substation SCADA Design Using the SEL-3555-2 RTAC How Keentel Engineering Delivers Secure, High-Performance, Standards-Compliant Automation Architectures
By SANDIP R PATEL • February 23, 2026
Explore advanced substation SCADA design using the SEL-3555-2 RTAC. Secure, IEC 61850-compliant, NERC-ready automation by Keentel Engineering.
Read More →
NERC Compliance and PRC Alignment with SEL-351S Feeder Protection Applications
NERC Compliance and PRC Alignment with SEL-351S Feeder Protection Applications
By SANDIP R PATEL • February 20, 2026
Learn how SEL-351S feeder protection relays support NERC PRC compliance including PRC-005, PRC-023, PRC-024, PRC-027, and PRC-029. Discover protection coordination, ride-through validation, maintenance programs, and audit-ready documentation for reliable power system protection.
Read More →
February 2026 NERC Event Calendar: Statistical & Strategic Breakdown
February 2026 NERC Event Calendar: Statistical & Strategic Breakdown
By SANDIP R PATEL • February 11, 2026
Explore the February 2026 NERC event calendar with insights on CIP cybersecurity, IBR reliability, Order 901 studies, cloud risk, and large load integration.
Read More →
FERC RM22-12-000; ORDER NO. 901 Explained: Engineering, Modeling, and Compliance Implications for the Bulk Power System
FERC RM22-12-000; ORDER NO. 901 Explained: Engineering, Modeling, and Compliance Implications for the Bulk Power System
By SANDIP R PATEL • February 1, 2026
Understand FERC RM22-12-000 Order 901 and its impact on power system modeling, NERC compliance, generator data, and protection standards.
Read More →
Inverter-Based Resource (IBR) Registration Initiative
Inverter-Based Resource (IBR) Registration Initiative
By SANDIP R PATEL • January 31, 2026
Learn what the IBR Registration Initiative means for Category 2 Generator Owners and Operators, key deadlines through May 2026, required documentation, and how Keentel Engineering supports NERC compliance readiness.
Read More →
PRC-029-1 Explained: Applicability, Key Dates, and What Generator Owners Must Do Now
PRC-029-1 Explained: Applicability, Key Dates, and What Generator Owners Must Do Now
By SANDIP R PATEL • January 31, 2026
Understand NERC PRC-029-1 ride-through requirements for IBRs, key compliance dates through 2026, applicability to BES and non-BES assets, and what Generator Owners must do now.
Read More →
Category 2 Inverter-Based Resource (IBR) Registration & Compliance
Category 2 Inverter-Based Resource (IBR) Registration & Compliance
By SANDIP R PATEL • January 31, 2026
Complete guide to Category 2 IBR registration and compliance, including NERC requirements, FERC Order 901, CMEP enforcement, applicable standards, and preparation steps.
Read More →
2025–2026 Winter Reliability Assessment: What It Means for Grid Reliability, Compliance, and Engineering Strategy
2025–2026 Winter Reliability Assessment: What It Means for Grid Reliability, Compliance, and Engineering Strategy
By SANDIP R PATEL • January 29, 2026
The 2025–2026 Winter Reliability Assessment highlights rising winter demand, resource mix shifts, and NERC compliance changes, impacting grid reliability and engineering.
Read More →
Upcoming NERC Reliability Standards (2026–2028) | IBR Compliance Guide
Upcoming NERC Reliability Standards (2026–2028) | IBR Compliance Guide
By SANDIP R PATEL • December 29, 2025
A practical guide to upcoming NERC Reliability Standards (2026–2028), key effective dates, and compliance readiness for inverter-based resource owners.
Read More →
Navigating NERC PRC-029-1: A Practical Guide for Inverter-Based Resource Owners
Navigating NERC PRC-029-1: A Practical Guide for Inverter-Based Resource Owners
December 19, 2025
A practical guide to NERC PRC-029-1 for inverter-based resource owners. Learn ride-through requirements, compliance timelines, exemptions, and how Keentel Engineering supports PRC-029-1 readiness.
Read More →
NERC Compliance Services: The Complete Guide to PRC-004-6 Misoperations & MIDAS Reporting
NERC Compliance Services: The Complete Guide to PRC-004-6 Misoperations & MIDAS Reporting
By SANDIP R PATEL • November 26, 2025
Learn how to stay compliant with NERC PRC-004-6 and MIDAS reporting. Keentel Engineering provides misoperation analysis, CAP support, and audit-ready documentation.
Read More →
NERC Compliance Services: The Complete Guide to PRC-004-6 Misoperations & MIDAS Reporting (Keentel Engineering)
NERC Compliance Services: The Complete Guide to PRC-004-6 Misoperations & MIDAS Reporting (Keentel Engineering)
By SANDIP R PATEL • November 15, 2025
Learn how PRC-004-6 misoperations and MIDAS reporting work. A complete NERC compliance guide from Keentel Engineering for utilities and power entities.
Read More →
PJM MOD-032 Data Submission Process for Generator and Transmission Owners | Keentel Engineering
PJM MOD-032 Data Submission Process for Generator and Transmission Owners | Keentel Engineering
By SANDIP R PATEL • October 30, 2025
Learn how Generator and Transmission Owners meet PJM MOD-032 data submission requirements using Gen Model, Model on Demand, and ASPEN tools for NERC compliance.
Read More →
Understanding Simultaneous Voltage-Sensitive Load Reductions Amid Industrial Electrification, Data Center Expansion, and the Rise of Cryptocurrency Mining Facilities
Understanding Simultaneous Voltage-Sensitive Load Reductions Amid Industrial Electrification, Data Center Expansion, and the Rise of Cryptocurrency Mining Facilities
By SANDIP R PATEL • October 19, 2025
Explore NERC’s 2025 review on simultaneous voltage-sensitive load reductions amid industrial electrification, data center growth, and crypto mining.
Read More →
Advancing Power System Design Practices with IEEE PES TR 126
Advancing Power System Design Practices with IEEE PES TR 126
By SANDIP R PATEL • September 25, 2025
Discover how IEEE PES TR 126 modernizes power system design practices. Keentel Engineering explains reliability, resilience, and NERC compliance for future-ready grids.
Read More →
NERC MOD-033-1 Steady-State & Dynamic Model Validation
NERC MOD-033-1 Steady-State & Dynamic Model Validation
By SANDIP R PATEL • September 13, 2025
Validate power-flow & dynamic models per MOD-033-1 using real-world data. Improve study accuracy, reliability, and compliance. Partner with Keentel.
Read More →
Excited to Connect at RE+ Las Vegas – Booth #1423- Keentel Engineering
Excited to Connect at RE+ Las Vegas – Booth #1423- Keentel Engineering
By SANDIP R PATEL • August 30, 2025
Join Keentel Engineering at RE+ 2025 in Las Vegas (Booth #1423), Sept 8–11. Explore renewable energy, BESS, substation design, NERC compliance, and advanced power system studies.
Read More →
Verification of Generator Models: NERC MOD-026-2 & MOD-027 Reliability Standards
Verification of Generator Models: NERC MOD-026-2 & MOD-027 Reliability Standards
By SANDIP R PATEL • August 25, 2025
Explore NERC MOD-026-2 & MOD-027 requirements for generator model verification, EMT simulations, and compliance. Insights from Keentel Engineering.
Read More →
Data Center Grid Readiness & Engineering Solutions
Data Center Grid Readiness & Engineering Solutions
By SANDIP R PATEL • August 15, 2025
Discover how Keentel Engineering tackles data center growth challenges with advanced grid readiness solutions—covering load forecasting, interconnection, NERC compliance, and AI-driven demand response.
Read More →
Navigating PRC-029-1- Enhancing Grid Reliability Through Inverter-Based Ride-Through Requirements
Navigating PRC-029-1- Enhancing Grid Reliability Through Inverter-Based Ride-Through Requirements
By SANDIP R PATEL • July 31, 2025
Understand PRC-029-1 ride-through rules for IBRs. Stay NERC-compliant with this expert guide on voltage, frequency, ROCOF, and protection updates.
Read More →
NERC PRC-019 Compliance Guide
NERC PRC-019 Compliance Guide
By SANDIP R PATEL • July 28, 2025
Ensure grid reliability and avoid unnecessary trips with Keentel’s complete PRC-019 compliance services. Engineering support for synchronous and DER systems.
Read More →
NERC Alert 3: IBR Performance & Modeling Requirements
NERC Alert 3: IBR Performance & Modeling Requirements
By SANDIP R PATEL • July 4, 2025
Explore essential NERC Alert 3 actions for IBRs. Learn how TOs, TPs, PCs & GOs must respond with updated models, criteria, and compliance strategies.
Read More →
Keentel Engineering – July 2025 Newsletter
Keentel Engineering – July 2025 Newsletter
By SANDIP R PATEL • July 1, 2025
Explore July 2025 grid reliability trends, IBR registration mandates, and NERC compliance updates. Stay ahead with Keentel’s future-ready engineering insights.
Read More →
PLX82-MNET-61850 Gateway for NERC-Compliant Substations
PLX82-MNET-61850 Gateway for NERC-Compliant Substations
By SANDIP R PATEL • June 26, 2025
Enable seamless Modbus to IEC 61850 integration with the PLX82-MNET-61850 gateway. Achieve NERC compliance with audit-ready substation communication.
Read More →
Enhancing Grid Resilience: NERC PRC-029-1 Ride-Through Requirements for Inverter-Based Resources
Enhancing Grid Resilience: NERC PRC-029-1 Ride-Through Requirements for Inverter-Based Resources
By SANDIP R PATEL • June 20, 2025
Explore NERC PRC-029-1 ride-through requirements for inverter-based resources (IBRs). Learn how it enhances grid reliability with FERC Order No. 901 support.
Read More →
Empowering NERC PRC-028 Compliance with TESLA 4000: A Keentel Engineering Perspective
Empowering NERC PRC-028 Compliance with TESLA 4000: A Keentel Engineering Perspective
By SANDIP R PATEL • June 19, 2025
Ensure NERC PRC-028 compliance with TESLA 4000 and Keentel Engineering’s expert integration, monitoring, and audit support services for utilities and GOs.
Read More →
PRC-026 Compliance Guide for Transmission Relay Performance During Stable Power Swings
PRC-026 Compliance Guide for Transmission Relay Performance During Stable Power Swings
By SANDIP R PATEL • June 13, 2025
Ensure your relays don’t trip during stable power swings. Learn how PRC-026 compliance works, what relays it applies to, and how to automate your evaluations.
Read More →
NERC.com Modernization: What Engineers and Grid Operators Need to Know
NERC.com Modernization: What Engineers and Grid Operators Need to Know
By SANDIP R PATEL • May 30, 2025
Explore the latest updates from NERC.com and what modernization means for power engineers and grid operators across the U.S.
Read More →
Design Stability & NERC Deadlines in Power Projects | Keentel
Design Stability & NERC Deadlines in Power Projects | Keentel
By SANDIP R PATEL • May 30, 2025
Explore best practices to ensure design stability in power systems and stay ahead of NERC reporting requirements in upcoming compliance cycles.
Read More →
NERC Level 3 Alert Compliance Checklist for IBRs
NERC Level 3 Alert Compliance Checklist for IBRs
By SANDIP R PATEL • May 23, 2025
Get your compliance checklist for NERC Level 3 alerts. Essential reading for IBR generator owners navigating updated NERC requirements.
Read More →
System Impact Study for Confidential 230 kV Transmission Interconnection
System Impact Study for Confidential 230 kV Transmission Interconnection
By SANDIP R PATEL • May 21, 2025
Explore a detailed System Impact Study for a 230 kV interconnection project, ensuring NERC compliance and reliable grid integration.
Read More →
Industry NERC News – May 2025 Update
Industry NERC News – May 2025 Update
By SANDIP R PATEL • May 19, 2025
Stay ahead of critical NERC compliance updates for May 2025, including cold weather reporting, IBR modeling deficiencies, active standards ballots, and upcoming reliability standards affecting the Bulk Power System.
Read More →
GIC Mitigation and Transformer Thermal Assessment Services by Keentel Engineering
GIC Mitigation and Transformer Thermal Assessment Services by Keentel Engineering
By SANDIP R PATEL • May 15, 2025
Protect your grid from GMD threats with expert GIC modeling & transformer thermal assessments by Keentel. Ensure NERC TPL-007-1 compliance today.
Read More →
NERC Alert: Ensuring Reliability in Inverter-Based Resource (IBR) Model Quality
NERC Alert: Ensuring Reliability in Inverter-Based Resource (IBR) Model Quality
By SANDIP R PATEL • May 14, 2025
Learn how to respond to NERC’s IBR model alert. Discover key steps for PSPD, EMT validation, deadlines, and Keentel’s role in grid reliability compliance support.
Read More →
Navigating TPL-008-1: A Strategic Transmission Planning Guide for Extreme Temperatures
Navigating TPL-008-1: A Strategic Transmission Planning Guide for Extreme Temperatures
By SANDIP R PATEL • May 14, 2025
Understand TPL-008-1 transmission planning for heat & cold events. Keentel helps utilities ensure NERC compliance with benchmark studies & CAP support.
Read More →
Navigating the IBR Transformation: Our Perspective on NERC’s IBR Activities
Navigating the IBR Transformation: Our Perspective on NERC’s IBR Activities
By SANDIP R PATEL • May 12, 2025
Explore Keentel Engineering’s in-depth take on NERC’s IBR transformation guide, disturbance reports, compliance standards, and integration strategies to ensure bulk power system reliability.
Read More →
Generating Unit Winter Weather Readiness: Ensuring Resilience Through Cold Fronts
Generating Unit Winter Weather Readiness: Ensuring Resilience Through Cold Fronts
By SANDIP R PATEL • May 10, 2025
Ensure cold-weather resilience with Keentel’s NERC-aligned winter readiness programs for generators and IBRs. Prevent outages, improve grid reliability.
Read More →
White Paper: Enhancing Power System Design & Analysis with PSCAD & Keentel Engineering
White Paper: Enhancing Power System Design & Analysis with PSCAD & Keentel Engineering
By SANDIP R PATEL • May 9, 2025
Learn what PSCAD is, how it’s used for EMT simulation, and how Keentel provides PSCAD modeling, consultancy, and NERC-compliant engineering services.
Read More →
Keentel Engineering Insights: NERC Identifies New Grid Vulnerabilities – May 2025 Newsletter
Keentel Engineering Insights: NERC Identifies New Grid Vulnerabilities – May 2025 Newsletter
By SANDIP R PATEL • May 9, 2025
Stay informed on NERC’s ITCS Canadian Analysis, key grid vulnerabilities, and May 2025 standards activities (PRC, MOD, CIP). Learn how Keentel Engineering’s planning and compliance services support resilient, interregional grid strategies.
Read More →
Difference Between OSHA, NEC, NFPA, and NERC Compliance in Electrical Engineering
Difference Between OSHA, NEC, NFPA, and NERC Compliance in Electrical Engineering
By SANDIP R PATEL • May 9, 2025
Discover the key differences between OSHA, NEC (NFPA 70), NFPA, and NERC standards—and learn how Keentel Engineering ensures full regulatory compliance across your electrical engineering projects.
Read More →
What Do PRC-002-5 and PRC-028-1 Mean for Generator Owners & Transmission Owners?
What Do PRC-002-5 and PRC-028-1 Mean for Generator Owners & Transmission Owners?
By SANDIP R PATEL • May 9, 2025
Discover how NERC PRC-002-5 & PRC-028-1 impact Generator Owners and Transmission Owners. Keentel Engineering delivers turnkey disturbance monitoring, DME design, and audit-ready compliance support.
Read More →
NERC Compliance Service – Empowering Grid Reliability with FERC Order 901 & Latest NERC Standards
NERC Compliance Service – Empowering Grid Reliability with FERC Order 901 & Latest NERC Standards
By SANDIP R PATEL • May 9, 2025
Stay ahead with Keentel's NERC compliance modeling, FERC Order 901 support, MOD-032-2 validation, and MOD-026-2 compliance services for IBRs and transmission owners.
Read More →
ERCOT NERC Compliance Services: Ensuring Grid Reliability Through Expert Compliance Management
ERCOT NERC Compliance Services: Ensuring Grid Reliability Through Expert Compliance Management
By SANDIP R PATEL • May 8, 2025
Master ERCOT’s unique NERC reliability requirements with Keentel Engineering’s tailored CIP, O&P, and RSAW support—risk assessments, mock audits, training, and real-time monitoring.
Read More →
NERC PRC-029-1 Compliance for Inverter-Based Resources
NERC PRC-029-1 Compliance for Inverter-Based Resources
By SANDIP R PATEL • May 8, 2025
Ensure your solar, wind & BESS projects meet NERC PRC-029-1 ride-through standards with model tuning, relay coordination, disturbance analysis & audit-ready documentation.
Read More →
Distribution vs Sub-Transmission vs Bulk Electric System: An Interconnection Guide
Distribution vs Sub-Transmission vs Bulk Electric System: An Interconnection Guide
By SANDIP R PATEL • May 1, 2025
Learn how IEEE 1547/2800, NERC “bright-line” rules, and the DOE i2X initiative shape distribution, sub-transmission, and Bulk Electric System classification—plus practical case studies from Keentel Engineering.
Read More →
NERC PRC-029-1 & PRC-024-4 Compliance for Inverter-Based & Synchronous Resources
NERC PRC-029-1 & PRC-024-4 Compliance for Inverter-Based & Synchronous Resources
By SANDIP R PATEL • May 1, 2025
Ensure NERC PRC-029-1 and PRC-024-4 compliance with Keentel Engineering's relay tuning, modeling support, and ride-through requirements for IBRs and synchronous generators.
Read More →
Power-System Modeling Services at Keentel Engineering
Power-System Modeling Services at Keentel Engineering
By SANDIP R PATEL • April 28, 2025
Expert power system modeling services using PSCAD, PSSE, and ETAP. Get accurate simulations, dynamic studies, and NERC-compliant engineering solutions.
Read More →
GIC Mitigation and Transformer Thermal Assessment Expertise at Keentel Engineering
GIC Mitigation and Transformer Thermal Assessment Expertise at Keentel Engineering
By SANDIP R PATEL • April 26, 2025
Protect your grid assets with Keentel Engineering’s expert GIC mitigation and transformer thermal assessment services. Ensure NERC TPL-007-1 compliance today.
Read More →
PSCAD Modeling Services for Grid & Substations
PSCAD Modeling Services for Grid & Substations
By SANDIP R PATEL • April 25, 2025
Explore how Keentel Engineering uses PSCAD™ to model substations, inverters, protection schemes, and BESS systems. Ensure NERC & IEEE compliance today.
Read More →
Ensuring Grid Reliability with EMT Modeling Compliance – CAISO Requirements
Ensuring Grid Reliability with EMT Modeling Compliance – CAISO Requirements
By SANDIP R PATEL • April 23, 2025
Discover how Keentel Engineering helps energy developers meet CAISO EMT modeling compliance for inverter-based resources, BESS, and synchronous generators. PSCAD-based, NERC-aligned, and ready for submission.
Read More →
Ensuring NERC PRC-029-1 Compliance for Inverter-Based Resources (IBRs)
Ensuring NERC PRC-029-1 Compliance for Inverter-Based Resources (IBRs)
By SANDIP R PATEL • April 15, 2025
Ensure PRC-029-1 compliance for inverter-based resources. Keentel provides ride-through studies, system modeling, and NERC audit support. Contact Us!
Read More →
Why NERC Compliance Consultants Are Critical for Safety
Why NERC Compliance Consultants Are Critical for Safety
By SANDIP R PATEL • January 30, 2025
Discover why NERC compliance consultants are essential for safety. Learn how they help ensure regulatory adherence and protect power system reliability
Read More →
How to Ensure Compliance with NERC O&P Standards
How to Ensure Compliance with NERC O&P Standards
By SANDIP R PATEL • January 29, 2025
Learn how to ensure compliance with NERC O&P standards. Discover key requirements and best practices to maintain reliability in power system operations
Read More →
What Is the Difference Between FERC and NERC?
What Is the Difference Between FERC and NERC?
By SANDIP R PATEL • November 23, 2024
Learn the key differences between FERC and NERC: FERC regulates energy markets, while NERC ensures the reliability of the electric grid.
Read More →
How Many NERC Standards Are There?
How Many NERC Standards Are There?
By SANDIP R PATEL • November 10, 2024
Discover the current number of NERC standards and their importance in ensuring electric grid reliability and security across North America
Read More →
Ensuring Grid Reliability: How NERC O&P 693 Compliance Services Benefit the Energy Sector
Ensuring Grid Reliability: How NERC O&P 693 Compliance Services Benefit the Energy Sector
By SANDIP R PATEL • March 18, 2024
Ensure grid stability with Keentel's NERC compliance services. Contact us today for tailored solutions and a resilient energy future.
Read More →
Essential Steps for Commissioning Circuit Breakers
Essential Steps for Commissioning Circuit Breakers
By SANDIP R PATEL • April 1, 2023
Learn the essential steps for commissioning circuit breakers, from wiring checks to high-voltage testing. Ensure safety, reliability & NERC compliance readiness.
Read More →
Gap Analysis Explained: NERC CIP Risk Assessment & Cybersecurity Compliance
Gap Analysis Explained: NERC CIP Risk Assessment & Cybersecurity Compliance
By SANDIP R PATEL • January 17, 2022
Learn how NERC CIP gap analysis identifies cybersecurity risks, ensures compliance, and protects bulk power systems. Schedule your risk assessment
Read More →
